EXECUTIVE SUMMARY

BACKGROUND

Since 1990, a number of transportation agencies (as owners, sponsors, or contracting agencies of highway projects) have been experimenting with a wide variety of innovative project delivery strategies aimed at lowering the costs and time to produce highway construction and rehabilitation projects, while maintaining or improving project quality. One of these strategies is design-build (D-B) project delivery. Design-build is a method of project delivery in which the design and construction phases of a project are combined into one contract, usually awarded on either a low bid or best-value basis. This is in marked contrast to the more traditional design-bid-build (D-B-B) approach used in transportation agencies that outsource project design work, in which two different contracting efforts must be undertaken in sequence to procure architecture/engineering services on a negotiated-price basis and construction services on a lowest-responsible-bid price basis.

Exhibit 1 displays different types of project delivery approaches that combine various phases of the project life cycle. Many of these project delivery approaches extend far beyond the scope of design-build contracting by placing increasing functional responsibilities for highway infrastructure under a single contract vehicle.

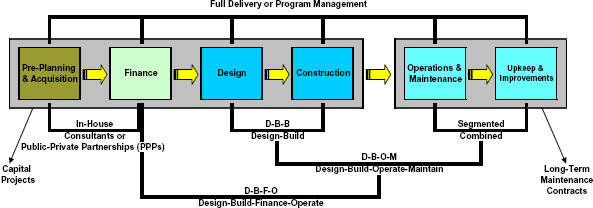

Exhibit 1: Alternative Contractual Arrangements for Delivering Highway Infrastructure

This exhibit shows alternative contractual arrangements for delivering highway infrastructure. It depicts how services typically delivered under the traditional project delivery process can be combined in letting integrated multiple-service type contracts. The services include: pre-planning & acquisition, finance, design, construction, operations & maintenance, and upkeep and improvement. Design-build contracts combine design and construction. Design-build-operate-maintain contracts combine design, construction, operations and maintenance. Design-build-finance-operate- contracts combine design, construction, operations and finance. There are many combinations of integrated service contracts that can be used.

Source: Pakkala, Pekka. Innovative Project Delivery Methods for Infrastructure - An International Perspective. Finnish Road Enterprise, Helsinki, 2002, p. 32.

In 1990, Special Experimental Project Number 14 (SEP-14) - Innovative Contracting, was established by the Federal Highway Administration (FHWA) to enable state transportation agencies (STAs) to test and evaluate a variety of alternative project contracting methods that provided the potential to expedite highway projects in a more cost-effective manner, without jeopardizing product quality or contractor profitability. One of these methods was design-build, which remains a core element of SEP-14. Between 1990 and 2002, about 300 projects representing $14 billion were proposed for design-build contracting under SEP-14 by transportation agencies in 32 states, the District of Columbia, and the Virgin Islands. Of this total, 140 projects representing $5.5 billion were completed by the end of 2002. Exhibit 2 shows the total number of design-build projects proposed, active, or completed by each of the states participating in the SEP-14 program.

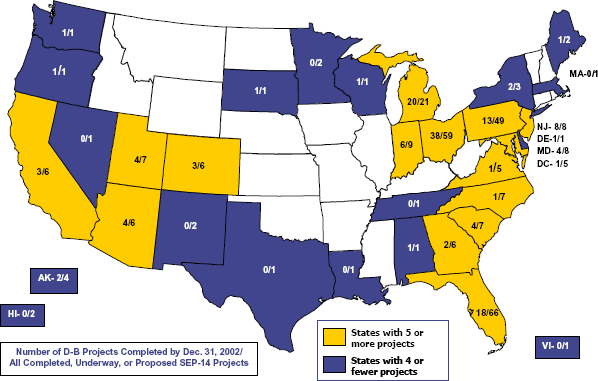

Exhibit 2: SEP-14 Design-Build Projects by State
(total and those completed by December 31, 2002 by STAs, toll agencies, or local public agencies)

This US map shows the number of State DOT or local public agency SEP-14 design-build projects completed by December 31, 2003 and the total number of SEP-14 projects proposed, underway or completed by each state. The first number is the number of completed projects; the second number is the total number of SEP-14 design-build projects in each state. Alabama 1/1, Alaska 2/4, Arizona 4/6, California 3/6, Colorado 3/6, Delaware 1/1, District of Columbia 1/5, Florida 18/66, Georgia 2/6, Hawaii 0/2, Indiana 6/9, Louisiana 0/1, Maine 1/2, Maryland 4/8, Massachusetts 0/1, Michigan 20/21, Minnesota 0/2, Nevada 0/1, New Jersey 8/8, New Mexico 0/2, New York 2/3, North Carolina 1/7, Ohio 38/59, Oregon 1/1, Pennsylvania 13/49, South Carolina 4/7, South Dakota 1/1, Tennessee 0/1, Texas 0/1, Utah 4/7, Virginia 1/5, Washington 1/1, Wisconsin 1/1, Virgin Islands 0/1.

Source: Design-Build Projects Approved Under SEP-14, Federal Highway Administration, July 2003

DESIGN-BUILD CONTRACTING FINAL RULE

In 1998, the Transportation Equity Act for the 21st Century (TEA-21) became the new authorization legislation for the nation's surface transportation programs. Included in TEA-21 was Section 1307 (c), which required FHWA to develop and issue regulations describing the Agency's approval criteria and procedures. The Design-Build Contracting: Final Rule was published in the Federal Register on December 10, 2002 and became effective on January 9, 2003.1

The following lists the most salient parts of FHWA's Design-Build Contracting Final Rule for consideration by both representatives of transportation agencies and firms interested in proposing on prospective projects using the design-build contracting approach:

STUDY RATIONALE AND FOCUS

Section 1307 (f) of TEA-21 required that a comprehensive national study be conducted to evaluate the effectiveness of design-build contracting, with the results subsequently reported to Congress. The five objectives specified in Section 1307 (f) for this study included the following:

  1. Assess the effect of design-build contracting on project quality, cost, and timeliness;
  2. Recommend the appropriate level of design for design-build procurements;
  3. Assess the impact of design-build contracting on small businesses;
  4. Assess the subjectivity used in design-build contracting; and
  5. Recommend actions and changes to design-build contracting procedures.

This study focuses on completed design-build projects authorized under SEP-14. This is the first comprehensive study of the SEP-14 Program involving both program and project managers who have been directly responsible for Federal-aid highway projects delivered under the design-build contracting approach. Its findings and conclusions are based on the results of an extensive literature search, interviews with key stakeholders involved in the Federal-aid highway program and SEP-14, and an integrated set of surveys of transportation agency personnel responsible for design-build programs and projects developed under SEP-14.

RESULTS OF PRIOR STUDIES

This is not the first study of performance issues resulting from the application of design-build contracting to infrastructure projects. In the past ten years, a number of domestic and international studies have sought to determine how innovations in project delivery affect projects built by the private sector, defense agencies, and public infrastructure agencies. The following summarizes the key findings and conclusions from these prior studies:

SUITABILITY OF DESIGN-BUILD PROJECT DELIVERY

Projects of many sizes and complexities have used design-build project delivery over the years since the inception of the SEP-14 Innovative Contracting program. However, the overwhelming majority of SEP-14 program costs have been for projects over $100 million in cost. This reflects the perceptions of design-build program managers surveyed for this study who rated the following project types as most suitable for design-build project delivery:

Least suitable among the project types was road resurfacing. The suitability rating for design-build contracting was highly correlated to the size of the project, wherein the suitability rating more than doubled when going from small projects to mega projects (projects over $100 million).

IMPACTS OF DESIGN-BUILD ON PROJECT DURATION, COST, AND QUALITY

On average, the managers of design-build projects surveyed in the study estimated that design-build project delivery reduced the overall duration of their projects by 14 percent, reduced the total cost of the projects by 3 percent, and maintained the same level of quality as compared to design-bid-build project delivery, as shown in Exhibit 3.

Exhibit 3: Summary of Estimated Impacts of Using Design-Build on Project Duration, Cost, and Quality

Duration DimensionValueCost DimensionValueQuality DimensionValue
Responses62Responses48Responses61
Average-14.1%Average-2.6%Average0.0%
Median-10.0%Median0.0%Median0.0%
Mode-0.1%Mode0.0%Mode.0%
Maximum50.0%Maximum65.0%Maximum10.0%
Minimum-63.0%Minimum-61.8%Minimum-10.0%
Standard Deviation24.4%Standard Deviation20.5%Standard Deviation2.1%

Source: D-B project survey: Q18, 45-60 responses

Impacts on Project Duration

Actual data for the surveyed design-build projects indicated an average drop of 1 percent between planned and actual total project duration. A comparison between the survey results for a subset of design-build projects and similar design-bid-build projects showed a 9 percent difference in total project duration and a 13-percent difference in construction phase duration between the two types of project delivery approaches, with the design-build projects having the shorter durations. Program survey respondents perceived that design-build projects take more time to set up and procure, but once awarded, require less time for the contracting agency to administer in comparison to similar design-bid-build projects.

The results of the program and project surveys, including both project manager estimates and actual project documentation, supported the claim that the design-build approach can reduce the overall duration of a project, in certain cases significantly. Despite wide variations in changes to project duration among the surveyed design-build and design-bid-build projects, particularly for the construction phase, the results revealed that longer than planned contract development and evaluation timeframes and potentially longer construction timeframes could be more than offset by certain features of the design-build process.

These features included the following:

Exhibit 4 illustrates the general sequence of project development activities for both design-build and design-bid-build contracts. The two schedules demonstrate how the type of project delivery approach may influence the sequencing and duration of standard highway project development phases. The key feature that distinguishes these two project delivery approaches is the placement of design functions relative to the construction functions and the potential for overlap between the design and construction phases for the design-build approach.

Impacts on Project Cost

The project survey results revealed that design-build project delivery, in comparison to design-bid-build, had a mixed impact on project cost depending on the project type, complexity, and size. The surveyed design-build project managers indicated that project delivery approach (i.e., design-build versus design-bid-build) can be a contributing factor in controlling and potentially reducing project costs. However, project delivery approach was perceived to be less of a factor in affecting project cost than other characteristics of the project or its participants.

When project cost information was used from the project surveys, the design-build projects experienced no appreciable change in total cost due to off-setting cost increases and cost decreases among the project sample surveyed, which both vary widely. When cost information was used from a subset of similar design-build and design-bid-build projects, the design-bid-build projects demonstrated more favorable cost results.

Exhibit 4: Sequence of Project Delivery Activities by Contract Approach

This schematic diagram shows the sequence of project delivery activities for both the traditional design-bid-build method and the design-build method. The overlap in the final design and construction phases for design-build provides the potential for shortened project delivery times.

Source: Dr. Keith Molenaar, University of Colorado at Boulder

Project costs experienced most growth from contract award to project completion. Respondents to the design-build project survey indicated that the leading cause of project cost changes was change orders: owner required additions or subtractions and design-builder or contractor suggested additions or subtractions. This was true for both project delivery approaches, with design-build projects being significantly more sensitive to delays, additions, or subtractions caused by third parties than design-bid-build projects.

Change orders represented 5 percent of the total costs for the surveyed projects. Claims represented less than one-tenth of one-percent of total project costs. The subset of design-build projects had fewer change orders than the comparable design-bid-build projects, but the average cost per change order was greater for the design-build projects. This can be attributed to the greater size of design-build projects. This was confirmed by the fact that change orders represented about the same share of total project costs for both design-build and design-bid-build projects. In contrast, the dollar value of claims per project was significantly lower for design-build projects than for comparable design-bid-build projects, with the subset of design-build projects having no reported cost of claims.

Impacts on Project Quality

Contracting agency satisfaction with the outcome and process of project delivery is one of the primary ways to measure the quality of different approaches. Project survey respondents expressed a high level of satisfaction with design-build projects, including compliance with warranty provisions and conformance with standards and specifications. Based on a detailed statistical analysis of project survey responses, the research team discovered that overall contracting agency satisfaction was highly correlated with the following project characteristics:

The results of this analysis are summarized in Exhibit 5.

Exhibit 5: Overall Contracting Agency Satisfaction by Project and Contract Type

Project/Contract CharacteristicOverall Sponsor Satisfaction
LowerHigher
Procurement MethodLow BidBest Value
Project TypeRoad-Resurface/RenewalRoad-New/Widen and Rehabilitate/Reconstruct
Project SizeSmallerLarger
% of Design Completed at AwardHigherLower

Source: D-B project survey: Q2, Q4, Q10, and Q17; 69 responses

When a subset of 19 design-build projects was compared to similar design-bid-build projects, the survey results indicated that overall contracting agency satisfaction with design-build projects was on a par with design-bid-build projects. However, conformance with warranty provisions and standards and specifications were both rated higher for design-build projects than for similar design-bid-build projects.

OTHER DESIGN-BUILD CONTRACTING ISSUES

There are a number of additional issues relating to the use of design-build contracts that can impact the relative risk to the public and private sector participants in the contract and the opportunity to apply more cost-effective approaches to accomplishing the objectives of the project. These are discussed below.

Appropriate Level of Preliminary Design

Among the design-build projects surveyed for this study, design averaged 27 percent complete prior to design-build contract award. For 81 percent of the reported projects, the percentage of design completion by design-build contract award was 30 percent or less. For the subset of design-build projects surveyed, the average percent design completion prior to going to a design-build contract was 37 percent, with 78 percent of the projects at 30 percent or less. An earlier survey of six STAs using design-build found a broad range for the level of preliminary design completed before issuing requests for bids of proposals for design-build projects.2 The range was 15 percent to 50 percent, with the average among the six agencies being 31 percent.

These results are consistent with the finding in Exhibit 5 that the level of contracting agency satisfaction reported for design-build projects was higher for lower levels of preliminary design completed before design-build contract award. This can be attributed the design-builder's ability to influence the project design earlier in the process to promote its constructability and cost-effectiveness. While each project should be considered on an individual basis, the results suggest that no more than 30 percent of preliminary design be completed before design-build contract award, with lower percentages as the contracting agency gains more experience with design-build contracting and greater reliance is placed on performance-based specifications.

Impacts on Small Business

The advent of design-build project delivery has raised concerns by some that small firms3 may be unable to participate on design-build teams, particularly as the design-build team lead or prime contractor, due to the increased functional scope and scale of many design-build contracts, more stringent qualification requirements, and/or higher bonding requirements. In some cases, contracting agencies have applied design-build to smaller projects to address these and other issues. In the context of this report, small business participation includes the involvement of smaller firms in design-build projects as a prime contractor, joint venture partner, or subcontractor.

Agency respondents to the design-build program survey indicate that the percentage of design-build project costs going to small businesses was about the same on average as for design-bid-build projects, with only a very small reduction indicated for design-build projects. These results suggest that small businesses were not disadvantaged when projects were developed through the design-build process, according to agency design-build program managers.

The survey results also indicated that design-build contracts spread more of the design work among subconsultants than comparable design-bid-build contracts, which should be a positive feature for small business enterprises.

Subjectivity in Contracting

The survey results suggested that while project urgency and innovation were the primary motivators for using design-build contracting, cost remained the primary factor for awarding design-build contracts, even when other factors such as duration, team reputation, and quality were included in the deliberations. In addition, low bid continued to play an important role in contract award decisions, with best-value approaches using multiple criteria including cost gaining momentum.

Since design-build includes a significant design element, it is important to include these other factors as is the case when purely design proposals are selected (which by law cannot be based solely on cost or low bid). Best value selection methods provide for the consideration of both cost and other, more subjective, factors such as project management, quality control, and team reputation. Best value is gaining popularity among contracting agencies of design-build projects due to its ability to consider all relevant factors that affect the desirability of a design-build bid.

AGENCY SUGGESTIONS FOR IMPROVING DESIGN-BUILD PROGRAMS

The project managers who completed design-build project surveys noted many lessons learned from these projects. Key lessons included:

They also identified various changes their agencies have undertaken or plan to make to improve the effectiveness of their design-build programs. Changes include amending quality assurance and quality control, better defining program guidelines, and working more closely with design and construction contractors to craft a better program. Several agencies also reported that their design-build programs were being reassessed on an on-going basis as projects moved through the process. Suggestions for further improving the design-build process included:

CONCLUSIONS

Based upon the results of this study, the following conclusions are offered regarding the future disposition of design-build as an alternative method for delivering highway projects, relative to the areas of interest defined by Section 1307 (f) of TEA-21, which mandated this study:

Impacts on Project Timeliness

Impacts on Project Cost

Impacts on Project Quality

Level of Design Completed Prior to Design-Build Contract

Impacts on Small Business

Subjectivity of Design-Build Contracting

Other Considerations

RECOMMENDATIONS

Based upon the results of this study, the following recommendations are offered to improve the use of design-build for delivering highway projects.

CLOSING REMARKS

The changing nature of the nation's highway development program and resources, at the federal, state, and local levels, is placing increasing burdens on the public sector's ability to meet the growing needs for renewed and expanded system capacity. Innovative techniques like design-build have been shown to offer the potential to help transportation agencies better serve these needs by doing things faster and more cost-effectively. While many of the conditions that spawned the promulgation of highly restrictive contracting laws and procedures early in the twentieth century are no longer in evidence, care must be taken to prevent a repeat of these conditions. This is why use of techniques like design-build contracting must be viewed and entered into with the understanding that the public and private participants in the process have a shared interest and liability for the process results, and are each held accountable for the results.

Design-build contracting represents a collaborative effort that integrates the various resources involved in the development of a highway project and provides incentives for a high level of technical performance and consistency with contractual budget and schedule terms. It has the potential to produce a more cost-effective project in less time than a process that contractually insulates the project participants while leaving the contracting agency with most of the project risk. The following quotes reflect the views of many of the respondents to the design-build surveys:
