Case Study Snapshot #3

Responding to Public Concern about Delays during Bridge Repairs

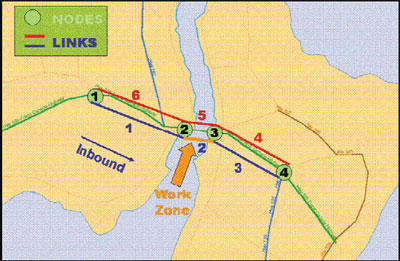

Map of roads in their approach to Little Brass d'Or bridge in Nova Scotia.

In the spring of 2001, a major structural rehabilitation project started on the Little Bras d’Or bridge in Nova Scotia, Canada. Built in 1959, the bridge consists of 1.2 meter by 30.4 meter (4 feet by 100 feet) steel girder spans and carries a two-lane, twoway highway. It was necessary to close one lane to perform repairs. Traffic flow was controlled by signals, and later, during peak traffic flow hours, by flaggers. As the project progressed into late spring, traffic volumes increased and motorists began to experience significant delays. Local residents, businesses, politicians, and emergency services were very vocal about the delays. Political pressure forced rescheduling the work for November of that year. In anticipation of the November bridge work, the Province’s transportation engineer started looking for tools to help predict the impact of the proposed closure to make objective decisions on when work could take place. QuickZone was used to analyze various staging scenarios. First, a baseline model was validated for queues and delays observed during the spring 2001 roadwork.

QuickZone demonstrated that the planned move to November using the same traffic control would still result in unacceptable delays. Due to the QuickZone analysis and political issues, project completion was further delayed. Basic repairs were made to keep the bridge safely open until a better traffic control solution could be identified. In 2004, the initial analysis performed at this site was updated for a milling and repaving project on the same section of the highway. Estimates of capacity loss were updated based upon observations made at other sites. QuickZone was used to support the decision to do the work at night and also to define allowable nighttime work hours. It is anticipated that the structural repairs started in 2001 will resume and be completed in 2005 using an alternative traffic control plan.

KEY OBSERVATIONS

QUICKZONE

Deborah Curtis
Federal Highway Administration (FHWA)
Operations, Research and Development
Integrated Product Team
202–493–3267
deborah.curtis@fhwa.dot.gov

CASE STUDY

Gerard Kennedy, P. E.
Project Engineer
Nova Scotia Department of Transportation and Public Works
902–563–2518
kennedge@gov.ns.ca

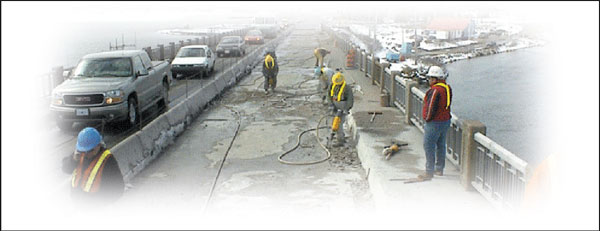

Workmen using jackhammers on a closed lane on a bridge with traffic moving by in a single lane beside them.
