Mobile Source Air Toxic (MSAT) Analysis Case Study: Northwest Corridor in Atlanta, Georgia

FHWA-HEP-16-067

Also available as Adobe PDF (611 KB)

1.0 Description and Overview of Proposed Project

The Georgia Department of Transportation (GDOT) identified that transportation improvements were needed to respond to concerns over growth in travel demand on Interstate 75 (I-75) and Interstate 575 (I-575), northwest of downtown Atlanta. The Northwest Corridor (NWC) project was designed to address these concerns related to transportation capacity deficiencies, as well as to provide additional transportation choices, improve mobility and connectivity between activity centers, and reduce single-occupancy vehicle travel while avoiding or minimizing adverse environmental impacts.

Figure 1 illustrates the project area. I-75 is the main freeway serving the Northwest Corridor of Atlanta. It is the primary route for commuters traveling to jobs within the region and to downtown Atlanta. As a major north-south route through Georgia, I-75 also serves the transportation needs for regional travel and freight trucking. I-75 merges with I-85 through downtown Atlanta. Between I-85 and I-285, I-75 is 10 lanes, with four general purpose lanes and a high-occupancy vehicle (HOV) lane in each direction. The existing HOV system ends at Akers Mill Road just south of I-285.

Under the Selected Alternative, two new reversible managed lanes will be constructed on I-75 between I-285 and the I-75/I-575 interchange. A single reversible managed lane will continue north on I-75 from the I-75/I-575 interchange to Hickory Grove Road. Similarly, a single reversible managed lane will continue north on I-575 from the I-75/I-575 interchange to a point south of the Sixes Road interchange. The length of the managed lane segment on I-75 is approximately 17 miles, and approximately 11 miles on I-575. Connecting the I-75 managed lanes to I-285 will require approximately 2 miles of construction on I-285 for a total project length of approximately 30 miles. The new managed lanes south of the I-75/I-575 interchange will be designed for highway speeds of 55 mph, while the new managed lanes north of the I-75/I-575 interchange will be designed for highway speeds of 65 mph.

GDOT prepared a Final Environmental Impact Statement (FEIS) for this project to fulfill requirements of the National Environmental Policy Act (NEPA) and State review process in October 2011, followed by an FEIS Reevaluation in March 2013. This project was approved by Federal Highway Administration (FHWA) with a Record of Decision signed on May 23, 2013. A further reevaluation of this project was conducted by GDOT in 2014, with FHWA approval on September 16, 2014. (GDOT 2014). A 2014 reevaluation of the project included. Additional environmental reevaluations of this project have occurred since the approval of the 2014 reevaluation. (GDOT 2016).

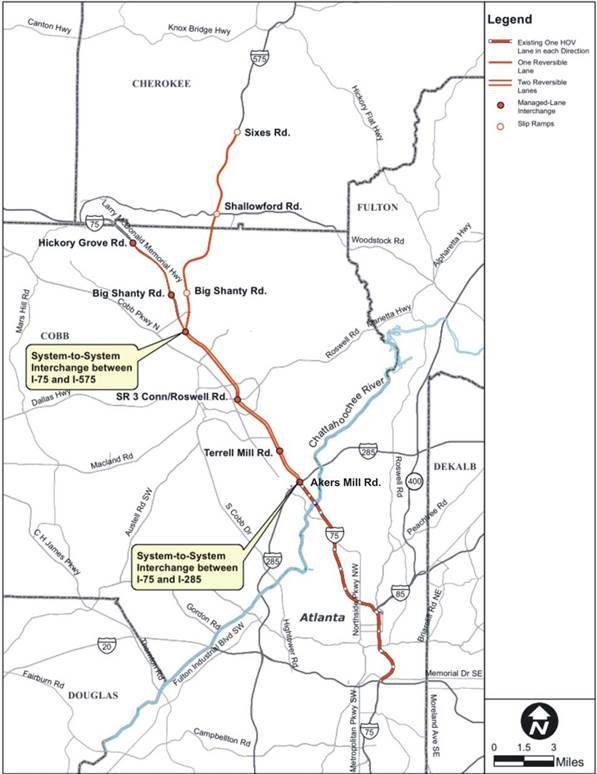

This map shows major roads north and west of downtown Atlanta. Project improvements along Interstates 75 and 575, including interchanges and reversible lanes, are indicated.

Source: GDOT 2014.

Figure 1. Northwest Corridor Project area.

2.0 Need for Quantitative MSAT Analysis

GDOT made the determination that a quantitative MSAT analysis was needed for this project. Based on GDOT’s assessment, the Northwest Corridor project falls into the third category of project types from FHWA Interim Guidance (FHWA 2012) due to the expected traffic volumes and the proximity of the project to populated areas. The projected design year (2035) traffic volumes near the south end of the project of 301,800 vehicles per day (I-75 south of Delk Road) exceed the 140,000 to 150,000 annual average daily traffic (AADT) threshold in FHWA’s guidance. (GDOT 2014) As such, the project meets FHWA’s criteria for projects with higher potential for MSAT effects, triggering the need for a quantitative MSAT analysis. (FHWA 2012)

At the time the FEIS was prepared, the U.S. Environmental Protection Agency’s (EPA) Motor Vehicle Emission Simulator (MOVES) model was not yet required to be used in regional conformity modeling, so the Atlanta Regional Commission (ARC), the regional planning agency, had not yet developed the necessary MOVES inputs to estimate onroad emissions for the Atlanta area using MOVES. However, by the time of the 2014 reevaluation of the project, the necessary local MOVES data were available from ARC, so GDOT made the determination to reevaluate MSAT impacts from this project using MOVES. (Philips 2015) GDOT was the project lead for this MSAT analysis. Since the MSAT analysis for the NWC project was the first MSAT analysis done by GDOT, and due to the time-sensitive nature of the project, FHWA assisted GDOT by performing the MOVES portion of the MSAT analysis for the 2014 reevaluation.

3.0 Projected Emissions

MSAT emissions from this project were estimated for a base year (2010), the expected first year of operation (2018), and the project design year (2035). A base year of 2010 was selected to provide reviewers with an estimate of emissions currently being experienced by the population that would be affected by this project. For the two projection years, 2018 and 2035, emissions were calculated for a No-Build condition and a Selected Alternative condition in which the effects of the project are accounted for. Emission calculations for these years and scenarios enabled reviewers to observe the trend in emissions over time, as well as the emission impacts due to the selected project in key years. Table 1 summarizes the MSAT emissions by pollutant and total MSAT emissions in each modeled year and scenario. This table also shows the corresponding vehicle miles traveled (VMT) total associated with these emissions. Diesel VMT also is shown as the diesel PM emissions in table 1 represent emissions from diesel vehicles only.

Table 1. MSAT emissions for each project alternative.
Pollutant

Annual Emissions (tons/year)

Percent Change 2010

to 2035 Selected

Percent Change

2035

No Build to 2035 Selected

2010

Base Year

2018

No Build

2018

Selected Alternative

2035

No Build

2035 Selected Alternative

Acrolein

1.4

0.55

0.55

0.27

0.27

-81%

0.0%

Benzene

13.0

5.0

5.0

3.9

3.9

-70%

0.0%

1,3–Butadiene

2.1

0.77

0.77

0.52

0.53

-75%

1.9%

Diesel PM

180

55

55

14

14

-92%

0.0%

Formaldehyde

19.0

8.6

8.6

5.8

5.9

-69%

1.7%

Naphthalene

2.4

0.95

0.95

0.56

0.57

-76%

1.8%

Polycyclic Organic Matter

1.2

0.41

0.41

0.13

0.13

-89%

0.0%

VMT Total (million miles)

Diesel VMT (million miles)

2,682

354

2,924

381

2,951

383

3,350

435

3,458

436

29%

23%

3.2%

0.2%

Source: GDOT 2014.

Based on the analysis shown in Table 1, MSAT emissions in the area of the Northwest Corridor project are expected to decline by about 70 to 90 percent from 2010 to 2035, regardless of whether the project is built. Diesel PM emissions show the greatest decrease of all MSAT pollutants at 92 percent. These emission reductions are projected to occur even with a projected 29 percent increase in VMT that is expected to occur over the same time period.

4.0 Methodology

Development of Affected Network

Figure 2 shows the resulting affected network included in the MSAT modeling of the NWC project. To develop the affected MSAT network, GDOT attempted to identify the segments of the roadway network that would be affected by the proposed the project in a meaningful way. This included evaluating links that met one or more of the following metrics for determining meaningful changes in travel activity when comparing the Selected Alternative and No-Build networks, using the ARC regional travel model:

GDOT initially identified all links that met one or more of these criteria. This initial set of affected links was then further refined by applying knowledge of the area and engineering judgment to better identify just the links for which the changes were likely to have been caused by the NWC project and not by artifacts of the modeling. GDOT worked with the traffic modelers and local planners in this process. GDOT also looked at the changes in volumes for links meeting the above criteria—very low volume roads were eliminated from the affected network. This was an involved and detailed process, including manual evaluation of the appropriateness of including certain links in the affected network. FHWA also collaborated with GDOT and their traffic consultant to finalize the affected network. (Philips 2015)

Motor Vehicle Emission Simulator (MOVES) Analysis

The U.S. Environmental Protection Agency’s (EPA) MOVES2010b model was used to calculate July daily onroad emissions (EPA 2012). Table 2 summarizes the selections that were made for each of the MOVES parameters in the MOVES graphical user interface (EPA 2012). These analyses used the MOVES model to calculate hourly emissions, using the MOVES “Inventory” mode for calculations, over an entire July day in the analysis year. All expected vehicle type/fuel type combinations were modeled, for the two urban road and two rural road types in MOVES. Separate runs were made for each of the four counties affected by this project—Bartow County, Cherokee County, Cobb County, and Fulton County—in each analysis year (2010, 2018, and 2035) and scenario. Off-network emissions (calculated by MOVES using the Off-network road type) were not included in this analysis. Only the VMT from the portions of the roadways included in the MSAT affected network, as illustrated in Figure 2, were included in the MOVES runs.

Table 3 summarizes the sources of data used for each of the MOVES inputs. Many of the MOVES data inputs needed for these MSAT analyses were provided by either ARC or developed from traffic data provided by GDOT. For fuel inputs, the MOVES defaults for the county and analysis year being modeled were used. Inputs that were developed specifically for this MSAT analysis included the average speed distribution, road type VMT fractions, and Highway Performance Monitoring System (HPMS) VMT for all scenarios modeled. While July was the only month modeled in MOVES, the meteorological data inputs for July represented the annual average temperatures and humidity by hour.

This figure shows the traffic model network in the study area. Links with a change in traffic volumes of at least a 5 percent and 50 vehicle per day between the 2035 build and no-build are shown in different colors. Intersections with peak hour delay changes of at least 10 percent are also shown.

Source: GDOT 2014.

Figure 2. NWC project affected transportation network.

Table 2. Selection of MOVES parameters.
Inputs

Selections

Scale

Domain/Scale: County

Calculation type: Inventory

Time Spans

Time aggregation level: Hour

Years: 2010, 2018, 2035

Months: July

Days: Weekdays and weekends

Hours: all 24

Geographic Bounds

Separate runs for: Bartow County, Cherokee County, Cobb County, and Fulton County

Vehicles/Equipment

All allowable vehicle and fuel type combinations

Road Type

Rural restricted access

Rural unrestricted access

Urban restricted access

Urban unrestricted access

Pollutants

Total Gaseous Hydrocarbons

Non-Methane Hydrocarbons

Volatile Organic Compounds

Primary Exhaust PM10-Total

Primary PM10-Organic Carbon

Primary PM10-Elemental Carbon

Primary PM10-Sulfate Particulate

Primary PM2.5-Organic Carbon

Total Energy Consumption

Methane

Nitrous Oxide

Atmospheric CO2

CO2 Equivalent

Benzene

1,3–Butadiene

Formaldehyde

Acrolein

Polycyclic Aromatic Hydrocarbons

Processes

Running Exhaust

Crankcase Running Exhaust

General Output

Mass units: Grams

Energy units: Million Btu

Distance units: Miles

Activity: Distance traveled

Output Emissions Detail

Hour

County

Fuel Type

Table 3. MOVES input data sources.
Input

Data Source

Notes

Age Distribution

ARC

Average Speed Distribution

GDOT

Data table developed from traffic provided by GDOT

Fueltype and Technologies

MOVES Default

Fuel Supply

ARC

Fuel Formulation

ARC

Meteorology Data

ARC

Ramp Fraction

GDOT

Ramp Fraction = 0%; ramp activity is accounted for in the traffic data provided by GDOT

Road Type Distribution

GDOT

Data table developed from traffic provided by GDOT

Source Type Population

ARC

HPMS Vehicle Type Year

GDOT

Data table developed from traffic provided by GDOT

Month VMT Fraction

ARC

Day VMT Fraction

ARC

Hour VMT Fraction

ARC

I/M Programs

ARC

Annual emissions were calculated by multiplying the MOVES-calculated July daily emissions by 31 days divided by the July monthly VMT fraction (0.09) and converting the results from grams to tons for each pollutant. The polycyclic organic matter (POM) emissions were calculated as the sum of the pollutants included in polycyclic aromatic hydrocarbons (PAH), as provided by MOVES, with the exception of naphthalene particle and gas.

5.0 Analysis Findings and Conclusions

This analysis shows a general emissions reduction for all seven MSAT compounds from 2010 to 2035 along the project corridor, which is consistent with the national trend. These reductions are primarily due to Federal motor vehicle and fuel control programs, even as vehicle activity increases during this time period.

The MSAT analysis for this project states: “The analysis concluded that reductions in MSAT emissions will occur for the transportation network affected by the project regardless of whether the project is constructed. Differences in emissions between the Selected and No-Build alternatives are indistinguishable. Compared to 2010 levels, emissions are reduced by almost 90 percent for either the Selected or No Build alternatives. Uncertainties in available information and tools preclude FHWA from being able to estimate the potential health impacts attributable to the MSAT compounds at current and projected emission levels.” (GDOT 2014)

6.0 Lessons Learned

GDOT, with its contractor, had previously prepared quantitative MSAT analyses for the Northwest Corridor project. However, this 2014 reevaluation was the first prepared using MOVES. FHWA was involved with GDOT throughout the project, serving as an important project resource, and sponsored an MSAT class for GDOT consultants.

GDOT has developed a process that has been used in other recent MSAT analyses prepared by GDOT since the Northwest Corridor analysis, all resulting in either a FONSI or ROD. This process includes having the consultant prepare a document of their approach for determining affected network links. GDOT has learned that planning ahead, gathering the correct data, performing early quality assurance, and setting up the analysis framework up front saves time and rework in the long run.

This analysis also served as a learning process for FHWA. Through their direct involvement with this project, FHWA was able to be more specific in the Frequently Asked Questions that they were developing related to preparing quantitative MSAT analyses. FHWA also developed workshop materials that have been presented in a number of areas based on the analysis completed for the Northwest Corridor. FHWA also noted that the affected transportation network should be based on available project-specific information (such as the environmental document traffic analysis) considering changes in several traffic metrics such as annual average daily traffic volumes, travel time, and intersection delay that could result in meaningful changes in MSAT emissions as a result of the project (e.g., ±10% or more). The affected transportation network should be developed in a manner consistent with the purposes of NEPA, which is to study the affected environment. (Claggett 2015)

7.0 References

EPA 2012. “Motor Vehicle Emission Simulator (MOVES)—User Guide for MOVES2010b,” EPA-420-B-12-001b, U.S. Environmental Protection Agency Office of Transportation and Air Quality, June 2012.

FHWA 2012: “Interim Guidance Update on Mobile Source Air Toxic Analysis in NEPA,” Federal Highway Administration, December 6, 2012.

GDOT 2014: “Project CSNHS-0008-00(256), Cobb and Cherokee Counties, PI No. 008256, Reevaluation,” State of Georgia Department of Transportation, August 12, 2014, available http://www.nwcproject.com/media/pdfs/REEVAL_PI/Reeval.pdf.

Claggett 2015: Michael Claggett, Federal Highway Administration, Air Quality Modeling Specialist, personal communication with M. Mullen, SC&A, Inc., October 22, 2015.

Dixon 2015: Chetna Dixon, Federal Highway Administration Georgia Division, Environmental Coordinator, personal communication with M. Mullen, SC&A, Inc., October 7, 2015.

Phillips 2015: Amber Phillips, Georgia Department of Transportation, Office of Environmental Services, personal communication with M. Mullen, SC&A, Inc., October 13, 2015.
