Report
This report is an archived publication and may contain dated technical, contact, and link information
Publication Number: FHWA-RD-03-048
Date: September 2003

Effects of Geosynthetic Reinforcement Spacing on the Behavior of Mechanically Stabilized Earth Walls

CHAPTER 3. NUMERICAL ANALYSIS

3.1 Scope

The purpose of the current study is to investigate the behavior of MSEWs with modular block facing and geosynthetic reinforcement using the two-dimensional finite difference program FLAC (Version 3.40, Itasca 1998). A set of computer runs identified failure mechanisms of MSEWs as function of geosynthetic spacing, considering the effects of soil strength, reinforcement stiffness, connection strength, secondary reinforcement layers, and foundation stiffness. Numerical analysis also was conducted to investigate the effects of reinforcement length on reinforcement stresses and wall stability. FLAC predictions were compared with the existing design method (AASHTO 98) using the MSEW 1.1 program (ADAMA Engineering 1998). Additional numerical experiments investigated the effect of some modeling parameters on the predicted wall response.

3.2 Numerical Model

The behavior of MSEW with modular block facing and geosynthetic reinforcement was investigated with numerical models that simulate construction of the wall, layer by layer, until it fails under gravity loading. Various responses during wall construction such as displacement accumulation, stress histories, and tensile load in reinforcement, can be recorded. The components and basic geometry of the model are shown in figure 3.1.

3.2.1 Modeling Methodology

The numerical model is updated continuously by adding soil and geosynthetic layers up to failure in stages, which represent the construction sequence of actual walls. The first reinforcement layer is always installed at elevation 0.2 m on top of the first soil layer and the first block. Next, reinforcement layers are installed according to the reinforcement spacing. For example, the modeling sequence of a wall with reinforcement spacing equal to 0.4 m consists of the following stages (figure 3.2):

  • Stage 1: Foundation modeling (equilibrium under self-weight is achieved; elastic modulus of soil is updated).
  • Stage 2: Installation of a modular block of layer 1.
  • Stage 3: Placement of a layer of reinforced and backfill soil (equilibrium under self-weight is achieved; elastic modulus of soil is updated).
  • Stage 4: Installation of first layer of reinforcement.
  • Stage 5: Installation of a modular block of layer 2.
  • Stage 6: Placement of a layer of reinforced and backfill soil (equilibrium under self-weight is achieved; elastic modulus of soil is updated). NOTE: For the given reinforcement spacing s=0.4 m, a reinforcement layer is not installed at that elevation (it would be installed only for the reinforcement spacing s=0.2 m).
  • Stage 7: Installation of a modular block of layer 3.
  • Stage 8: Placement of a layer of reinforced and backfill soil (equilibrium under self-weight is achieved; elastic modulus of soil is updated).
  • Stage 9: Installation of a layer of reinforcement.
  • Stage 10: Installation of a modular block of layer 4.
  • Stage 11: Placement of a layer of reinforced and backfill soil (equilibrium under self-weight is achieved; elastic modulus of soil is updated). NOTE: For the given reinforcement spacing s=0.4 m, a reinforcement layer is not installed at that elevation (it would be installed in case the reinforcement spacing requires).
  • Stage 12: Installation of a modular block of layer 5.

Wall construction continues up to failure following the same pattern.

The construction using the numerical model continues until the program stops due to excessive deformations in a certain element (bad geometry). At this stage, the deformations in the system were large and corresponded essentially to a failed wall. Numerical and physical parameters such as slip surface development, maximum displacement of the system accumulated during wall construction, number of calculation steps necessary to equilibrate the system after placement of each layer, and history of maximum unbalanced force, allowed (Who? What?) to define a critical wall height. This height corresponds to a wall at the verge of failure (figure 3.3–b). All states corresponding to a height larger than the critical one are considered as failure states (figure 3.3–a). To investigate the effects of reinforcement length on wall stability, the wall height of certain numerical tests was kept equal to the critical one, while the length of reinforcement was increased. For these tests, the states that correspond to walls with length-to-height ratio larger than the critical one are considered as stable states (figure 3.3–c).

3.2.2 Model Description

The major components of the model are foundation, modular blocks, reinforced soil, retained soil (backfill), and reinforcements layers (figure 3.1). A set of model variables (listed in table 3.1) was implemented to allow change of geometry and material properties according to the purpose of the analysis.

A typical numerical grid and dimensions to discretize the problem are shown in figure 3.4. The wall and the adjacent backfill with uniform grid density form a 'kernel' of the numerical model. Its dimensions can be changed accordingly (zones 1 and 2 in figure 3.5). The grid around that kernel models the foundation soil and the end part of the backfill adjacent to model boundaries (zones 3 to 6 in figure 3.5). The foundation depth and width of end backfill were fixed to 5.0 m for all simulations.

Grid density of the model is shown on figure 3.5. The grid in zone 1 (figure 3.5–a) represents the wall facing constructed from separate modular blocks. The block-block, block-soil, and block-reinforcement interaction is modeled interfacing with properties that can be changed accordingly. In the final version of the model, the modular blocks are divided into rectangular elements with dimensions 0.05 x 0.1 m (uniform density in both directions of zone 1) (figure 3.5–b). In early parametric studies, the modular blocks were represented either by one element or divided into square elements with dimensions 0.1 x 0.1 m (figure 3.5–c); however, to represent the interaction at the connections more accurately, numerical sensitivity analysis indicated that horizontal grid density should be increased. Zone 2 consists of 2 parts (figure 3.5–a). Part 2–a corresponds to the reinforced soil, and part 2–b corresponds to a part of the retained soil adjacent to the reinforced soil. Both parts of zone 2 can change their global horizontal dimension by changing the model variables "length of reinforcement, l" (zone 2–a) or "length of adjacent backfill, L" (table 3.1). The grid density of zone 2 is uniform in both directions and can be changed by changing the model variable "number of sublayers within a height of 0.2 m (fixed height of a modular block), nsl" (table 3.1). In the final version of the model, the elements of zone 2 are squares with dimensions a x a m, where a is defined as follows:

Equation 3.1. Lowercase A, which represents the length of squares within zone 2 as depicted in figure 3.5, equals the height of modular block divided by the number of sublayers, which equals 0.2 divided by lowercase N subscript lowercase SL, which is the number of sublayers within a height of 0.2 meters (fixed height of a modular block), which equals 0.2 divided by 2, which equals 0.1 meters.
(3.1)

However, in the current analysis, the influence of grid density in zone 2 less than 0.1 x 0.1 m resulted in numerical instability. Numerical tests were done with grid density in zone 2 corresponding to element size 0.05 x 0.05 m and numerical instability constantly occurred at a wall height of about 2 m. Because of the encountered numerical instability at such small dimensions, the grid density in zone 2 was kept constant, corresponding to the smallest stable element size of 0.1 x 0.1 m. In zone 3 (end part of the backfill), grid density is uniform vertically and changes gradually in horizontal direction. The element size changes from left to right from 0.1 x 0.1 m to 0.5 x 0.1 m. In zone 5 (middle part of foundation), grid density is uniform in horizontal direction and changes gradually in vertical direction. The element size changes from top to bottom from 0.1 x 0.1 m to 0.1 x 0.5 m. In zones 4 and 6 (left and right parts of the foundation), grid density changes gradually in both directions. The element size changes from 0.1 x 0.1 m to 0.5 x 0.5 m. Grid density of the model was defined with respect to the modular block height (hbl= 0.2 m), with ability to be changed within the zone 2 (figure 3.5). In all numerical tests, the smallest stable element size was used? 0.05 x 0.1 m in zone 1 (facing) and 0.1 x 0.1 m in the soil. Figure 3.4 shows a typical grid in all zones.

Boundary conditions of the model consist of prescribed zero velocities (corresponding to zero displacements) perpendicular to the boundaries (figure 3.5). Boundary effects on model response were investigated with respect to the distance of the wall to the right model boundary. In the final version of the model, the total width of backfill is 15.0 m (the width of zone 2–b is 10.0 m, and the width of zone 3 is 5.0 m, figure 3.5). For all numerical simulations, this backfill width ensured that the deformed zone behind the wall was not close to the model boundary. Several numerical simulations varied the width of backfill from 5.2 m to 15.0 m (L=0.2–10.0 m). It was proved that boundary affected the results significantly when the active zone that developed behind the wall was close to or reached the right model boundary. Close boundary effects increased wall stability because of the restraint horizontal displacements along the right model boundary. To avoid boundary effects on model response, additional tests were done for a model (case 1, s=0.2 m, h=6.6 m, l=1.5 m), varying the width L of the adjacent backfill (zone 2–b on figure 3.5). The distributions of stresses and horizontal displacements along a vertical section 0.1 m behind the facing are shown on figure 3.7 for L=6, 8 and 10 m. The differences were less than 5 percent. In all consequent numerical tests, the width of the backfill was 15.0 m (L=10 m).

Wall facing was specified as concrete modular blocks with a fixed height of 0.2 m and a fixed thickness of 0.2 m. Each new block was placed precisely on top of the previous one. As construction progressed, the facing tilted outward as a result of cumulative displacements. Block-block, block-reinforcement, and block-soil interaction was modeled with interfaces along which sliding or separation can occur.

During construction, reinforcement layers were placed, following the scheme set by the specified spacing (figures 3.2 and 3.8). Each reinforcement layer was designed with two parts, using beam and cable structural elements available in FLAC. The reinforcement section confined between the facing blocks was modeled using a FLAC beam element. The reinforcement section embedded in soil was modeled using a FLAC cable element. The beam and cable elements were linked at a common node. FLAC beam elements are two-dimensional elements with three degrees of freedom at each end node (x-translation, y-translation and rotation). These elements represent structural members in which bending resistance is important. Beam elements can be joined together with each other and the grid, directly or through interface elements. FLAC cable elements are one-dimensional axial elements that may be anchored at a specific point in the grid or grouted so that the cable elements develop forces along its length as the grid deforms. They cannot sustain bending moments and are used to model supports for which tensile capacity is important. Cable elements interact with the confining material only when they are grouted. To represent the frictional connection between the modular blocks and the reinforcement correctly, the reinforcement was modeled in two parts using beam and cable elements. Beam elements represent the block-reinforcement interaction. Because beam elements can interact with the grid only through interfaces or explicitly specified links, they were not used to model the reinforcement-soil interaction. Cable elements were used to represent the soil-reinforcement interaction, because they cannot be used with the interfaces that model the block-reinforcement interaction.

Each wall was modeled to reach failure by increasing its height in layers while keeping the reinforcement length equal to 1.5 m. In the process of numerical simulation, the wall reached the verge of failure, but its construction continued until the failure was detected numerically. The state that corresponds to a wall at the verge of failure was called a critical state. A critical state is defined by analyzing numerical and physical parameters such as slip surface development, number of calculation steps necessary to equilibrate the system after placement of each layer (figures 3.9–a, 3.10–a, 3.11–a) maximum cumulative displacement of the system during construction (figures 3.9–b, 310–b, 3.11–b), and history of maximum unbalanced force. In the current studies, a critical state was identified when at least three of the following events occurred simultaneously: (1) a slip surface was developed fully, (2) the maximum cumulative displacement increases nonlinearly, (3) the number of calculation steps per layer increased rapidly, and (4) the history of maximum unbalanced force indicated an abrupt change of the unbalanced force. Figures 3.9– 3.11 provide typical plots showing the maximum cumulative displacements and the number of calculation steps (necessary to equilibrate the system after the placement of each layer) .

The height and length-to-height ratio at the critical state are called critical height (hcr) and critical length-to-height ratio (l/hcr), respectively. States of a model that correspond to walls higher than the wall at the critical state are called failure states. Stable states correspond to walls with a height equal to the critical height and a length-to-height ratio larger than the critical length-to-height ratio. The definition of failure, critical, and stable states of a numerical model is illustrated on figure 3.3.

In the process of numerical simulation, the wall is constructed until the failure is detected numerically (i.e., the model construction stops). The model stops in the following two cases:

  • If excessive deformations (causing bad geometry) in a certain element are detected.
  • If model reaches the specified final height of the wall, and equilibrium is achieved.

The equilibrium state in FLAC is identified when one of the following happens: (1) the number of calculation steps reaches the specified limit (default value is 100,000); or (2) the largest ratio of maximum unbalanced force2 to average applied force is below a specified limit called "equilibrium ratio" (default value is 0.001). Computer runs investigated the influence of these model response limits. Typical results are presented on figures 3.9–3.11, and in table 3.2. The presented results proved that the model response is not influenced when the equilibrium ratio was changed from 0.001 (default value) to 0.01, and when the maximum number of steps was changed from 100,000 (default value) to 200,000. In all numerical simulations, the equilibrium ratio was srat=0.01 (10 times larger than the default value), and the maximum number of calculation steps was 100,000 (default value).

3.2.3 Material Properties

The material properties used in the analysis were based on data reported in the literature. They represent typical values used in design practice (Das 1999).

The soil was modeled as a cohesionless material using a FLAC plastic constitutive model that corresponds to a Mohr-Coulomb failure criterion with a hyperbolic stress-strain relationship. The elastic modulus of soil was updated after placement and equilibration of each soil layer using the following hyperbolic stress- strain relationship (Wong and Duncan 1974):

Equation 3.2. E subscript S, which is the elastic modulus of soil, divided by P subscript lowercase A, which is the atmospheric pressure, is equal to K, which is a hyperbolic model coefficient, times the quotient of the following raised to the lowercase M power (which is a hyperbolic model coefficient which, in all cases, was kept constant equal to .5): theta subscript 3, which is the minor principal effective stress, divided by P subscript lowercase A.
(3.2)

where: Es = elastic modulus of soil; Pa = atmospheric pressure; σ3 = minor principal effective stress; and K and m are the hyperbolic model coefficients. For all numerical simulations, the hyperbolic model coefficient m was kept constant equal to 0.5 (Bathurst and Hatami 1999, Ling et al. 2000). The soil properties were changed to investigate different aspects of wall behavior. The soil properties that were used in different numerical tests are summarized in tables 3.3 and 3.4.

The modular blocks were modeled using a linear elastic constitutive model. The geometry, parameters, and properties of the facing were kept constant for all numerical runs and are given in table 3.5.

The reinforcement layers were modeled using beam and cable structural elements available in FLAC. The properties of the cable and beam elements used in different numerical tests are summarized in table 3.6.

The block-block, block-reinforcement, and block-soil interaction was modeled using interfaces available in FLAC. Three types of interfaces were used in the model: between two facing blocks (block-block interface), between a facing block and the part of reinforcement modeled by a beam element (block-beam interface or block-reinforcement interface), and between a facing block and the adjacent soil (block-soil interface). The interfaces are sketched in figure 3.8. They represent planes along which sliding or separation can occur and are characterized by the Coulomb shear-strength criterion:

Equation 3.3. F subscript lowercase S max, which is maximum shear force, equals C, which is cohesion along the interface, times L subscript lowercase E, which is effective contact length, added to the product of F subscript N, which is normal force, times the tangent of d (delta), which is the friction angle of interface surfaces.
(3.3)

where: Fsmax = maximum shear force, c = cohesion along the interface, Le = effective contact length, Fn = normal force, and δ = friction angle of interface surfaces. If shear forces in interfaces are less than the maximum shear strength defined by Equation (3.3), sliding or separation occurs.

The properties of block-block and block-reinforcement interfaces were changed to simulate different connection strengths between the reinforcement and the modular blocks. Frictional connection was represented by interfaces with no cohesion, and the interface angle of friction was changed to investigate its influence on wall behavior. Structural connection was represented by interfaces characterized with both cohesion and friction. Block-soil interfaces were always modeled with no cohesion. Interface properties used in analysis are summarized in table 3.7. To ensure numerical stability, the normal and shear stiffness of the interfaces were modeled following the guidelines given in the FLAC manual (Itasca 1998). The normal stiffness of interfaces was assigned to correspond to the bulk modulus of concrete. The shear stiffness of interfaces was assigned to correspond to the initial shear modulus of reinforced soil.

The interaction between reinforcement layers and soil is represented by grout-soil interface defined as a part of the cable element definition. Properties of grout as part of the cable elements definition are given in table 3.6.

3.3 Scope of Parametric Studies

Parametric studies investigated the behavior of MSEWs with modular block facing and geosynthetic reinforcement using a numerical model that can simulate construction sequence layer by layer up to failure. A set of runs identified failure mechanisms of MSEWs as function of geosynthetic spacing, considering the effects of soil strength, reinforcement stiffness, connection strength, use of secondary reinforcement layers, and foundation. A second set of numerical runs investigated the effects of reinforcement length on reinforcement stresses and wall stability. FLAC predictions were compared with an existing design method (AASHTO 98) using the MSEW 1.1 program (ADAMA Engineering 1998). Additional numerical runs investigated the effect of some model parameters on the predicted wall response. All numerical runs were grouped into cases according to the set of properties used in the analysis. Within each case, numerical runs with different reinforcement spacing were performed. Summary of all parametric studies is given in table 3.8.

Cases 1, 2, and 3 represent models with very stiff foundation and soil strength of reinforced and retained soil decreasing from case 1 (high strength soil) to case 3 (low strength soil). Cases 4, 5, and 6 represent models with soil properties that are the same for the entire model, with soil strength decreasing from case 4 (high strength soil) to case 6 (low strength soil). For cases 1 to 6, the connection between the reinforcement and facing is frictional (baseline strength, table 3.7), and reinforcement properties correspond to typical design values (baseline reinforcement (BR), table 3.6). All relevant reinforcement spacings within the range of 0.2 to 1.0 m were investigated.

Cases 7 to 12 were designed to investigate certain aspects of wall behavior complementing the first six cases. Case 7 was designed to assess the effects of secondary reinforcement layers (figure 3.12). Model properties of case 7 were the same as the model properties of case 2,with the exception of reinforcement layout, which consists of primary reinforcement layers at every 0.6 m (l=1.5 m) and secondary reinforcement layers in between at every 0.2 m (l=0.3 m). Cases 8–1, 8–2, and 8–3 were designed to investigate the effects of reducing the reinforcement stiffness on wall response. The effect of connection strength was investigated with cases 9 (low strength frictional connection) and case 12 (structural connection). Case 10 was designed to investigate the wall behavior considering weak foundation. Case 11 was designed to investigate the effect of soil dilatancy on wall behavior.

Additional runs were carried out to investigate the effect of grid density, boundary distance (i.e., boundary effects), and values of FLAC equilibrium limits.

Four numerical models corresponding to different failure mechanisms were investigated with respect to failure and stable states, and are called baseline cases. The set of numerical experiments for case 1 and some of the corresponding modified cases is represented with an organizational chart in figure 3.13.

Thirty-seven runs were directly involved in the analysis (table 3.8). The runs were performed on three personal computers. One of the runs was completed with an Intel® x86 Processor, 384 MB RAM, 800 MHz; the other two runs were completed with Pentium® II Processor Intel MMXTM, 128 MB RAM, 550 MHz. The total time of these 37 runs was about 900 hours, or 106 working days. General information about the runs of all cases (at failure and critical states) is given in table 3.9 and table 3.10. Typical input file is given in the appendix.

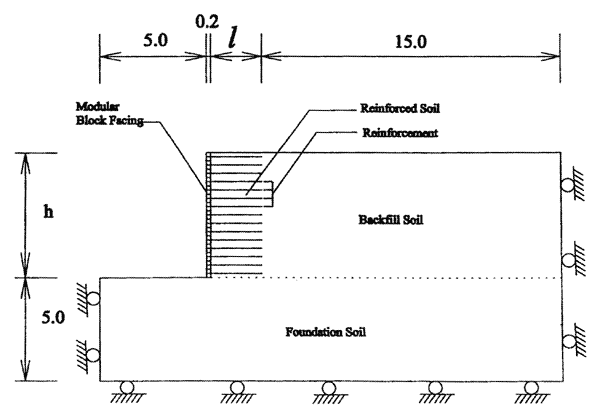

Figure 3.1. Diagram. Numerical Model Components. This diagram shows the components and basic geometry of a numerical model that simulates construction of an MSEW layer by layer until it fails under gravity loading. It includes a drawing of a rectangle of foundation soil at the bottom that is 20.2 meters plus a variable lowercase L that represents the unknown length of the required reinforced soil in length, and 5.0 meters in height, and a shorter rectangle of backfill soil on top of the foundation soil that is 15.0 meters long and a variable lowercase H in height. Reinforced soil with a length of lowercase L and a height of lowercase H and a reinforcement abut the backfill soil, and modular block facing of 0.2 meters in length and a height of lowercase H abuts the reinforced soil.

Figure 3.1 Numerical Model Components.

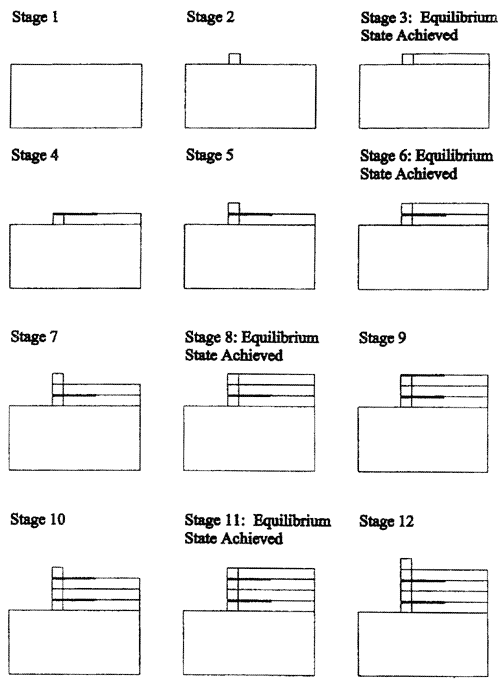

Figure 3.2. Diagram. Schematic of Modeling of Construction Sequence of Wall with Reinforcement Spacing Equal to 0.4 Meters. This figure contains 12 drawings that represent stages of adding soil and geosynthetic layers up to failure in the numerical model introduced in figure 3.1. The stages represent the construction sequence of actual walls. Stage 1 is shown by a rectangle, which represents foundation modeling (equilibrium under self-weight is achieved; elastic modulus of soil is updated). Stages 1-12 all include this rectangle. In stage 2, a small box is drawn on top of the rectangle, about one-third of the total distance of the rectangle from the left and approximately one-fifth the total height of the rectangle. This represents the installation of a modular block of layer 1. In stage 3, which states " equilibrium state achieved," a layer represented by a thin rectangle that is the height of the box and runs the remaining length of the bottom rectangle to the right, is added to the diagram. This represents a layer of reinforced and backfill soil (equilibrium under self-weight is achieved; elastic modulus of soil is updated). Stage 4 is the same drawing as stage 3, but with a thick line drawn on top of the left half of the combined box and thin rectangle; it represents the installation of the first layer of reinforcement. In stage 5, another small box is added directly on top of the box in stage 2. This represents the installation of a modular block of layer 2. Stage 6, which states "equilibrium state achieved," adds a thin rectangle directly above the rectangle added in stage 3. This represents placement of a layer of reinforced and backfill soil (equilibrium under self-weight is achieved; elastic modulus of soil is updated). In stage 7, another modular block is added, and in stage 8, another thin rectangle layer of reinforced and backfill soil is added. At stage 9, a thick line drawn on top of the left half of the combined box and thin rectangle represents a layer of reinforcement. In stage 10, another modular block is added, and a layer of reinforced and backfill soil is placed in stage 11. Stage 12 begins installation of a modular block of layer 5.

Figure 3.2 Schematic of Modeling of Construction Sequence of Wall with Reinforcement Spacing Equal to 0.4 m.

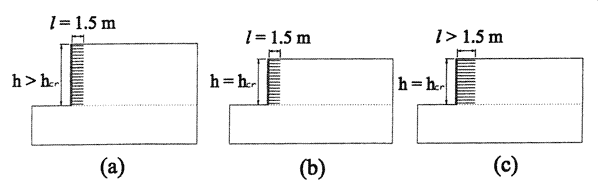

Figure 3.3. Diagram. Definition of: (A) Failure State; (B) Critical State; (C) Stable State. This figure contains three drawings representing construction using the numerical model, as described in figure 3.2. At failure state, the length of the reinforcement wall equals 1.5 meters, and the height of the reinforcement wall is greater than the height at critical, which is a wall at the verge of failure. At critical state, the reinforcement wall length equals 1.5 meters, and the wall's height equals height at critical. At stable state, the length of the reinforcement wall is greater than 1.5 meters, and the wall's height equals height at critical.

Figure 3.3 Definition of: (a) Failure State; (b) Critical State; (c) Stable State.

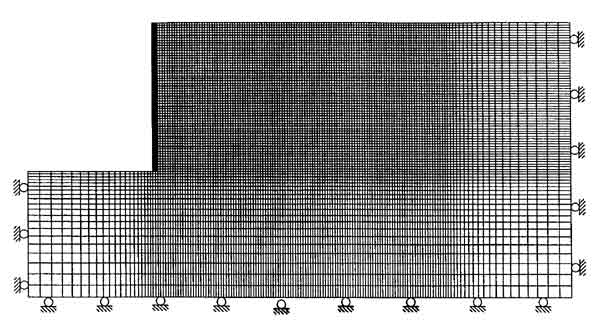

Figure 3.4. Grid. Typical Numerical Grid. This grid represents a set of model variables for the model components of foundation, modular blocks, reinforced soil, retained soil (backfill) and reinforcement layers that allow geometry and material property changes for the purpose of analysis. The shape of the grid follows the shape of the model in figure 3.1; it has the outline of a reversed capital L. The lines in the grid are further apart at the left and right ends and get closer together in the middle.

Figure 3.4 Typical Numerical Grid

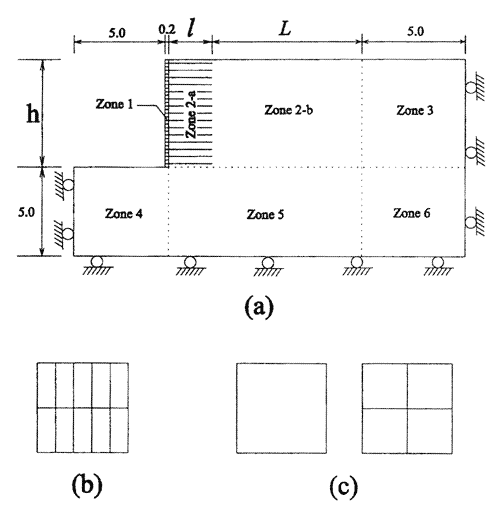

Figure 3.5. Diagram. Grid Definition: (A) Model Zones with Respect to Grid Generation; (B) Grid of Modular Blocks in the Current Model; (C) Grid of Modular Blocks in the Early Versions of the Model. This figure contains three separate drawings. The drawing in diagram A is similar to the drawing in figure 3.1 of the numerical model. It is divided into six zones. Zones 4, 5, and 6 divide the foundation soil. These zones are all 5.0 meters high; zones 4 and 6 are on the left and right ends, respectively, of the diagram and are both 5.0 meters long; zone 5, in the middle of the diagram, is the combined length of the length of reinforcement (lowercase L) and the length of the adjacent backfill (uppercase L). Zones 1, 2, and 3 are on top of the foundation soil, and are all a height of variable lowercase H. The grid in zone 1 represents the wall facing constructed from separate modular blocks. It is 0.2 meters long and begins 4.8 meters from the left of the end of zone 4. Zone 2 consists of 2 parts. Zone 2A corresponds to the reinforced soil and is length lowercase L, and zone 2B corresponds to a part of the retained soil adjacent to the reinforced soil and is length uppercase L. Zone 3 is directly above zone 6 and is 5.0 meters long. The drawing in diagram B is of 10 rectangles of equal size within a box. This represents the modular blocks with uniform density in both directions of zone 1, as represented in diagram A. There are two boxes that represent modular blocks in diagram C; the first is a simple box, and the second is a box divided into four quadrants. In early parametric studies, the modular blocks were represented either by one element or divided into square elements with dimensions 0.1 by 0.1 meters.

Figure 3.5 Grid Definition: (a) Model Zones with Respect to Grid Generation; (b) Grid of Modular Blocks in the Current Model; (c) Grid of Modular Blocks in Early Versions of the Model.

Figure 3.6. Graph. Boundary Effects on Model Response: Horizontal Displacements along Vertical Section A Located 0.1 Meter behind the Facing. This graph charts the horizontal displacement in centimeters, from 0 to 5, of three widths of adjacent backfill grids (6 meters, 8 meters, and 10 meters) at different elevations from 0 to 7.2 meters. Displacement is on the X-axis; elevation is on the Y-axis. All three backfill widths follow very similar paths, beginning at coordinates 0,0, showing peak displacement of 3.4 centimeters at approximately 3.4 meters of elevation, and decreasing back down to approximately .2 centimeters of displacement at around 6.5 meters of elevation.
NOTE: L=Width of adjacent backfill grid (figure 3.5).

Figure 3.6 Boundary Effects on Model Response: Horizontal Displacements along Vertical Section A Located 0.1 m behind the Facing.

Figure 3.7. Graph. Boundary Effects on Model Response: Stress Distributions along Vertical Section A Located 0.15 Meters behind the Facing. This figure shows distributions of stresses in kilopascals and horizontal displacements along a vertical section 0.15 meters behind the facing for three widths of adjacent backfill (6 meters, 8 meters, and 10 meters). Stress from 0 to 220 kilopascals is measured on the X-axis, and elevation from 0 to 7.2 meters is measured on the Y-axis. There are 8 lines on the graph: SXX, length equals 10 meters; SYY, length equals 10 meters; SXX, length equals 8 meters; SYY, length equals 8 meters; SXX, length equals 6 meters; SYY, length equals 6 meters; SXX, rankine; and SYY, theoretical. The lines for SXX, rankine and SYY, theoretical, both follow a straight diagonal line, beginning at coordinates 0, 6.5. The SYY line moves downward at approximately a 75-degree angle, ending at coordinates 143, 0. The SXX line moves downward at approximately an 87-degree angle, ending at coordinates 23, 0.  All of the other SYY lines follow an almost identical path, trending diagonally downward at an approximately 82-degree angle and then flattening out, ending at 0 meters elevation and 208 kilopascals. All of the other SXX lines also follow an almost identical path, trending diagonally downward at an approximately 87-degree angle and then flattening out, ending at 0 meters elevation and 80 kilopascals.
NOTE: L=Width of adjacent backfill (zone 2–a, figure 3.5).

Figure 3.7 Boundary Effects on Model Response: Stress Distributions along Vertical Section A Located 0.15 m behind the Facing.

Figure 3.8. Diagram. Types of Interfaces at the Blocks. This figure demonstrates the three different types of interfaces at the reinforcement blocks: block-to-beam interface; block-to-block interface, and block-to-soil interface. At the bottom of the diagram is a rectangle representing the foundation. Above the foundation, but not touching it, are a square block, or beam, and a thin rectangle layer of soil, as depicted in previous figures. A cable is placed above the beam and the soil layer. The space between the cable and the beam is identified as the block-to-beam interface. Two additional layers of beams and soil are drawn above this, then another cable is drawn on top of those layers. The space between the two beams is identified as the block-to-block interface. The space between the beam and the soil layer is identified as the block-to-soil interface.

Figure 3.8 Types of Interfaces at the Blocks.

(a) Figure 3.9. Graphs. Baseline Cases: (A) Number of Calculation Steps Necessary to Equilibrate Each Layer; (B) Maximum Cumulative Displacement during Wall Construction.  This figure consists of two graphs, both of which chart four representative model cases: case 1, external mode, in which S, or the reinforcement spacing, equals 0.2 meters; case 2, connection mode, in which S equals 0.6 meters; case 8-1, in which S equals 0.4 meters, and case 10, deep-seated mode, in which S equals 0.2 meters. Graph A charts the number of calculation steps on the Y-axis, from 0 to 120,000, and number of layers on the X-axis, from 0 to 40. Case 1 required the least amount of steps to equilibrate each layer; the line trends gradually upward, beginning at 1 layer and approximately 2,000 steps through 28 layers and 18,000 steps, then turns steeply upward to a high of 100,000 steps at 34 layers. Case 2 varies up and down between 16,000 steps at 4 layers and 60,000 steps at 8 layers, and reaches a high of 100,000 steps from 20-23 layers. Case 10 also trends up and down like case 2, but with fewer variations in number of steps, reaching a high of 100,000 steps from 18-23 layers. Case 8-1 trends steadily upward, reaching a high of 100,000 steps at 29 layers, dipping slightly at 30 layers, then back up to 100,000 steps from layers 31-40.

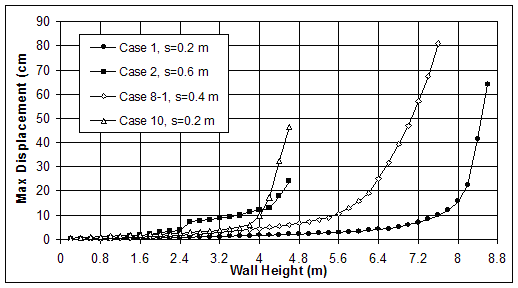

(b) Figure 3.9. Graphs. Baseline Cases: (A) Number of Calculation Steps Necessary to Equilibrate Each Layer; (B) Maximum Cumulative Displacement during Wall Construction.  This figure consists of two graphs, both of which chart four representative model cases: case 1, external mode, in which S, or the reinforcement spacing, equals 0.2 meters; case 2, connection mode, in which S equals 0.6 meters; case 8-1, in which S equals 0.4 meters, and case 10, deep-seated mode, in which S equals 0.2 meters. Graph B charts the maximum cumulative displacement in centimeters during wall construction on the Y-axis against the wall height in meters on the X-axis. All four cases remain relatively flat then rise steeply beginning at different wall heights. Case 1 begins rising steeply at 8 meters wall height and 18 centimeters displacement and peaks at 8.7 meters wall height and 64 centimeters displacement; case 2 begins rising steeply at 4 meters wall height and 11 centimeters displacement and peaks at 4.7 meters wall height and 24 centimeters displacement; case 8-1 begins rising steeply at 5.6 meters wall height and 10 centimeters displacement and peaks at 7.6 meters wall height and 81 centimeters displacement; and case 10 begins rising steeply at 4 meters wall height and 10 centimeters displacement and peaks at 4.7 meters wall height and 48 centimeters displacement.

Figure 3.9 Baseline Cases: (a) Number of Calculation Steps Necessary to Equilibrate Each Layer; (b) Maximum Cumulative Displacement during Wall Construction.

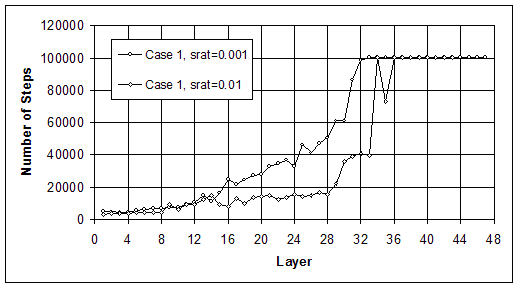

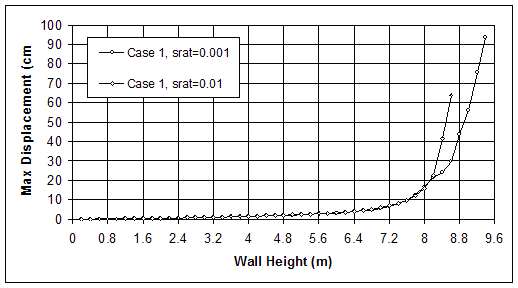

(a) Figure 3.10. Graphs. Effects of Effects of FLAC Equilibrium Ratio Limit on Model Response of Case 1 (S equals 0.2 meters, lowercase L equals 1.5 meters): (A) Number of Calculation Steps; (B) Maximum Cumulative Displacement. This graph illustrates the effect of the of FLAC Equilibrium Ratio Limit (FLAC parameter, srat, that is a typical part of the code and the adopted numerical method, and does not need explanation in this report) on two elements of the model response - number of calculation steps necessary to reach equilibrium after placement of each additional layer of soil; and maximum cumulative displacement for the system at each equilibrium state. The results are typical and in this case valid for Case 1 (s=0.2 m, l=1.5 m).

(b) Figure 3.10. Graphs. Effects of Effects of FLAC Equilibrium Ratio Limit on Model Response of Case 1 (S equals 0.2 meters, lowercase L equals 1.5 meters): (A) Number of Calculation Steps; (B) Maximum Cumulative Displacement. This graph illustrates the effect of the of FLAC Equilibrium Ratio Limit (FLAC parameter, srat, that is a typical part of the code and the adopted numerical method, and does not need explanation in this report) on two elements of the model response - number of calculation steps necessary to reach equilibrium after placement of each additional layer of soil; and maximum cumulative displacement for the system at each equilibrium state. The results are typical and in this case valid for Case 1 (s=0.2 m, l=1.5 m).

Figure 3.10 Effects of FLAC Equilibrium Ratio Limit on Model Response of Case 1 (s=0.2 m, l=1.5 m): (a) Number of Calculation Steps; (b) Maximum Cumulative Displacement.

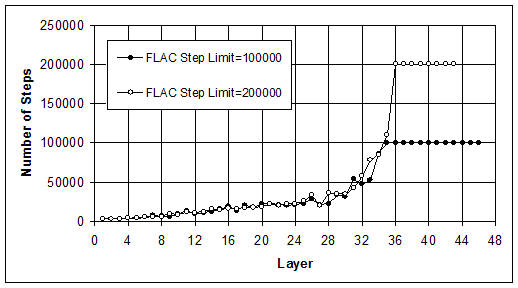

(a) Figure 3.11. Graphs. Effects of FLAC Step Limit on Model Response of Case 12 (S equals 0.2 meters, lowercase L equals 1.5 meters): (A) Number of Calculation Steps; (B) Maximum Cumulative Displacement. This graph illustrates the effect of the of FLAC step limit (FLAC parameter that is a typical part of the code and the adopted numerical method, and does not need explanation in this report) on two elements of the model response - number of calculation steps necessary to reach equilibrium after placement of each additional layer of soil; and maximum cumulative displacement for the system at each equilibrium state. The results are typical and in this case valid for Case 12 (s=0.2 m, l=1.5 m).

(b) Figure 3.11. Graphs. Effects of FLAC Step Limit on Model Response of Case 12 (S equals 0.2 meters, lowercase L equals 1.5 meters): (A) Number of Calculation Steps; (B) Maximum Cumulative Displacement. This graph illustrates the effect of the of FLAC step limit (FLAC parameter that is a typical part of the code and the adopted numerical method, and does not need explanation in this report) on two elements of the model response - number of calculation steps necessary to reach equilibrium after placement of each additional layer of soil; and maximum cumulative displacement for the system at each equilibrium state. The results are typical and in this case valid for Case 12 (s=0.2 m, l=1.5 m).

Figure 3.11 Effects of FLAC Step Limit on Model Response of Case 12 (s=0.2 m, l=1.5 m): (a) Number of Calculation Steps; (b) Maximum Cumulative Displacement.

Figure 3.12. Drawing. Reinforcement Layout with Primary and Secondary Layers for Case 7 (The spacing of the primary reinforcment layers was 0.6 m, and the spacing of the secondary reinforcement layers was 0.2 m.)  This diagram is similar to that of figure 3.1, and shows a closeup for the primary and secondary layers within the reinforcement layout for case 7. It includes a drawing of a horizontal rectangle of foundation soil at the bottom, and a vertical rectangle of backfill soil and primary and secondary reinforcement layers on top of the foundation soil. A modular block facing of 0.2 meters in length abuts the reinforced soil. The secondary reinforcement layers are 0.3 meters in length and the primary reinforcement layers are 1.5 meters in length.

Figure 3.12 Reinforcement Layout with Primary and Secondary Layers for Case 7 (s=0.6/0.2 m).

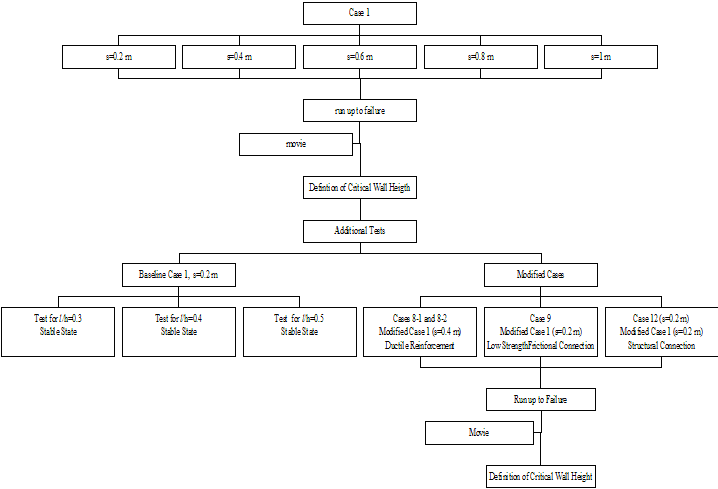

Figure 3.13. Flowchart. Some of the Executed Numerical Runs. The flowchart begins with case 1. Five boxes are placed on the same horizontal line below case 1: S equals 0.2 meters; S equals 0.4 meters; S equals 0.6 meters; S equals 0.8 meters; and S equals 1 meter. The next step after all these boxes is "run up to failure." A box with the word "movie" is under this box and placed slightly to the left. Directly under the "run up to failure" box and below the "movie" box is "definition of critical wall height." "Additional tests" follow from this. There are two tests on the same horizontal line under "additional tests": baseline case 1, S equals 0.2 meters; and modified cases. Three tests are on the same horizontal line under the baseline case 1: "test for length divided by height equals 0.3 stable state;" "test for length divided by height equals 0.4 stable state;" and "test for length divided by height equals 0.5 stable state." Three boxes are on the same horizontal line under the modified cases box: "cases 8-1 and 8-2 modified case 1 (S equals 0.4 meters) ductile reinforcement;" "case 9 modified case 1 (S equals 0.2 meters) low strength frictional connection;" and "case 12 (S equals 0.2 meters) modified case 1 (S equals 0.2 meters) structural connection." Beneath these cases is the box "run up to failure." A box with the word "movie" is under this box and placed slightly to the left. Directly under the "run up to failure" box and below the "movie" box is "definition of critical wall height."

Figure 3.13 Some of the Executed Numerical Runs.

Table 3.1 List of Model Variables.
Model VariableNotationComment
Wall dimensions and grid densityWall heighthMultiple of 0.2 m
Length-to-height ratiol/h Must correspond to wall height multiple of 0.2 m
Length of reinforcementl Multiple of 0.1 m
Length of adjacent backfillLMultiple of 0.1 m
Number of blocks between two reinforcement layersnblDefines the reinforcement spacing. For example, if nbl=4, the corresponding reinforcement spacing is s=nbl*0.2=0.8 m (0.2 m is a fixed height of a modular block)
Number of sublayers within a height of 0.2 mnslDefines grid density in reinforced soil and the adjacent backfill
SoilFriction angles Different values for soil in foundation, wall and backfill can be specified
Poisson's ratiovs
Initial elastic modulusEis
FacingblocksElastic modulusEibIt is recommended that this value does not exceed the elastic modulus of soil more than 10 times (Itasca 1998)
Poisson's ratio vb
ReinforcementCable elastic modulusEc
Grout shear stiffnesskbond
Grout cohesive strengthsbond
Beam elastic modulusEb
InterfacesNormal stiffnessknIf these values are not derived from tests on real joints, it is recommended that they are less than ten times the equivalent stiffness of interacting materials (Itasca 1998)

Table 3.2 Major Results for Case 1 (s=0.2 m, h=6.6 m, l=1.5 m) for Different FLAC Equilibrium Ratio Limits.
FLAC Equilibrium Ratio LimitNumber of StepsMaximum Displacement (cm)Maximum Axial ForceMaximum Connection Force
Value (kN)at Elevation (m)Value (kN)at Elevation (m)
0.014195384.46.021.24.831.2
0.0018828904.386.040.84.580.8

Table 3.3 Properties of Modeled Soil: Strength and Elastic Values.
ParameterSoil TypeComments
High Strength Soil (HS)Medium Strength Soil (MS)Low Strength Soil (LS)
Friction angle (deg)45 3525Model variable
Dilation angle (deg)1570
Cohesion (kPa)000

Initial modulus of elasticity (MPa)

606060Model variable
Poisson's ratio0.30.30.3Model variable
Density (kg/m3)220022002200

Table 3.4 Properties of Modeled Soil Stiffness.
ParameterSoil TypeComments
Baseline Stiff Soil (BSt)Very Stiff Soil (VSt)
Initial modulus of elasticity (MPa)6060Model variable
Stress-strain relationshipHyperbolic constitutive modelHyperbolic constitutive modelSee equation (3.2)
Hyperbolic model parameters:K270.2270200(Ling et al. 2000)
m0.50.5
Cohesion (kPa)01000

Table 3.5 Model Parameters and Properties of Facing.
ParameterValueComments
Height (m)0.2Fixed
Thickness (m)0.2Fixed
Density (kg/m3)2200Corresponds to dry cast concrete
Elastic modulus (MPa)600Model variable; ten times larger than initial
elastic modulus of soil; linear elastic
stress-strain relationship used
Poisson's ratio0.15Model variable

Table 3.6 Modeling of Reinforcement Stiffness.
FLAC Modeling ElementParameterReinforcement TypeComments
Baseline Reinforcement (BR)Ductile Reinforcement (DR)
CableArea (m2)0.0020.002Corresponds to rectangular cross section 0.002x1.0 m
Perimeter (m)2.02.0
Cable elastic modulus (kN/m2/m)106 (EA=2000 kN/m)105 (EA=200 kN/m)Model variable
Cable tensile yield strength (kN/m)200200
Grout shear stiffness (kPa)23077 (Equal to Initial Shear Modulus of Soil)2307.7 (Equal to 1/10 of Initial Shear Modulus of Soil)Model variable, characterizes soil- reinforcement interaction
Grout cohesive strength (kN/m)100100Model variable, characterizes soil- reinforcement interaction
Grout frictional resistance (deg)3535Characterizes soil- reinforcement interaction
BeamArea (m2)0.0020.002
Elastic modulus (MPa)1000100Model variable
Moment of inertia (m4)6.67x10-106.67x10-10Corresponds to cross section 0.002x1.0 m

Table 3.7 Modeling of Block-Block and Block-Reinforcement Interfaces.
ParameterConnection TypeComments
Frictional Connection: Low Strength (FCon–L)Frictional Connection: Baseline Strength (FCon–N)Structural Connection (SCon)
Interface friction angle (deg)203030
Interface cohesion (kPa)0020
Interface normal stiffness (kPa/m)285714285714285714Model variable, corresponds to bulk modulus of concrete blocks
Interface shear stiffness (kPa/m)230772307723077Model variable, corresponds to initial shear modulus of soil

Table 3.8 Parametric Study Cases.
CaseSpacing (m)Soil Type inReinforcement TypeConnection TypeComments
FoundationBackfillWall
10.2
0.4
0.6
0.8
1.0
HS
VSt
HS
BSt
HS
BSt
BRFCon–BBaseline case, s=0.2 m
20.2
0.4
0.6
0.8
MS
VSt
MS
BSt
MS
BSt
BRFCon–BBaseline case, s=0.6 m
30.2
0.4
0.6
0.8
LS
VSt
LS
BSt
LS
BSt
BRFCon–B
40.2
0.4
0.6
0.8
HS
BSt
HS
BSt
HS
BSt
BRFCon–B
50.2
0.4
0.6
0.8
MS
VSt
MS
BSt
MS
BSt
BRFCon–B
60.2
0.4
LS
BSt
LS
BSt
LS
BSt
BRFCon–B
70.2/0.6MS
VSt
MS
BSt
MS
BSt
BRFCon–BPrimary and secondary reinforcement
8–10.4HS
VSt
HS
BSt
HS
BSt
DRFCon–BBaseline case; modified case 1, s=0.4 m
8–20.4MS
VSt
MS
BSt
MS
BSt
DRFCon–BModified case 2, s=0.4 m
8–30.2LS
VSt
LS
BSt
LS
BSt
DRFCon–BModified case 3, s=0.2 m
90.2HS
VSt
HS
BSt
HS
BSt
BRFCon–LModified case 1, s=0.2 m
100.2
0.4
0.6
0.8
1.0
LS
BSt
HS
BSt
LS
BSt
BRFCon–BBaseline case, s=0.2 m
110.2HS
VSt
HS
BSt
HS
BSt
BRFCon–BZero dilation in soil, modified case 1, s=0.2 m
120.2HS
VSt
HS
BSt
HS
BSt
BRSCModified case 1, s=0.2 m
0.6MS
VSt
MS
BSt
MS
BSt
BRSCModified case 2, s=0.6 m

Table 3.9 General Information for Runs Corresponding to Failure States.
CaseSpacing (m)Height Hf (m)Ratio l/hfMaximum Displacement (cm)GridRun ime (h:min)Number of Steps
10.28.60.1764.0159x32150:28***1333201
0.48.20.1835.8159x32131:021388425
0.66.20.247.2159x32121:28726459
0.84.00.3820.3159x32114:26595810
12.00.7530.276x12114:09363452
20.26.60.2345.6159x32131:55*823024
0.46.00.2519.3159x32128:47*816555
0.64.60.3323.9159x32122:38874558
0.81.80.8341.5159x3219:39*425868
30.24.20.3612.8159x3217:06*277551
0.43.80.3932.3159x32111:49*397624
0.62.00.7525.5159x3215:37*229014
0.81.01.5036.5159x611:23116916
40.27.00.2117.0159x32161:38*1335795
0.46.00.258.1159x32144:50*1470381
0.65.40.2816.9159x32136:44*1417394
0.81.80.8324.9159x3219:37478677
50.25.40.2883.2159x32125:54*1139619
0.43.80.397.6159x32120:25*765764
0.62.40.6318.9159x32114:33689682
0.81.21.2514.9159x812:38261182
60.22.40.6310.8159x3219:28*398764
0.42.60.5833.6159x32115:47732546
70.6/0.26.00.2546.2159x18120:58*677419
8–10.48.00.19122.7159x22153:32*1884540
8–20.45.40.2861.5159x18115:18*999224
8–30.25.00.30100.8159x14128:30*1073006
90.28.20.1837.8159x20138:07*1018026
100.24.40.3432.5159x32125:29*852497
0.44.40.3433.8159x32129:44*1081140
0.62.80.5415.1159x32124:00645318
0.81.01.5016.5159x3213:45*187674
110.27.20.2141.8159x32134:271056557
120.29.40.1690.9159x321109:21**2447030
0.66.00.2559.7159x22130:30*985702

Table 3.10 General Information for Runs Corresponding to Critical States.
CaseSpacings (m)Height hcr (m)Ratio l/hcr Maximum DisplacementRun Time (h:min)Number of Steps
dmax (cm)dmax/hcr (%)
1 0.26.60.234.40.6526:05***419538
0.46.00.254.30.7213:17440688
0.64.60.333.10.677:31270338
0.82.60.582.20.853:46164679
11.01.500.30.300:0826118
2 0.25.40.284.90.9111:53*321545
0.44.40.343.30.749:21*286447
0.62.60.587.12.735:46248497
0.81.21.251.41.173:29*158139
3 0.24.00.386.61.657:36*227274
0.42.80.543.71.324:14*149751
0.61.60.943.11.942:43*111089
0.80.81.880.30.380:12*16816
4 0.25.60.275.20.9322:42*740862
0.45.20.295.51.0629:32*1055180
0.63.80.395.41.4215:29*668768
0.81.60.942.41.507:31*378577
5 0.24.20.365.51.3110:05*561957
0.42.80.544.11.4610:57*446741
0.61.21.251.51.252:03101856
0.81.01.508.58.501:36161082
60.22.00.753.01.505:49*259212
0.41.41.088.96.36***4:01203273
70.6/0.25.00.305.81.168:00*284651
8–10.45.00.307.31.4613:50*485049
8–20.43.20.475.21.633:54*173555
8–30.22.20.682.41.091:43*90776
90.26.60.235.60.8512:22*375455
100.23.20.473.71.169:28*360838
0.43.20.474.81.5012:48*514337
0.61.41.074.33.074:05212266
0.80.81.881.01.251:39*87574
110.26.00.255.20.8714:13455957
120.26.60.234.20.6410:34**573009
0.64.60.334.20.6410:54*388763
Previous    Table of Contents    Next

Federal Highway Administration | 1200 New Jersey Avenue, SE | Washington, DC 20590 | 202-366-4000
Turner-Fairbank Highway Research Center | 6300 Georgetown Pike | McLean, VA | 22101
