State of The Practice and Art for Structural Health Monitoring of Bridge Substructures

CHAPTER 4. I-35W BRIDGE FOUNDATION MONITORING

On August 1, 2007, the I-35W bridge over the Mississippi River in Minneapolis, MN, collapsed in the middle of rush hour. The collapse killed 13 people and revealed to engineers the United States’ failing infrastructure. Part of this study proposes that a catastrophe such as this may be prevented through the use of remote monitoring systems with the capability to alert users when certain structural members reach a predetermined level of stress. In order to fully understand the forces induced into a structure such as a bridge, the Minnesota Department of Transportation (MnDOT), FHWA, the USF Geotechnical Research Group, and Foundation & Geotechnical Engineering (FGE), LLC teamed to provide a remote monitoring system that would provide much of this information. As MnDOT rebuilt I-35W, a number of substructural members provided real-time information about the stresses on the bridge. Figure 45 shows the pier selected to demonstrate the monitoring system.

This illustration shows a bridge crossing the Mississippi River. The substructural health monitoring site is shown with a circle at the base of pier 2 in the southbound direction.
Figure 45. Illustration. I-35W bridge over the Mississippi River.

This study was broken into three phases: (1) real-time monitoring of the mass concrete effects in the drilled shaft foundation elements, (2) real-time monitoring of construction loads transmitted first into the drilled shafts and second into the columns as they came into play, and (3) long-term monitoring of the bridge loads and performance.

The first phase occurred during the construction of the concrete drilled shafts or caissons and the pier footing that ties the drilled shafts together. TCs were placed in the rebar cages of the shafts and throughout the pier footing and were used to determine the core temperatures of the mass concrete elements. This part of the study was similar to the voided shaft study that was discussed in chapter 3.

The second phase of the study slightly overlapped the first phase in that it involved the drilled shafts, but it also branched upward to the columns. Two different types of strain gauges were placed in the rebar cages of the shafts and at the center height of the columns. These were used to more accurately determine the load induced in the shafts by the pier footing, columns, superstructure, and the loads induced in the columns by the bridge superstructure during the bridge construction. Furthermore, as each new section of the concrete box-girder superstructure was added to the columns, the added weights of the sections were correlated to the strain in the columns measured by the installed gauges. This provided more accurate calibrations that were used in the ongoing health monitoring of the bridge, which was the third phase of the project.

The third phase uses the same strain gauges that were embedded in the shafts and columns,­ including the strain gauges that will be installed in the superstructure components of the bridge. The final phase of the project will monitor the loads on the bridge throughout its service life, which can be used to determine the structural health of the bridge and provide MnDOT and FHWA with real-time strain and load data from the bridge (see figure 46).

This illustration shows an event schedule with three project phases. The schedule and overlap of the I-35W bridge project phases include instrumentation and construction of the shafts, footing construction, column instrumentation and construction, and the subsequent superstructure construction. This is generally in reference to pier 2 and includes the final long-term health monitoring program after construction was completed.
Figure 46. Illustration. Event schedule and overlap of I-35W bridge project phases.

PHASE I-THERMAL MONITORING

As stated previously, in phase I, researchers monitored the internal temperatures of the mass concrete elements (drilled shafts and pier footing). While the overall procedure of the thermal monitoring was similar to the voided shaft study, there were some major differences. First, the shafts were solid and not voided. Second, the ambient temperature at the site was much different. As seen in figure 43 and °f = 1.8(°c) + 32 figure 44, in the Tampa Bay, FL, area during the monitoring period, the air temperature ranged from approximately 99.86 to 64.94 °F (37.7 to 18.3 °C). During the construction and thermal monitoring period in Minnesota, the temperature ranged from approximately 34.88 to -10 °F (1.6 to -23.3 °C). This was expected to have a significant effect on the temperatures reached by the mass concrete elements.

Construction and Instrumentation

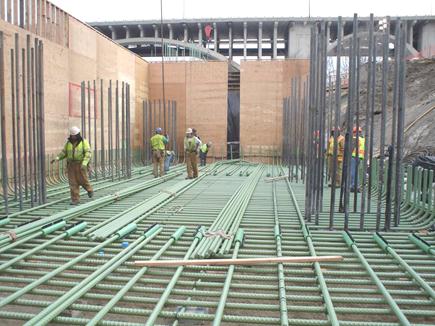

Prior to construction and installation of the drilled shafts, the instrumentation for the thermal monitoring was put into place. The first step of the placement was the instrumentation of the reinforcement cage for the drilled shafts. The reinforcement cage was built using high-strength longitudinal steel and mild stirrup steel. The cage had 2.48-inch (20.63-mm) threaded longitudinal bars with #6 bar circular ties at 5 inches (127 mm ) on the center. Locking wheel cage spacers were placed along the reinforcement cage to maintain 6 inches (152.4 mm) of clear cover (see figure 47).

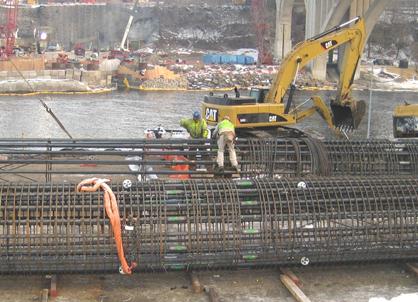

The photo shows the shaft reinforcement cage being constructed. The cages for pier 2 were fabricated along the excavation site. Pier 2 southbound and northbound cages were fabricated in the same area.
Figure 47. Photo. I-35W bridge shaft reinforcement cage construction.

After the reinforcement cages were assembled, they were instrumented with TCs and strain gauges. The strain gauges are discussed in the section on phase II. The TCs were installed in pairs at 4 levels along the shafts, later named GL1, GL2, GL3, and GL4, for a total of 10 TCs per shaft (2 TCs were installed in the center of the shaft near the top on a 20-ft (6.1-m) rebar placed after concreting). GL4 was located at the bottom of the shaft, GL3 was located at the top of competent rock, GL2 was located at the bottom of the permanent casing (top of weak rock), and GL1 was located at the top of the shaft (see figure 48). The wires from the TCs were bundled with the wires from the strain gauges and run to the top of the shafts in two groups (see figure 49).

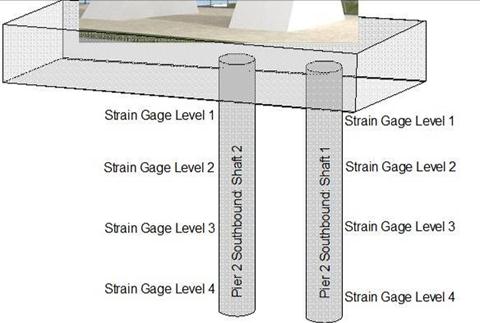

The shaft instrumentation plan is shown having four gauge levels on two drilled shafts, which include shafts 1 and 2 in the soutbound footing.
Figure 48. Illustration. I-35W bridge gauge levels on drilled shafts.

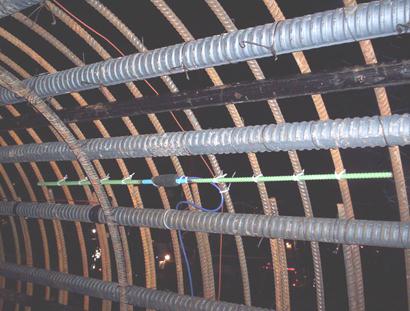

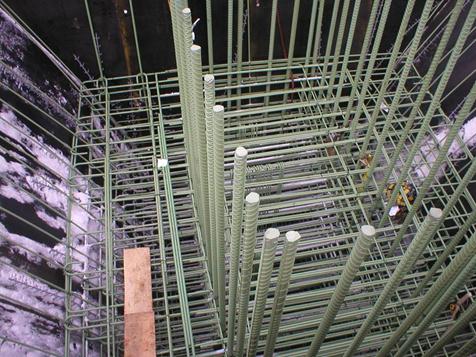

This photo shows the inside of the reinforcement cage. The instrumentation wire bundles are gathered together and run up opposite sides of the cage. Each gauge level contains four different locations roughly
Figure 49. Photo. Cable bundles in reinforcement cage for I-35W bridge.

After the cages were fully instrumented, the excavations for the shafts were made. The shafts were drilled with two distinct sections. The top section was 7 ft (2.1 m) in diameter with a 0.50-inch (12.7-mm)-thick permanent steel casing surrounded by soil (see figure 50). The casing was necessary to keep the excavation clear. The casing ran approximately 3 ft (0.92 m) below the level of bedrock. The lower section was 6.5 ft (1.9 m) in diameter with no steel casing. GL2, GL3, and GL4 were located in this lower section of the shaft. After the excavation was created, the reinforcement cages were lifted and lowered into the excavation (see figure 51). After reinforcement cage placement, the concrete for the shafts was poured with a single tremie. Upon removal of the tremie after concrete placement, a rebar instrumented with two additional TCs was inserted down the center of the shaft. The wires from all the TCs and strain gauges were run out through a 1.5-inch (38.1-mm)-diameter schedule 40 PVC conduit that was placed running out through the top of the shaft, underneath the future pier footing that would be constructed, and out to the DASs that were installed on site (see figure 52).

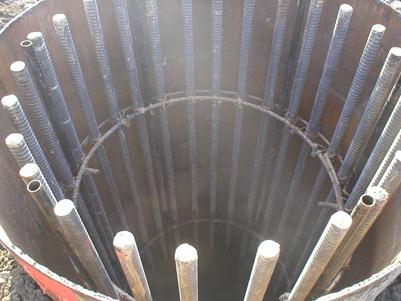

The photo shows the top section of the drilled shaft. The shaft reinforcing cages use 20 main bars and incorporate 6 access tubes for subsequent cross-hole sonic logging. Permanent casing is also used.
Figure 50. Photo. Top section of drilled shaft for I-35W bridge.

This photo shows an overview of the work site. The reinforcement cages for the I-35W bridge pier 2 bridge shafts (south side of river) were fabricated onsite (left-center) and hoisted by a crane for insertion into the excavation adjacent the river bank (right).

Figure 51. Photo. Placement of reinforcement cage for I-35W bridge shaft.

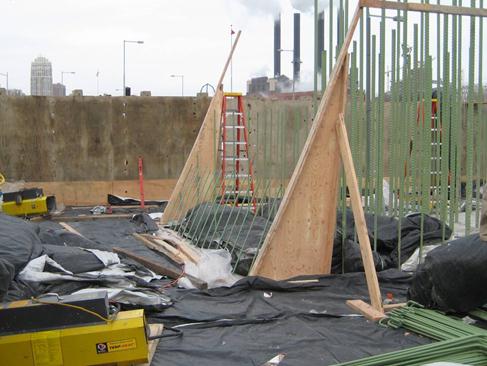

This photo shows four shafts. Conduits were placed on the ground at the base of the footing location prior to concreting that protected the instrumentation wiring running from shafts to data acquisition system (DAS) boxes located on the nearby covered fence. Note that only shaft 1 (left) and shaft 2 (right) were instrumented. Spacer blocks are shown on which the lowest level of footing reinforcement was to be placed. The main reinforcing bars from the shafts were left uncut to extend into the footing.
Figure 52. Photo. Conduits running from shafts to DAS boxes.

Two of the eight shafts were instrumented (see figure 52), and when all eight shafts were finished, time was alotted for the concrete to cure, the installation of the formwork, and reinforcement for the pier footing. The pier 2 footing was 81.02 ft (24.7 m) long by 34 ft (10.4 m) wide by 14 ft (4.8 m) tall (see figure 53) and was designed to support two columns (one for each concrete box girder section). It was reinforced with three layers of #18 bars at the bottom of the footing and three layers of #18 bars at the top. Along the top, W-shaped steel was used to support the reinforcing bars to prevent excess bending. TCs were installed at the base, the center, and the top of the footing. These TC wires were run out through a 2-inch (50.8-mm)-diameter schedule 40 PVC conduits down and out of the footing to the DAS boxes alongside the conduits from the shafts. The massive footing was equipped with PVC cooling tubes cast into the footing to help mitigate the mass concrete effects (see figure 54).

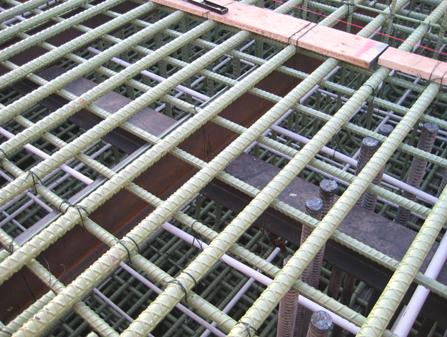

This photo shows the lower layer of pier footing reinforcement for the I-35W bridge. The reinforcement was placed such that the drilled shaft reinforcement could extend through into the core of the footing. The depth of the footing can be seen by the form work height (14ft (4.8 m)).
Figure 53. Photo. Lower layer of pier footing reinforcement for I-35W bridge.

This photo shows the upper layer of pier footing reinforcement for the I-35W bridge. There are steel beams attached to the drilled shaft reinforcement. Cooling tubes can also be seen running through the footing along with the footing reinforcement.
Figure 54. Photo. Upper layer of pier footing reinforcement for I-35W bridge.

Monitoring Setup and Procedure

For phase I of the study, the data collection was split into two subphases: the first phase consisted of the thermal monitoring of the shaft, and the second phase consisted of the thermal monitoring of the pier footing. The two phases were done similarly, and the setup for the thermal monitoring system was similar to the setup used in the voided shaft study discussed in chapter 3. The system was made up of the following pieces: a Campbell Scientific, Inc. ® CR1000 data logger, an AM25T 25-channel multiplexer, a Campbell Scientific, Inc. ® Raven100 CDMA AirLink cellular modem, PS100 12-V power supply and 7-Ahr rechargeable battery, and a large environmental enclosure to protect all the materials from the elements (see figure 55). From the voided shaft study, it was discovered that a larger solar panel was needed to provide power to the system. As a result, a 35-W solar cell panel was utilized (see figure 56).

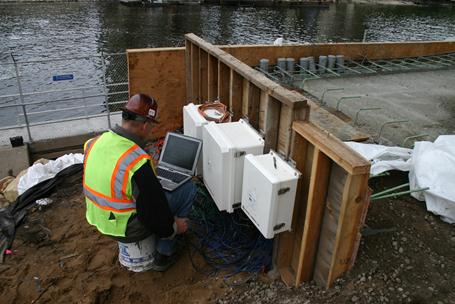

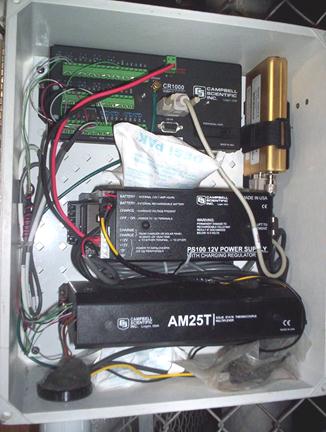

This photo shows the components of the data acquisition system (DAS) mounted to the covered fence. It includes a data logger, modem, power supply, multiplexer, and desiccant.
Figure 55. Photo. Thermal monitoring DAS for I-35W bridge shafts.

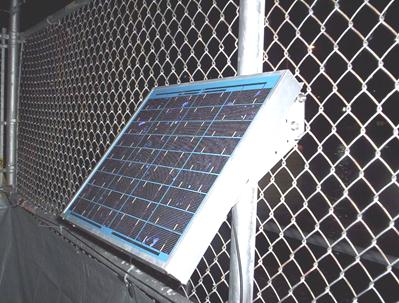

This photo shows a large 35-W solar cell panel used for this project. The panel was positioned along the edge of the construction site on the adjacent fence line to avoid interference with construction.
Figure 56. Photo. 35-W solar cell panel for I-35W bridge monitoring system.

The thermal monitoring procedure was identical to that of the voided shaft study. A thermal data sample was taken every 15 min and stored to the data logger at the same interval. Every hour, the Raven modem sent the collected data to the host computer at USF for data analysis. Once this data were received, they were automatically interpreted and plotted for use on the USF Geotechnical Research Web site. This thermal data from the shafts were collected from January 9 through January 21, 2008. At this time, the TC wires from the shaft were disconnected; however, the vibrating wire strain gauges (discussed in phase II) came with a thermistor. This thermistor was used to continue the thermal data from the shafts. The thermal data from the pier footing were collected from February 6 through February 25, 2008. No strain gauges were installed in the pier footing, so the only thermal data collected were stopped after this date. As with the voided shaft study, the battery voltage for the data logger was also monitored so that the logger did not lose power.

Along with the thermal monitoring setup, a CC640 camera was set up to take hourly photographs of the construction site (figure 57 and figure 58). (Note that the black bars in figure 57 are pointing to the camera.) It was powered by the same solar panel as the thermal monitoring system. The photos taken by the camera were sent back with the data collected from the TCs by the CR1000. The camera was useful for the thermal monitoring phase, but it was really installed as an aid in the construction load monitoring phase, which is discussed later.

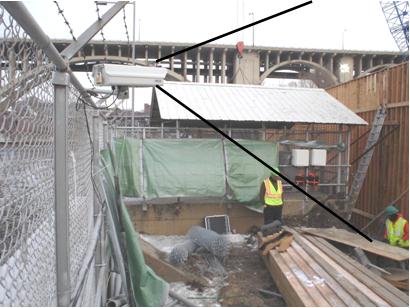

This photo shows the CC640 onsite camera, which was mounted with a perspective that enabled the remote overseers to identify construction activities that corresponded to observed data trends.
Figure 57. Photo. CC640 jobsite camera with perspective outlines.

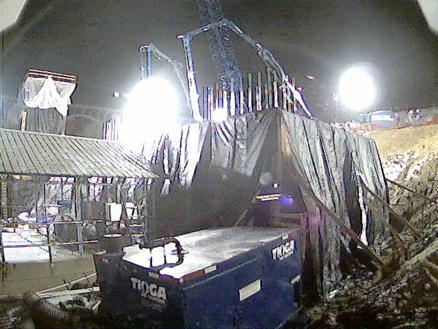

This photo shows a sample camera shot from the close-up onsite camera adjacent pier 2 to show the limits of the CC640 camera perspective. All images were stamped with time and date for correlation to data events registered simultaneously by strain gauges.
Figure 58. Photo. Sample camera shot from close-up camera on I-35W bridge.

System Results and Conclusions

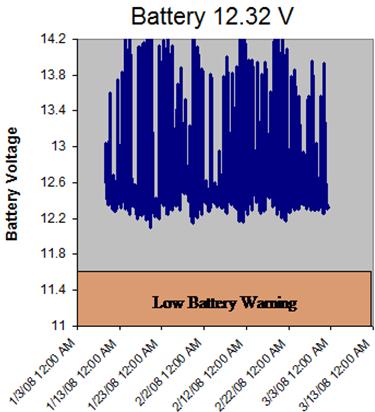

The thermal monitoring procedure fared well. From the information gathered from the voided shaft study about the power consumption, the 35-W solar cell panel worked much better, and the battery voltage never dipped below 12V (see figure 59). Twice during the thermal monitoring phase, the system lost and then regained cellular communication with the host server. These occurrences seemed to correspond with the use of a large electric power plant directly adjacent the system’s cellular modem. This type of EMF is known to adversely affect such systems and is therefore a reasonable explanation. Other than these interferences, the thermal monitoring system worked as planned.

This figure shows a line chart with battery voltage level on the y-axis from 11 to 14.2V and the times and dates the levels were measured on the x-axis from January 3, 2008, to March 13, 2008. The data logger battery voltage was monitored to assure no breaks in the power. At no time did the power fall to an unsafe level. The fluctuations shown in the graph are in direct result of the solar activity on site.
Figure 59. Graph. Data logger battery voltage from I-35W bridge monitoring system.

The concrete mix that was used was self-consolidating concrete that was designed to have a lower heat of hydration (see figure 60). Therefore, the temperature traces were expected to be lower than that of the voided shaft study. The thermal data from shaft 1 showed that the general average temperature attained in the concrete was 89.96 °F (32.2 °C) in the cage, and the two TCs at the core recorded higher temperatures of 125.96 °F (52.2 °C), which was a 36-°F (20-°C) difference (see °f = 1.8(°c) + 32 figure 61). Similarly, in shaft 2, the TCs mounted in the cage recorded an average temperature of 84.92 °F (29.4 °C), while the two TCs at the core recorded a higher temperature of 109.94 °F (43.3 °C), which was a 25-°F (13.9-°C) difference (see figure 62).

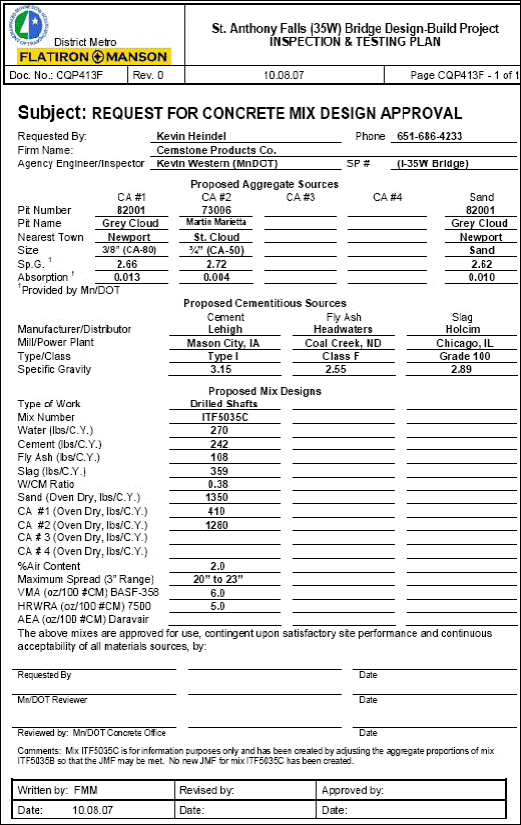

This figure shows a proposed concrete mix design as part of an inspection and testing plan. It shows the proposed aggregate sources, the proposed cementitious sources, and the proposed mix designs. The concrete mix design is important to the prediction of internal temperature of curing concrete. The mix design used for drilled shafts on the I-35W bridge was a self-consolidating concrete mix and was adjusted to minimize unwanted mass concrete effects.
Figure 60. Diagram. Concrete mix design for drilled shafts on I-35W bridge.

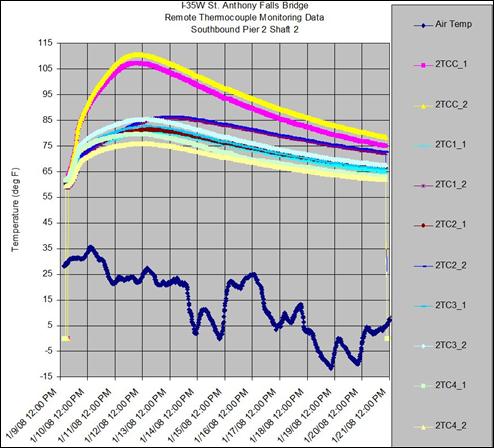

The figure shows a wire contour graph with temperature on the y-axis from -15 to 125 ï‚°F (-26.11 to 51.67 ï‚°C) and the dates and times of the measurements on the x-axis from January 10, 2008, to January 21, 2008. The colored lines represent the different thermocouples. The I-35W pier 2 shaft 1 temperature measurements showed a peak temperature of 125.96 ï‚°F (52.2 ï‚°C) (at the core near the surface) and a minimum temperature at that elevation of 89.96 ï‚°F (32.2 ï‚°C) (in the cage) at the same time. This translated into a peak differential temperature of 36 ï‚°F (20 ï‚°C).
°F = 1.8(°C) + 32

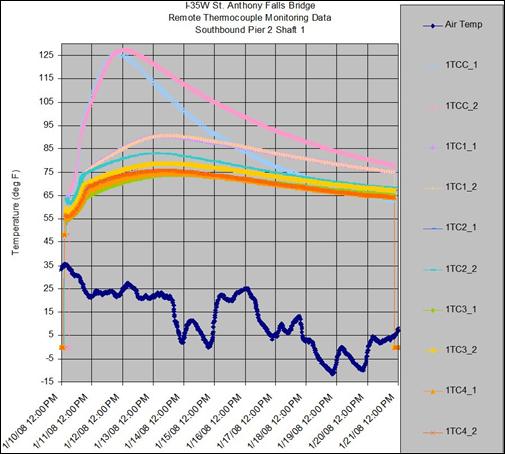

Figure 61. Graph. I-35W bridge southbound pier 2 shaft 1 thermal data.

The figure shows a wire contour graph with temperature on the y-axis from -15 to 115 ï‚°F (-26.11 to 46.11 ï‚°C) and the dates and times of the measurements on the x-axis from January 9, 2008, to January 21, 2008. The colored lines represent the different thermocouples. The I-35W pier 2 shaft 2 temperature measurements showed a peak temperature of 109.94 ï‚°F (43.3 ï‚°C) (at the core near the surface) and a minimum temperature at that elevation of 84.92 ï‚°F (29.4 ï‚°C) (in the cage) at the same time. This translated into a peak differential temperature of 25 ï‚°F (13.9 ï‚°C).
°F = 1.8(°C) + 32
Figure 62. Graph. I-35W bridge southbound pier 2 shaft 2 thermal data.

As discussed in the monitoring procedure, the TC wires from the shafts were cut on January 21, 2008, and the thermal data were no longer collected. Upon connection of the vibrating wire gauges from the shafts, the thermistors started to collect thermal data again. These thermal data were analyzed and compiled with the data from the TCs, and the continuation of the thermal curves were plotted (see figure 63 and figure 64).

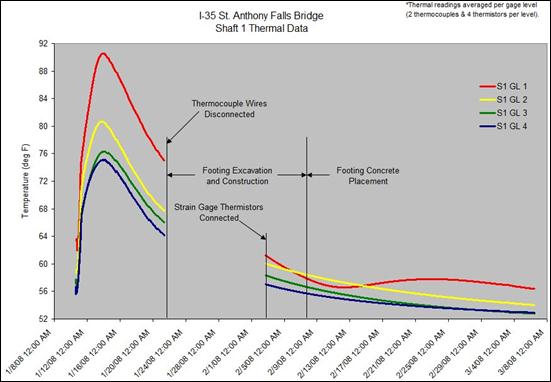

This figure shows a line graph of the I-35W bridge shaft 1 thermal data from thermocouples (TCs) and thermistors. Temperature is on the y-axis from 52 to 92 ï‚°F (11.11 to 33.33 ï‚°C) and the dates and times of the measurements are on the x-axis from January 8, 2008, to March 8, 2008. The colored lines represent the different gauge levels. Temperature measurements from gauge level thermistors of shaft 1 of pier 2 are plotted over the time period of shaft construction, footing construction, and footing curing. No data were collected during the lead wire conduit placement because all gauges were disconnected over this time period. The heat of curing concrete placed for the footing can be seen affecting the temperature in the upper most elevation of the shaft. The concrete temperature in the upper most gauge level (S1 GL1) is significantly higher when compared to shaft 2 (S2 GL1) in figure 64.
°F = 1.8(°C) + 32
Figure 63. Graph. I-35W bridge shaft 1 thermal data from TCs and thermistors.

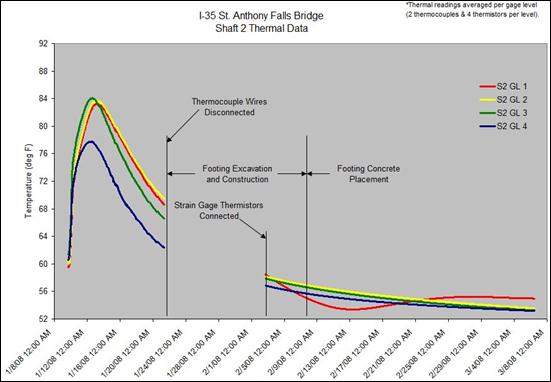

This figure shows a line graph of I-35W bridge shaft 2 thermal data from thermocouples (TCs) and thermistors. Temperature is on the y-axis from 52 to 92 ï‚°F (11.11 to 33.33 ï‚°C), and the dates and times of the measurements are on the x-axis from January 8, 2008, to March 8, 2008. The colored lines represent the different gauge levels. Temperature measurements from gauge level thermistors of shaft 2 of pier 2 are plotted over the time period of shaft construction, footing construction, and footing curing. No data were collected during the lead wire conduit placement because all gauges were disconnected over this time period. The heat of curing concrete placed for the footing can be seen affecting the temperature in the upper-most gauge level of the shaft.
°F = 1.8(°C) + 32
Figure 64. Graph. I-35W bridge shaft 2 thermal data from TCs and thermistors.

As stated previously, the thermal data from the pier footing was collected from February 6 through February 25, 2008 (see figure 65). As seen on the plot of the temperature over time, the TC in the extreme center of the footing recorded a maximum temperature of approximately140 °F (60 °C), while the TC at the center bottom of the footing only reached a temperature of approximately 90 °F (32.2 °C). The same concrete mix was used throughout the pier footing, so it should all have been roughly the same temperature; however, the ambient temperature, which ranged from 40 to -10 °F (4.4 to -23.3 °C), caused the temperatures to drop drastically closer to the outside edges of the footing.

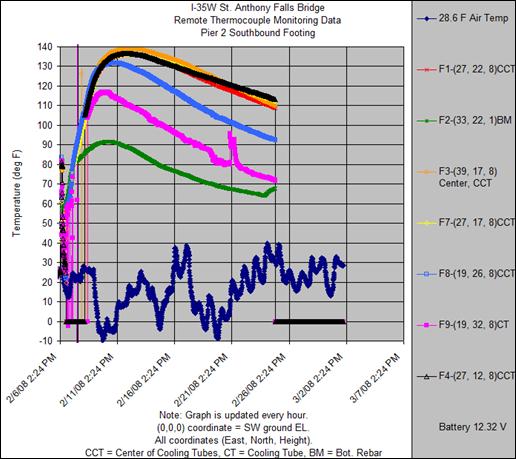

The figure shows a wire contour line graph of pier 2 southbound footing thermal data from thermocouples (TCs). Temperature is on the y-axis from -10 to 140 ï‚°F (-23.33 to 60 ï‚°C), and the dates and times of the measurements are on the x-axis from February 6, 2008, to March 7, 2008. The TC in the extreme center of the footing recorded a maximum temperature of approximately 140 ï‚°F (60 ï‚°C), while the TC at the center bottom of the footing only reached a temperature of approximately 90 ï‚°F (32.2 ï‚°C). The same concrete mix was used throughout the pier footing, so it should all have been roughly the same temperature; however, the ambient temperature, which ranged from 40 to -10 ï‚°F (4.4  to -23.33 ï‚°C), caused the temperatures to drop closer to the outside edges of the footing.
°F = 1.8(°C) + 32
Figure 65. Graph. Pier 2 southbound footing thermal data from TCs.

PHASE II-CONSTRUCTION LOAD MONITORING

This phase of the study expands from the voided shaft study. In phase II, the loads placed on the shafts by the pier footing, columns, and segments of the superstructure were monitored. As shown in figure 46, this phase actually began at the start of the footing construction, but no data were expected until the shaft cured and the footing concrete was poured.

For the section on construction and instrumentation, there was obviously an overlap with the construction sequence. Therefore, this section of the report does not go into detail about the construction of the drilled shafts nor of the pier footing. However, more emphasis is placed on the strain gauges that were installed in the drilled shafts. For the pier columns, however, the construction and instrumentation is explained. Focus is provided to the construction phases of the column and how it affected the construction loads placed on the drilled shafts.

Construction and Instrumentation

The strain gauges used in this study were provided by Geokon, Inc.. They were model 4911 “sister bars” and were specifically made for ease of installation (see 1 inch = 25.4 mm figure 66). They came with the strain gauge preinstalled on a 54.25-inch (1,377.95-mm) length of #4 bar. This bar was then tied to the existing reinforcement in the shaft or column. Since the gauge was on a #4 bar, it did not provide enough extra steel area that the cross section of the element was altered (providing the element was quite large). Therefore, it only minimally affected the calculations of converting strain to load. The strain gauges in the shafts were installed at the same four levels as the TCs: GL1, GL2, GL3, and GL4 (see figure 48). However, two types of strain gauges were used. At each level, 4 vibrating wire (VW) strain gauges and 2 resistance (RT) strain gauges were installed, which made for a total of 16 VW gauges and 8 RT gauges per shaft. The VW gauges were installed at a 90-degree separation (see figure 67), with the RT gauges at 180-degree separation coupled with the VW gauges (see figure 68). The VW gauges, as explained in phase I, came equipped with a thermistor. These gauges were not capable of recording strains at high rates (for dynamic measurements), which was why RT gauges were also installed.

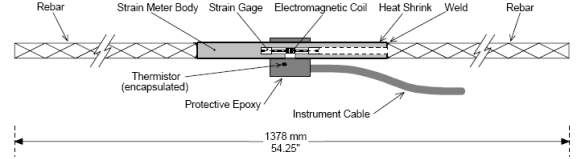

This figure shows a vibrating wire sister bar strain gauge, which includes a length of rebar on the left and right ends welded to the strain meter in the center. The strain meter is shown with three primary components: (1) the strain gauge which is a taught wire, (2) an electomagnetic coil which serves two functions to both pulse or “pluck� the wire and to monitor the resulting frequency, and (3) a thermistor which measures the internal temperature of the gauge. As the tension in the wire is affected by temperature, the frequency must be corrected for temperature-induced strain using the measured change in resistance of the encapsulated thermistor. The entire strain meter is covered in a water-tight heat shrink seal.
1 inch = 25.4 mm
Figure 66. Illustration. Detail of Geokon, Inc.TM 4911 sister bar strain gauges.

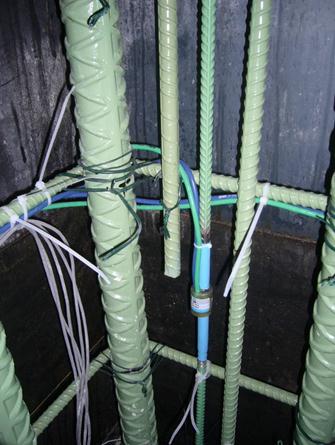

This photo shows a vibrating wire (VW) gauge installed in the reinforcement cage. Two different types of sister bar-mounted strain gauges were used: VW (shown with the blue lead wire) and resistance gauges (not shown).
Figure 67. Photo. VW gauge installed in shaft reinforcement cage.

This photo shows the vibrating wire (VW) and the resistance (RT) gauges installed on the reinforcement cage. Two different types of sister bar-mounted strain gauges were used: VW (blue lead wire) and RT gauges (green lead wire). For this application, both types of gauges were bonded to the same sister bar for convenience. The cage wiring provided sufficient slack so that potential racking of the cage during lifting would not pull the wires out of the gauges.
Figure 68. Photo. Coupled VW (blue cable) and RT (green cable) gauges.

At each main pier, two reinforced concrete columns sat on top of the footing to support the superstructure for one direction of traffic. The columns were constructed with a varying cross section (see figure 45). The critical cross section was at the midheight of the columns where the strain gauges were placed. The columns were cast in three separate pours.

First, the longitudinal bars running up through the columns were spliced to the longitudinal bars embedded in the pier footing (see figure 69). Then, the formwork for the lower half of the column was set in place. The first pour was a small 200-yd3 (182.8-m3) pour to get the column started. After that, the horizontal reinforcement was set inside the formwork up to the midheight of the column. After the horizontal steel was in place, the next level of longitudinal steel was spliced to the first level so that the bottom of the bars were embedded in the lower half of the column. After the reinforcement up to midheight was installed, the second pour occurred. This second pour placed the concrete up to midheight of the column (see figure 70). During the next phase of construction, the formwork for the top half of the column was placed, and the horizontal steel in the column was installed. The column midheight strain gauge installation also took place at this time. The critical section of the column was 8 by 16 ft (2.44 by 4.88 m) with reinforcement that consisted of 44 #20 bars (see figure 71).

This photo shows reinforcement for the first column pour for I-35W bridge columns. The columns cast onto the footing were constructed in three steps. The lower-most phase is shown being formed. The black plastic at the base of the column covers the footing, providing a thermal insulation to avoid unwanted differential temperature induced stresses. The first level of each column totals 200 yd3 (153 m3) of concrete.
Figure 69. Photo. Reinforcement for first column pour for I-35W bridge columns.

This photo shows reinforcement at the midsection of one of the columns for the I-35W bridge. The midlevel of the columns were cast in preconstructed forms that were set in place and supported. Connections for the rebar to the upper level extend out of the interior column portion of pier 2 (southbound).
Figure 70. Photo. Reinforcement at midsection of columns for I-35W bridge.

This photo shows longitudinal and horizontal column reinforcement. The reinforcement extending from the midsection of the column is shown from the top view with the uppermost formwork in place (black). Multiple levels of transverse steel were installed in both directions. Snow lines the inside of the upper column formwork.
Figure 71. Photo. Longitudinal and horizontal column reinforcement.

The total instrumentation for each column consisted of four vibrating wire strain gauges and four resistance-type strain gauges. The same coupled gauges that were installed in the shafts were used in the columns (one VW gauge and one RT gauge per sister bar). One sister bar unit was installed at each corner of the column in the critical section (see figure 72). By placing the gauges in the corners of the cross section, the strain at the extreme fiber of the column could be measured. Once the gauge installation units were tied and secured in place (see figure 73), the wires were run out of the top of the column formwork so that the cables could be bundled together. Then, the wires were brought back down to the midsection of the column and were run out through the 2-inch (50.8-mm) schedule 40 PVC conduit that extended up to the midheight of the columns (see figure 74). The wires ran through the conduit, down the column and shaft cap, and out to the temporary DAS that was installed on site. In addition to these strain gauges, the University of Minnesota Department of Civil Engineering also placed five strain gauges in each column that was installed in the same locations as those done by the FHWA team, but with an additional gauge located in the center of the column. The wires for these gauges were bundled with the wires from the FHWA gauges and pulled out to the DAS at the same time. These cables were grey (as opposed to blue and green used by FHWA) and can be seen clearly in figure 74. No presentation or analysis of the University of Minnesota gauges is presented herein.

The photo shows the corner of one of the columns. At the bottom of the upper-most portion of the column where the column is smallest (midheight), dual mode strain gauges were installed at each of the four corners. The green and blue wires represent the resistance and vibrating wire type gauges, respectively.
Figure 72. Photo. Coupled gauge installed in corner of column of I-35W bridge.

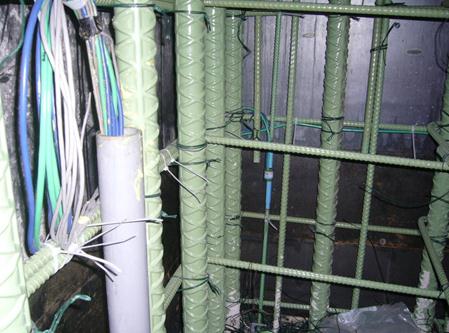

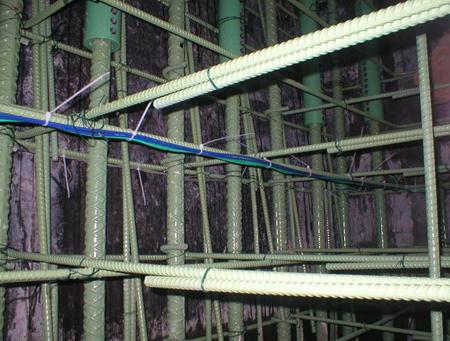

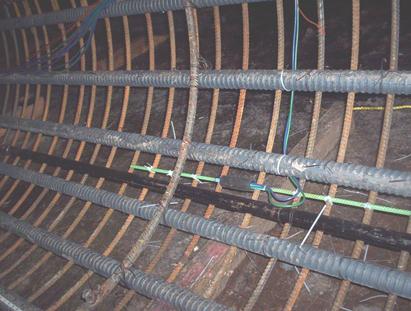

This photo shows gauge wires tied and secured inside a column. The lead wires from each set of corner gauges were carefully routed around the perimeter of the reinforcing cage to a prescribed exit point where a conduit was previously positioned.
Figure 73. Photo. Gauge wires tied and secured in column of I-35W bridge.

The photo shows the gauge wires exiting the conduit. All wires from the midlevel gauges were routed through the conduit provided to the base of the column where the data loggers were temporarily mounted.
Figure 74. Photo. Wires exiting through conduit.

Monitoring Setup and Procedure

For phase II of the study, the data collection was split into two subphases: the load monitoring of the shaft and the load monitoring of the columns. The reason for this split was that a large amount of dead load on the shaft came from the construction of the pier footing and the columns. Furthermore, if the loads on the shafts were monitored first, checking that the measured loads were correct was much easier because the load was simply the dead load of the footing and columns. Each phase of monitoring was carried out in the same way. The monitoring setup and procedure is explained through a discussion of the three different systems that were installed and used during this phase of the study.

System 1 was the same thermal monitoring system that was used in phase I of the study as well as the voided shaft study discussed in chapter 3. It was reused during this phase of the study as the monitoring and transmission system for the CC640 field camera. The camera was set up to take a picture every hour and then transmit that picture back to the host computer via the cellular modem. During the thermal monitoring phase of the study, system 1 was powered by the installed solar cell panel with a backup deep cycle battery. During phase II, the system was moved to alternating current (A/C) power, but a deep cycle battery was kept in reserve in case the A/C power was disrupted. This A/C power was provided by the U.S. Army Corps of Engineers who had an A/C power source adjacent the site.

The second and third systems were installed at almost the same time, but they had different capabilities and assignments. System 2 was designated to collect data from the vibrating wire gauges installed in shafts 1 and 2 as well as those in the interior and exterior columns. This system also recorded the gauge temperatures via changes in thermistor resistance. A total of 50 vibrating wire gauges and 50 thermistors were connected to this logger via two AVW200 two-channel spectrum analyzers. Each channel of the AVW200 units was connected to a low-power multiplexer (MUX) 16/32B (four in all). MUX 1 was connected to shaft 2 (16 gauges), MUX 2 was connected to shaft 1 (16 gauges), MUX 3 was connected to the interior column (10 gauges), and MUX 4 was connected to the exterior column (10 gauges) (see figure 75). The true value of the AVW200 data was unused because many pieces of data quality were recorded along with the raw strain and temperature values of interest. These additional measures of data quality (e.g., signal-to-noise ratio, etc., four total) were intended to provide insight into the health of the gauge and triple the required storage space and to significantly reduce the overall duration of monitoring without remote collection from the circular data buffer. At the rate of storage, the number of channels monitored, and amount of on-board memory, only a 2-week period could be stored before circular overwrite. However, with hourly collections, this was never a problem.

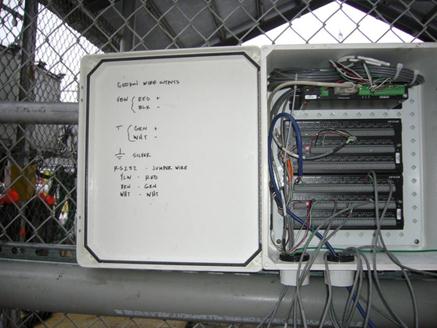

This photo shows the wire connection to system 2. The enclosure does not contain a data logger but rather two multiplexers (middle and bottom) and one two channel vibrating wire spectral analyzer (top).
Figure 75. Photo. Wire connection to system 2.

The system monitoring the VW gauges (system 2) used a Campbell Scientific, Inc. ® CR1000 data logger, while the system monitoring the RT gauges (system 3) used a Campbell Scientific, Inc. ® CR9000 data logger. System 2 worked similarly to the thermal monitoring system. A sample was taken and stored to the data logger every 15 min. Every hour, this stored information was sent back to the host computer at USF to be compiled and analyzed. System 3 took a sample at a rate of 100 Hz (100 samples per second). However, all of the data were not stored. Rather, the mean, maximum, and minimum of these samples were stored every 15 min. Then, every hour, the stored data points were sent back to the host computer similar to the data from system 2. This provided the user with a better idea of the strain in the system because of the high sampling rate. However, this method used a large amount of power. The monitoring system sampling and storage rates and other information are provided in table 2. Due to differences in the two DAS board configurations, each system had a dedicated Campbell Scientific, Inc. ® Raven100 CDMA AirLink cellular modem. Three large environmental enclosures were used to house and protect the DAS units and wire connections from the elements (see figure 76).

Table 2. Summary of monitoring systems for I-35W bridge monitoring study.

System Parameter

System 1

System 2

System 3

Gauge type

TCs

VW strain gauges thermistors

RT strain gauges

Data logger

CR1000

CR1000

CR9000

Sampling rate

15 min

15 min

100 Hz

Storage rate

15 min

15 min

15 min (sample mean, sample max, and standard deviation)

Transmit rate

1 h

1 h

1 h

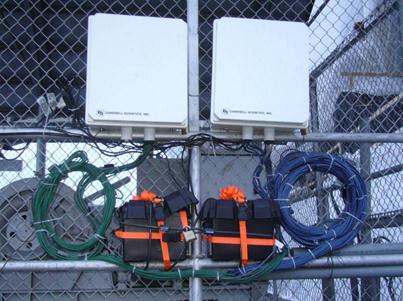

The photo shows two of the three environmental enclosures used to house the monitoring systems. The construction load monitoring systems with both types of gauges: (1) vibrating wire (VW), which were blue and (2) resistance (RT), which were green, were installed temporarily on a nearby fence.
Figure 76. Photo. Construction load monitoring systems (VW = blue (right) and RT = green (left)).

For this phase, it was known that a large amount of power would be consumed by the monitoring systems. Therefore, it was necessary to provide the systems with enough backup power to prevent power problems similar to the voided shaft study. Each system was integrated with a deep cell battery that provided power in case of a power failure (see figure 76). However, there was a problem with this system; the PS100 12-V power supply that recharges the 7-Ahr battery could only receive power from either an A/C source or the solar panel but not both. Therefore, a battery manager was installed to bypass this limitation.

As with the thermal data from the shafts, once these data were received and reviewed, researchers plotted the data online at http://geotech.eng.usf.edu/I35.html. The strain in the shafts at the four different levels was monitored beginning on February 6, 2008, with the pier footing concrete placement. The strain data from the shafts were computed into construction loads, and an annotated graph was updated online (see 1 kip = 454 kg, 1 yd = 0.914 m, 1 ft = 0.305 m, figure 77). Along with this graph, pictures from these events were captured using the CC640 field camera, and they could be related to the points of interest on the graph. This aided in verifying the loading event and the amount of load that was calculated in the shaft (see figure 78 through figure 81).

The figure shows a line graph with the loads on the y-axis from 0 to 800 kips (0 to 363,200 kg) and the dates and times of the measurements on the x-axis from February 6, 2008, to February 19, 2008. The colored lines represent the different gauge levels. Shaft construction loads were monitored continuously along with photo documentation to discern various construction events. The load of the footing concrete, although simultaneously supported by the shafts and the ground surface, induced load into the shafts.
1 kip = 454 kg
1 yd = 0.914 m
1 ft = 0.305 m

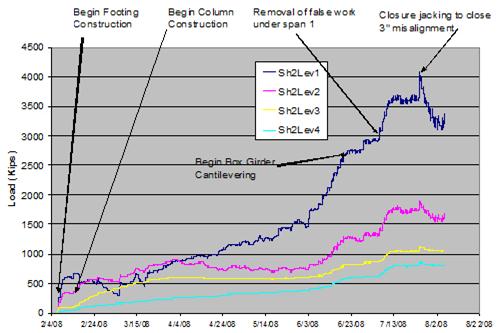

Figure 77. Graph. Shaft construction loads and events.

This photo shows pier footing concrete placement. Two pump trucks were used to place the 1,445-yd3 (1,105-m3) of concrete.
Figure 78. Photo. Pier footing concrete placement.

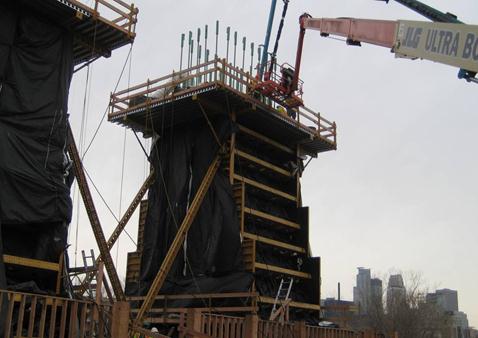

This photo shows lift 1 column concrete placement upon completion of the footing concreting and sufficient curing. This formwork as well as the reinforcing steel can be seen above the plastic-wrapped footing.
Figure 79. Photo. Lift 1 column concrete placement.

This photo shows the previously assembled and reusable column formwork (second level) as it was placed on the interior column of pier 2 southbound. The forms were heavy enough to be seen on strain records associated with that time.
Figure 80. Photo. Interior column lift 2 formwork placement.

This photo shows the placement of the previously assembled and reusable column formwork (second level)  on the exterior column of pier 2 southbound. The forms were heavy enough to be seen on strain records associated with that time.

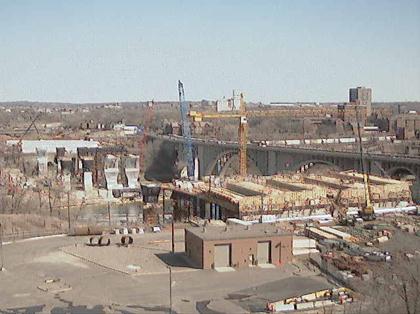

Figure 81. Photo. Exterior column lift 2 formwork placement.

As seen in figure 81, the column foundation became too large to view in its entirety by the close-up camera location. Therefore, the CC640 field camera was moved to a new location on top of the University of Minnesota BOBMAIN building on the southwest bank of the river. This new position afforded oversight of the entire project from end bent to end bent and was used to dovetail recorded strains to construction events (see figure 82).

The figure shows the new perspective for the CC640 field camera located on top of an adjacent University of Minnesota building. The I-35W bridge is visible under construction.

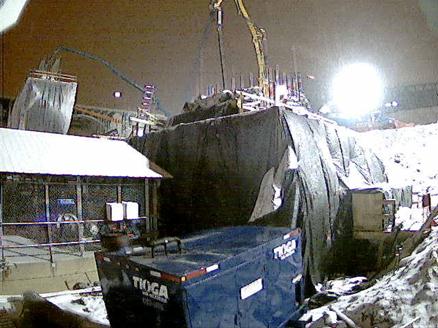

Figure 82. Photo. New perspective from CC640 field camera.

System Performance

The three monitoring systems used during the construction load monitoring phase fared well. System 1 lost and then regained communication with the host server twice. These occurrences seemed to correspond with the use of a large electric power plant directly adjacent the system’s cellular modem. This type of EMF was known to adversely affect such systems and was therefore a reasonable explanation. As stated in the monitoring procedure, system 1 was repositioned in early March 2008. This system worked without issues from March 5, 2008, to March 19, 2008, when communication between the camera and logger failed. Review of the system revealed the camera was still recording images to its internal compact flash card, but images were not transferred to the logger for scheduled collection. Subsequent baud rate reduction cleared the problem.

As stated in the monitoring procedure, power consumption was a large concern for this phase of monitoring. The power of system 1 was stable throughout this phase. The system was originally completely powered by solar energy, and a deep cycle battery was used as a backup. In early March 2008, the power source was switched to constant A/C (with battery backup) and provided the system with more stabile voltage (see figure 83). At no time did the voltage approach the critical logger shutdown voltage. Results of both the close-up pictures and the overview pictures are shown in figure 78 through figure 82.

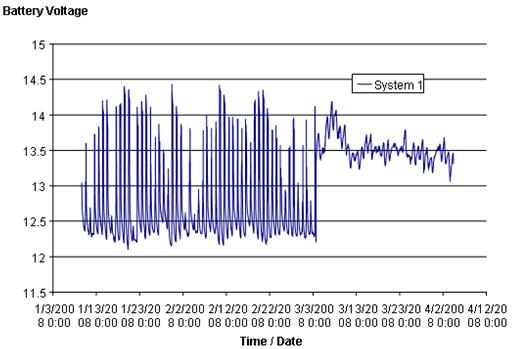

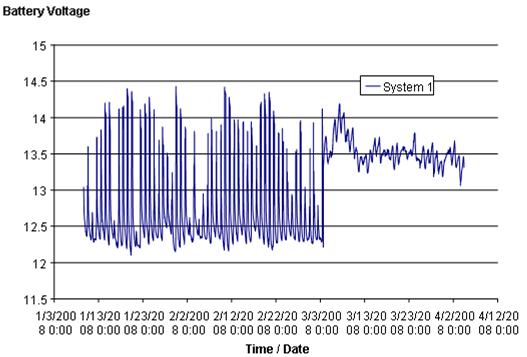

This line graph shows system 1 battery voltage over time. Battery voltage level is on the y-axis from 11.5 to 15V, and the times and dates the levels were measured are on the x-axis from January 3, 2008, to April 12, 2008. Daily solar energy fluctuations can be seen for the first 2 months, after which, the system was connected to an alternating current power source which caused the observed stabilization of power.
Figure 83. Graph. System 1 battery voltage over time.

The results of system 2 were a little less desirable. The cellular communication with this system became somewhat of a concern with regards to reliability. This system, which was similar to system 1, logged data that were collected without issue from February 5 through March 26, 2008. For a short period following this time frame, no collections were possible. It was unclear whether the system was still powered and logging; however, up until the last collection, the power cycles were regular (see figure 84). Since the critical threshold voltage of 11.2V was not approached at any time, it was unlikely that power interruption was the cause of the communication errors. The concern with the intermittent communication was resolved, but the data collected from one of the four multiplexing units responsible for monitoring nine of the vibrating wire gauges were unintelligible. An onsite visit was required to find a partially cut wire between the MUX unit and AVW-200, and it had started as intermittent and ultimately resulted in complete failure. Simple repair of this connection resumed full operation; data from this time period were not obtained from those gauges.

This line graph shows system 2 battery voltage over time. Battery voltage level is on the y-axis from 11.5 to 15V, and the times and dates the levels were measured is on the x-axis from January 3, 2008, to April 12, 2008. The power source for system 2 was a hybrid of both solar and alternating current, as well as a deep cell storage battery. The baseline voltage under this configuration remained above 13.6V.
Figure 84. Graph. System 2 battery voltage over time.

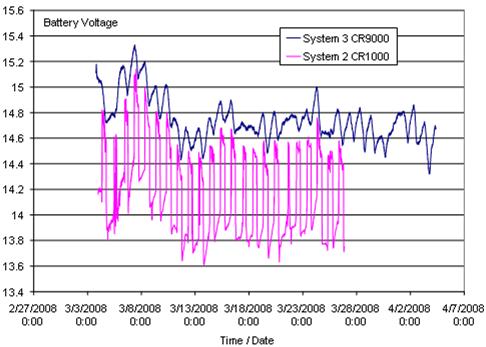

The results of system 3 were better than those of system 2 because communication never faltered. The primary difference between this system and the other two was the logger type, CR9000 versus CR1000, the latter of which had not been consistent. The battery voltage of system 3 varied less than the battery voltage of system 2, yet neither system exhibited a power disruption (see figure 85).

This line graph shows system 2 versus system 3 battery voltage. Battery voltage level is on the y-axis from 13.4 to 15.6V, and the times and dates the levels were measured are on the x-axis from February 27, 2008, to April 7, 2008. The pink line represents system 2, and the blue line represents system 3. Both systems used the hybrid power scheme. However, smaller fluctuations in voltage were observed in system 3 when compared to system 2.
Figure 85. Graph. System 2 versus system 3 battery voltage.

Once a sufficient amount of data were collected, the host Web site for the data review was modified to include hover points associated with pathways to videos or data locations (see figure 86). The link to the south camera perspective takes the user to a page that shows a video made of time lapse photos taken by the CC640 field camera in its altered position atop the University of Minnesota building. The link to the west camera allows users to navigate to a page that shows a video made of time lapse photos taken from the Web camera set up by MnDOT. The pier 2 close-up camera link shows a video made of time lapse photos taken by the CC640 field camera in its original close-up position. All of these videos provide a quick look at the construction progress of the bridge from different vantage points and were used to relate the strain data to specific construction events. The FHWA SSHM site link (http://geotech.eng.usf.edu/I35.html) takes users to a separate page with a close-up view of the site with more hover points (see figure 87). Each link takes users to a plot of the strain of that subject over time (see figure 88 through figure 91). These graphs were broken down into daily increments as shown by the dotted lines running vertically on the graphs. The spaces between these dotted lines are links that take users to the pages with the Web cameras showing the construction progress up to that date. This way, the strain data can be more accurately related to construction events. Negative values on the graphs indicate compression.

This illustration shows the St. Anthony Falls Bridge over a water body. The illustration shows the locations and view fields of the cameras trained on pier 2, which include the close-up camera and the perspectives of the more distant south and west cameras.

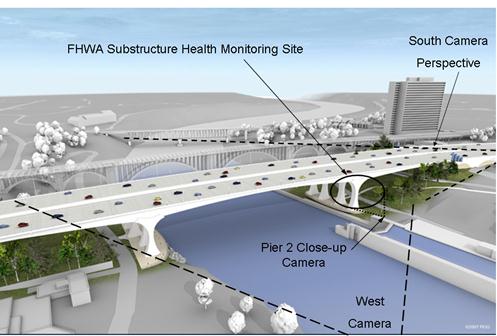

Figure 86. Illustration. Hover points on the main page of St. Anthony Falls Bridge health monitoring Web site.(9)

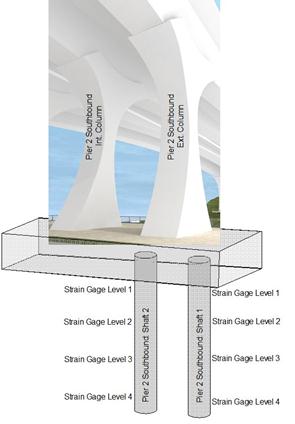

This illustration shows the pier 2 southbound internal and external columns and the pier 2 southbound shafts 1 and 2, with the placing of the different strain gauge levels.
Figure 87. Illustration. Instrumentation scheme for the St. Anthony Falls Bridge health monitoring project.

This graph shows pier 2 interior column strain. Strain data is on the y-axis from -150 to 150 microstrains, and dates and times of measurements are on the x-axis from March 7, 2008, to May 4, 2008. There is a horizontal line that separates the graph into two equal regions. The upper and lower regions are broken into days represented by hover points that direct the visitor to a photo graph from one of two camera views (southern or western).
Figure 88. Graph. Pier 2 interior column strain.

This graph shows pier 2 exterior column strain. Strain data is on the y-axis from -150 to 150 microstrains, and dates and times of measurements are on the x-axis from March 7, 2008, to May 4, 2008. There is a horizontal line that separates the graph into two equal regions. The upper and lower regions broken into days represented by hover points that direct the visitor to a photo graph from one of two camera views (southern or western).
Figure 89. Graph. Pier 2 exterior column strain.

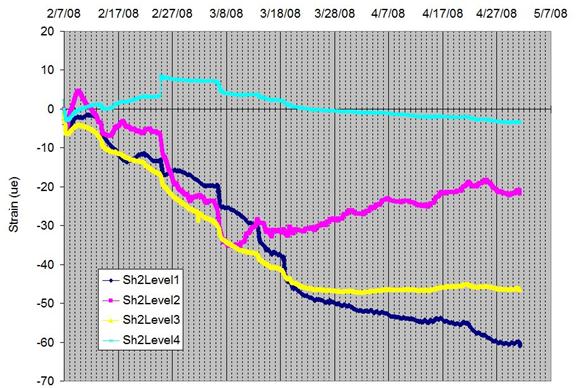

This graph shows pier 2 shaft 2 for all levels of strain. Strain is on the y-axis from -70 to 20 microstrains, and the date and time is on the x-axis from February 7, 2008 to May 7, 2008. There is a horizontal line, which represents the starting time at zero microstrains on the y-axis, that separates the graph into two equal regions. The upper and lower regions are broken into days represented by hover points that direct the visitor to a photo graph from one of two camera views (southern or western).
Figure 90. Graph. Pier 2 shaft 2 all levels strain.

This graph shows pier 2 shaft 1 for all levels of strain. Strain is on the y-axis from -60 to 0 microstrains, and the date and time are shown on the x-axis from February 7, 2008, to May 7, 2008. There is a horizontal line, which represents the starting time at zero microstrains on the y-axis, that separates the graph into two equal regions. The upper and lower regions are broken into days represented by hover points that direct the visitor to a photo graph from one of two camera views (southern or western).
Figure 91. Graph. Pier 2 shaft 1 all levels strain.

The load on pier 2 was somewhat complicated by indeterminate reactions from false work used to support the cast-in-place span 1 box girders (from end bent 1 to pier 2). As a result, the total load from span 1 was not felt by pier 2 until the bridge was almost completed and as the false work was removed. Precast box girder sections (timeline indicated in figure 92 and figure 93) were installed almost daily, extending from pier 2 toward pier 3 and cantilevered out over the Mississippi River. However, by correlating the number of box sections and their respective weights to the measured strain in each column, the column strain gauges were calibrated with increased confidence. Figure 94 shows the computed load from strain, concrete modulus, area as a function of the logging, and the theoretical reaction due to the known concrete box girder weights using lever arm.

This line graph shows shaft 1 loads throughout the entire construction sequence. Load is on the y-axis from 0 to 4,500 kips (0 to 2,043,000 kg), and date is on the x-axis from February 4, 2008, to August 22, 2008. Arrows point to the different events during the construction period. The different colored lines depict measurements taken at levels 1 through 4. The strains in shaft 1 were converted to load as a function of time.
1 kip = 454 kg

Figure 92. Graph. Shaft 1 loads throughout the entire construction sequence.

This line graph shows shaft 2 loads throughout the entire construction sequence. Load is on the y-axis from 0 to 4,500 kips (0 to 2,043,000 kg), and the date is on the x-axis from February 4, 2008, to August 22, 2008. Arrows point to the different event during the construction period. The different colored lines depict measurements taken at levels 1 through 4. The strains in shaft 2 were converted to load as a function of time.
1 kip = 454 kg
Figure 93. Graph. Shaft 2 loads throughout the entire construction sequence.

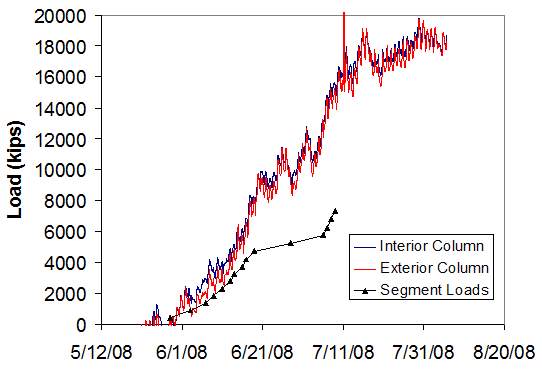

This line graph shows column loads compared with segment placement. Load is on the y-axis from 0 to 20,000 kips(0 to 9,080,000 kg), and the date is on the x-axis from May 12, 2008, to August 20, 2008. The blue line represents the measurements of the interior column, the red line represents the measurements of the exterior column, and the black line represents the segment loads. As the precast concrete box segments were applied to the superstructure, column loads increased. This process began in late May 2008 and concluded in mid July 2008. The predicted load effect on the column using lever rule and the span and segment lengths are shown to be less than the actual load measured. This can be explained given that span 1 was partially supported by falsework. The applied cantilevered load caused relaxation of the falsework support where load once carried by the false work was slowly transferred to the column. As a result, the measured load is shown to be higher than the computed load effect caused by the new segments alone.
1 kip = 454 kg
Figure 94. Graph. Column loads compared with segment placement.

Unlike the shaft gauges located beneath the footing, column loads were subject to daily temperature fluctuations, which can be seen in figure 94. Additionally, the stark difference between the calculated segment load effects on the overall column load was caused by relaxation of the false work support as the cantilevering load provided uplift throughout span 1.

Construction Phase Monitoring Completion

Recall that only two shafts out of the eight in pier 2 (southbound) were instrumented; both were on the south edge of the footing, providing similar responses to the construction loads when considering column bending effects. Unfortunately, the load carried by the other six shafts was not monitored, and the response therein could only be estimated based on engineering principles. Figure 92 and figure 93 show the loads (as converted from measured strains, positive compression) detected in shafts 1 and 2. These figures are annotated to show several significant points in the construction sequence that help explain changes in the load versus time relationship.

By looking at both the shaft response and the column strains, a clearer picture of the loading can be obtained. Figure 95 and figure 96 show the strains recorded for both the interior and exterior columns found on the same eight shafts beneath pier 2 southbound. The increased compressive loads (positive sign) shown in shafts 1 and 2 correspond to expansion required to obtain the necessary tolerances followed by jacking closure at the center span misalignment. This is shown by the increased compression strain on the south edge of the columns that correspond to decreased compression strain (of similar magnitude) on the north edges followed by a reversal upon closure jacking.

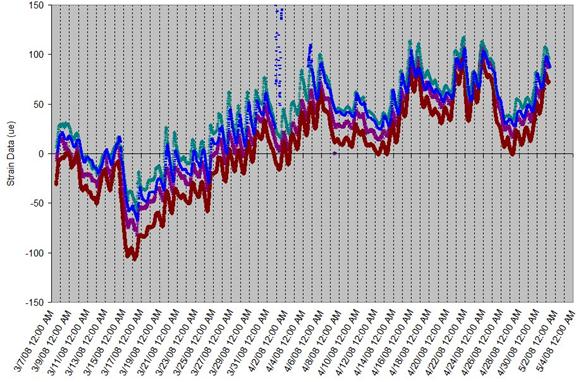

This graph shows strains measured in the interior column of pier 2 southbound. Strain is on the y-axis from -100 to 400 microstrains, and date is on the x-axis from February 22, 2008, to August 20, 2008. A significant amount of strain was induced in bending of the column from jacking the final segments apart to prepare it for the closure pour. This is shown initially as an increased compression on the southern face (net tension on the northern face) of the column during the pour followed by a reversal during the final post tensioning of the bridge. The final post tensioning caused a reduction in span length and an associated bending in the column, as shown by the increased compression on the northern face (decreased compression on the southern face).
Figure 95. Graph. Strains measured in the interior column of pier 2 southbound.

This graph shows strains measured in the exterior column of pier 2 southbound are shown from the time of casting to the time when the final concrete box segment was placed. Strain is on the y-axis from -100 to 400 microstrains, and date is on the x-axis from February 22, 2008, to August 20, 2008. A significant amount of strain was induced in bending of the column from jacking the final segments apart to prepare for the closure pour. This is shown initially as an increased compression on the southern face (net tension on the northern face) of the column during the pour followed by a reversal during the final post tensioning of the bridge. The final post tensioning caused a reduction in span length and an associated bending in the column, as shown by the increased compression on the northern face (decreased compression on the southern face).
Figure 96. Graph. Strains measured in the exterior column of pier 2 southbound.

Upon further review of these data with the structural engineer, the drastic reduction in strains which resulted in returning to the somewhat normal values was a result of the internal prestressing of the entire section. The ±75-100 µe values shown in the columns were a direct result of a pier movement (away from midspan) of approximately 0.75 inches (19.05 mm) (from field observations). Subsequent prestressing must therefore have resulted in a permanent net movement (toward midspan) of a similar magnitude or approximately 0.75 inches (19.05 mm).

All temporary DAS boxes were again removed to allow the construction of a public viewing platform beneath pier 2 (adjacent to the river). At the time of removal, it was thought that the permanent DAS would be installed within the week in a vault cast aside the northwest corner of the footing (pier 2 southbound). Ultimately, nearly 1 month of data were lost during this disconnection period. Furthermore, it was not clear at that time whether the substructure gauges would be online for the truck tests series scheduled for the following month.

PHASE III-LONG-TERM HEALTH MONITORING

The third and final phase of SSHM for the St. Anthony Falls Bridge Monitoring Project was the long-term health monitoring of the substructure, which was synchronized with the superstructure system. In phase III, the loads induced on the entire bridge by the ongoing daily use of the bridge were monitored as well as those effects caused by diurnal and seasonal temperature variations. The timeline shown in figure 46 indicates that long-term monitoring should have commenced upon completion of the bridge which opened on September 18, 2008, more than 3 months early. However, no live load, diurnal, or seasonal data were available at the time of this report (6 months after the bridge opening), with the exception of several days of monitoring that included live load truck tests.

The long-term monitoring program also included numerous superstructural instrumentation regimes involving deck corrosion, box girder vibrations, box girder strains, etc., which were outside the scope of the SSHM program. SSHM was incorporated into the overall health monitoring of the bridge via an onsite DAS building located east of the north end of the bridge. Therein, various systems were housed to monitor the various gauge types used throughout the bridge. For the SSHM components, two systems are presently being used that replaced the temporary DAS systems described previously. Both systems act as repeaters, whereby the data are collected and transmitted via Ethernet or similar communication to the far end of the bridge (over 1,000 ft (305 m)).

Live Load Truck Tests

Live load testing of the completed bridge using weighed trucks was conducted 4 days prior to the bridge opening. Although the intention was to have data collected from both the substructural and superstructural instrumentation by the permanent DAS, it became clear 2 days prior to the test that the substructure gauges would not be connected to any unit (temporary or permanent). To that end, FGE, LLC sent personnel to the I-35W bridge site the day before the testing to reconnect to the temporary DAS units, assuring this valuable information was not lost.

Figure 97 shows the temporary DAS being reconnected to the southbound pier 2 footing. The vault in which the permanent repeater DAS units are to be housed is formed with plywood just behind the temporary DAS units shown. The units were reconfigured to record at higher rates(one sample/minute for resistive gauges and two samples/minute for the vibration wire gauges). The 2-min sampling rate for the vibrating wire gauges was the limiting (high-end) rate dictated by the number of gauges, the multiplexers, and the basic physics of the gauge type. The faster resistive gauges were recorded at a 1-min logging rate, but the DAS was sampling at 100 Hz. As before, logging of this device incorporated maximum, minimum, average, and instantaneous readings as accumulated over the 1-min logging interval.

The photo shows the temporary data acquisition system (DAS) being reconnected aside the southbound pier 2 footing. The temporary DAS was removed from the fence line and reconnected, reconfigured, and reattached in a second temporary location while the vault for a permanent DAS was constructed.
Figure 97. Photo. Temporary DAS system reconnected, reconfigured, and reattached in new location adjacent to the permanent DAS subpanel vault.

Truck testing involved eight fully loaded dump trucks (50,000 lb (22,700 kg) each) driven in a series of patterns across the bridge. Starting with a side-by-side configuration (eight abreast), the trucks began at pier 3 (north side of the river) on the southbound structure and moved systematically across to the south, stopping at prescribed locations (e.g., pier 3, quarter points, midpoint, pier 2, etc.). Figure 98 shows one such truck configuration.

The figure shows live load testing with eight 50-kip (22,680-kg) trucks (400-kip (181,437-kg) total load) staged at predetermined locations along the bridge length.
Figure 98. Photo. Trucks (400-kip (181,436.95-kg) total load) staged at predetermined location.

One of the many convenient features of the temporary DAS was the wireless/remote reconfiguration options that allowed onsite or in-office access to the system. While onsite during the afternoon before the truck test, both the vibrating wire and resistive gauge systems were reconfigured via cellular internet access to the host computer in Tampa, FL. Although the host was remotely accessed from the field, all data were being logged to the secure site on 5-min intervals.

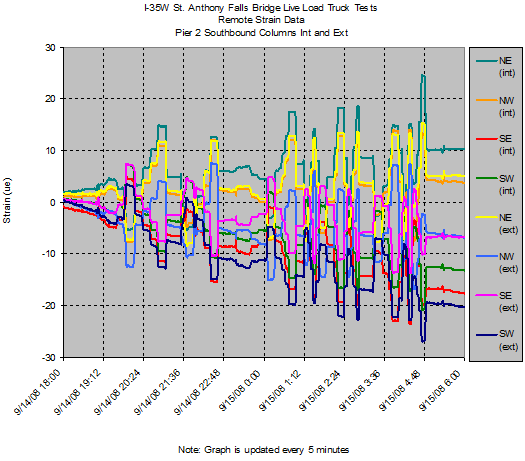

The first series of truck tests were conducted over a 10-h period beginning at 7 p.m. on September 14, 2008, and concluding at 5 a.m. on September 15, 2008. Figure 99 shows the raw data as updated on the host Web site every 5 min. All strains were zeroed once the DAS units were reconnected, which represented live load measurements and showed minute changes in strain due to the truck loads. Figure 100 through figure 102 show a single load cycle for the columns, shaft 1, and shaft 2, respectively. Given the calibration and understanding of the column strain magnitudes afforded by the closure pour strains (±75-100 µe represented a 0.75-inch (19.05-mm) top of column movement), it is clear that as the trucks approached mid-span at approximately 8:30 p.m., the columns moved outward approximately 0.05-0.07 inches (1.27-1.78 mm). This was caused by a slight loss of camber from the centrally located concentrated load. The steps in the data were congruous to the times in which the trucks were either stopped at a given location (10-15-min holds) or moving to the next location. It can also be seen that multiple load cycles were conducted up until the time at which the contractor took over to complete other aspects of the bridge in the early morning hours of that day. This set of tests was denoted as the static truck tests due to the long holding periods. Figure 101 and figure 102 clearly show live load effects all the way down to the toe of each shaft.

This graph shows measured strain as a function of time from each of eight strain gauges over a 10-h period using wire contour lines. Strain is on the y-axis from -30 to 30 microstrains, and the time and date is on the x-axis from September 14, 2008, to September 15, 2008. The last 2 h of data show no activity as testing had completed. The eight strain gauges are from the corners of the two pier 2 columns denoted as NE, NW, SE, and SW from the interior (int) and exterior (ext) columns of the southbound side of the bridge. There are data for NE (int), NW (int), SE (int), SW (int), NE (ext), NW (ext), SE (ext), and SW (ext). The sign convention for this data shows compression strain as positive. All measurements reflect the change in strain from shortly before the truck tests commenced. A clear trend can be seen where all column gauges located on the north faces of the columns (facing the center of the main span) become progressively more compressive due to the gradual cooling of the bridge with time. Gauges on the south faces of the columns trend toward more tension.
Figure 99. Graph. Column strains during 10-h truck tests (positive compression).

This wire contour line graph shows truck load test results for both columns for one cycle of truck positions. Strain is on the y-axis from -15 to 15 microstrains, and the dates and times are on the x-axis from September 14, 2008, at 6 a.m. to September 14, 2008, at 9:21 p.m. The data show the strain induced in the column during one round of static truck tests. Although these tests were considered to be static at approximately 9 p.m., the data show the trucks driving across the bridge from south to north to set up for the test at the first designated position. The cooling of the main span can be seen as increased tension on the south faces of the columns and compression on the north faces. The eight strain gages are from the corners of the two pier 2 columns denoted as NE, NW, SE, and SW from the interior (int) and exterior (ext) columns of the southbound side of the bridge. There are data for NE (int), NW (int), SE (int), SW (int), NE (ext), NW (ext), SE (ext), and SW (ext).
Figure 100. Graph. Truck load test results for both columns for one cycle of truck positions.

This wire contour line graph shows truck load test results for shaft 1 for one cycle of truck positions. Load is on the y-axis from -60 to 100 kips (-27,240 to 45,400 kg), and the dates and times are on the x-axis from September 14, 2008, at 6 p.m. to September 14, 2008, at 9:21 p.m. The negative numbers show the level of tension, and the positive number show the level of compression. The four colored lines represent levels 1 through 4 of shaft 1. Although these tests were considered to be static at approximately 9 p.m., the data show the trucks driving across the bridge from south to north to set up for the test at the first designated position. The cooling of the main span can be seen as increased tension in the shaft which was on the south edge of the footing. Although the effect the load decreases with depth, even the lowest toe level gauge registered the presence of the trucks during the load cycle.
1 kip = 454 kg
Figure 101. Graph. Truck load test results for shaft 1 for one cycle of truck positions.

This wire contour line graph shows truck load test results for shaft 2 for one cycle of truck positions. Load is on the y-axis from -100 to 60 kips (-45,400 to 27,240 kg), and the dates and times are on the x-axis from September 14, 2008, at 6 p.m. to September 14, 2008, at 9:21 p.m. The negative numbers show the level of tension, and the positive numbers show the level of compression. The four colored lines represent the level 1 through 4 of shaft 1. Although these tests were considered to be static at approximately 9 p.m., the data show the trucks driving across the bridge from south to north to set up for the test at the first designated position. Recalling that positive denoted compression in this case, the cooling of the main span can be seen as increased tension in the shaft, which was on the south edge of the footing. Although the effect the load decreases with depth, even the lowest toe level gauge registered the presence of the trucks during the load cycle.
1 kip = 454 kg
Figure 102. Graph. Truck load test results for shaft 2 for one cycle of truck positions.

The temporary DAS was left in place for several days in hopes of capturing data from a series of 45-mi/h (72.45-km/h) dynamic truck loadings scheduled later in the week (but prior to the bridge opening at 5 a.m. on September 18, 2008). Figure 103 through figure 106 show a 4.5-day data window starting with the static truck tests on September 14, 2008, and show the effect of diurnal temperature variations through this period. In each of these graphs, the reported temperature for Minneapolis, MN, over that same timeframe is superimposed and virtually mimics the overall strain trends (with the exception of the truck test strains) for four of the eight column gauges. The other four show an opposite effect. Those gauges on the column face closest to the main span (north side) and should experience tension with increased temperature of the main span girders due to thermal expansion. Shaft loads increased as the bridge warmed and expanded, thereby pushing down on the south edge of the footing, which corresponds to the locations of shafts 1 and 2.

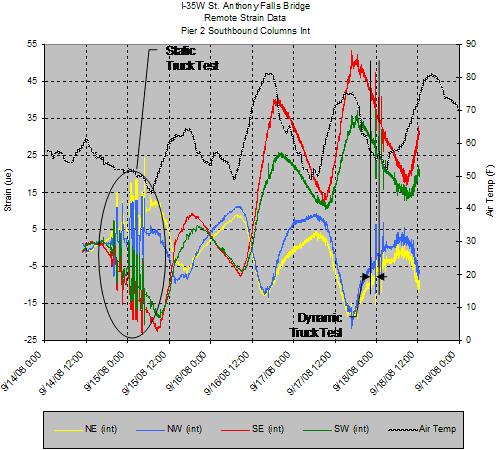

This wire contour line graph shows live load effects on the interior column over a 4.5-day period. Strain is on the left y-axis from -25 to 55 microstrains, the dates and times are on the x-axis from September 14, 2008, to September 19, 2008, and air temperature is on the right y-axis from 0 to 90 ï‚°F (-17.78 to 32.22 ï‚°C). The black line is the air temperature, where the average daily temperature starts at approximately 55 ï‚°F (12.78 ï‚°C) on September 14, 2008, and warms gradually to 65 ï‚°F (18.33 ï‚°C) on September 19, 2008.The data represent the final days of monitoring the interior column with the temporary data acquisition system, beginning with the static truck test and concluding with the day the bridge was opened for use. The daily thermal cycles are seen where the strain in the bridge slightly lags the measured air temperature. The warming air temperature trend is shown in the strain gauges where southside gauges (red and green) become progressively more compressive due to thermal expansion of the superstructure, and northside gauges (yellow and blue) show progressively more tension. The time of the static and dynamic tests are denoted along with the corresponding strain response as large fluctuations in strain that are independent of the broader thermal cycles.
Figure 103. Graph. Live load effects on the interior column over 4.5-day period.

This wire contour line graph shows live load effects on the exterior column over a 4.5-day period. Strain is on the y-axis from -30 to 50 microstrains, dates and times are on the x-axis from September 14, 2008, to September 19, 2008, and air temperature is on the right y-axis from 0 to 90 ï‚°F (-17.78 to 32.22 ï‚°C). The black line is the air temperature, where the average daily temperature starts at approximately 55 ï‚°F (12.78 ï‚°C) on September 14, 2008, and warms gradually to 65 ï‚°F (18.33 ï‚°C) on September 19, 2008.The data represent the final days of monitoring the exterior column with the temporary data acquisition system, beginning with the static truck test and concluding with the day the bridge was opened for use. The daily thermal cycles are seen where the strain in the bridge slightly lags the measured air temperature. The warming air temperature trend is shown in the strain gauges where southside gauges (red and green) become progressively more compressive due to thermal expansion of the superstructure, and northside gauges (yellow and blue) show progressively more tension. The time of the static and dynamic tests are denoted along with the corresponding strain response as large fluctuations in strain that are independent of the broader thermal cycles.
Figure 104. Graph. Live load effects on the exterior column over 4.5-day period.

This wire contour line graph shows live load effects on shaft 1 over a 4.5-day period. Load is on the left y-axis from -150 to 350 kips (-68,100 to158,900 kg),the dates and times are on the x-axis from September 14, 2008, to September 19, 2008, and air temperature is on the right y-axis from 0 to 90 ï‚°F (-17.78 to 32.22 ï‚°C). The negative numbers show the level of tension, and the positive numbers show the level of compression. The green line is the air temperature, while the dark blue, pink, yellow, and light blue lines represent levels 1 through 4 of shaft 1, respectively. The data represent the final days of monitoring shaft 1 with the temporary data acquisition system, beginning with the static truck test and concluding with the day the bridge was opened for use. The daily thermal cycles can be seen where the strain in the bridge slightly lags the measured air temperature. The time of the static and dynamic tests are denoted along with the strain response.
1 kip = 454 kg
°F = 1.8(°C) + 32
Figure 105. Graph. Live load effects on shaft 1 over 4.5-day period.

This wire contour line graph shows live load effects on shaft 2 over a 4.5-day period. Load is on the left y-axis from -150 to 350 kips (-68,100 to158,900 kg), the dates and times are on the x-axis from September 14, 2008, to September 19, 2008, and air temperature is on the right y-axis from 0 to 90 ï‚°F(-17.78 to 32.22 ï‚°C). The negative numbers show the level of tension, and the positive numbers show the level of compression. The green line is the air temperature, while the dark blue, pink, yellow, and light blue lines represent levels 1 through 4 of shaft 2, respectively. The data represent the final days of monitoring shaft 2 with the temporary data acquisition system, beginning with the static truck test and concluding with the day the bridge was opened for use. The daily thermal cycles can be seen where the strain in the bridge slightly lags the measured air temperature. The time of the static and dynamic tests are denoted along with the strain response.
1 kip = 454 kg
°F = 1.8(°C) + 32
Figure 106. Graph. Live load effects on shaft 2 over 4.5-day period.

As subsequent dynamic truck tests were scheduled for later that week, the temporary DAS units were left in place in hopes of obtaining the data or until the last possible moment after which the wooded forms to which the units were attached needed to be stripped (see figure 97). Although details of the exact loading event were not available at the time of reporting, the effects of the events were captured, as indicated in figure 103 through figure 106.

System Results and Conclusions

In the absence of long-term monitoring data for the last 6 months, it was difficult to demonstrate the full benefit of the system as it is presently equipped. However, from the small window of available information shown in figure 99 through figure 107, it is clear that the equipment has tremendous capability to detect subtle loading throughout the substructure. Figure 107 shows a scale-enhanced version of figure 106 wherein the moderate daily temperature fluctuations of 20 °F (-6.67 °C) induced axial load variations of approximately 10 kips (4,535.92 kg) at the toe of shafts. Interestingly, the Minneapolis, MN, area can see annual temperature fluctuations of over 100 °F (37.78 °C), which should be easily captured with the SSHM system. Furthermore, the data show live load effects caused by truck loading with magnitudes as much as 5 kips (2,270 kg). It should be noted that these effects are caused by lever arm effects from forces acting horizontally at the top of the column. These are the exact types of forces that typically control foundation design.

This wire contour line graph shows the diurnal temperature and truck load effects at the toe of shaft 2. Load is on the left y-axis from -10 to 25 kips (-4,540 to 11,350 kg), the dates and times are on the x-axis from September 14, 2008, to September 19, 2008, and air temperature is on the right y-axis from 0 to 90 ï‚°F (-17.78 to 32.22 ï‚°C). The negative numbers show the level of tension, and the positive numbers show the level of compression. The green line is the air temperature, and the light blue line represents level 4 of shaft 2. The data indicate that the sensitivity of the data acquisition system and the load effects all the way to the toe of the shaft. The daily thermal cycles, the static test, and the dynamic test can be seen.
1 kip = 454 kg
°F = 1.8(°C) + 32
Figure 107. Graph. Diurnal temperature and truck load effects at the toe of shaft 2.

Finally, the results of the truck load tests (although incomplete at the time of this report) served to calibrate the column strain measurements over the entire cross section by taking the sum of the individual average column strains and applying a known concrete modulus. Figure 108 shows the force computed from strain, column cross sectional area, and modulus during the truck load tests where the 400-kip (181,600-kg) total truck loads are corroborated. This also shows that as the trucks were loaded directly over pier 2 (the SSHM project site), some torsion of the box girders and deck assembly caused a slight uplift on the exterior column as trucks were lined up starting from the opposite interior column (east) side of the deck. A similar increased load was observed on the interior column corresponding to the cantilevered loading from that edge of the deck.

This graph shows column gauge calibration from known truck loads. Load is on the y-axis from -100 to 500 kips (-45,359 to 226,796 kg), and date and time are on the x-axis for September 14, 2008, at 9:40 p.m. to September 14, 2008, at 10:04 p.m. The strain in each column during one cycle of tests is shown as the truck proceeded from pier 3 toward pier 2. The combined load from both columns (red) indicates a close correlation with the know weight of the trucks. While aligning the trucks over pier 2, they were positioned from the interior to exterior, which induced some torsion in the box girder/deck system. This is shown as a reduction (slight uplift) on the exterior column (green) and an increased load on the interior column (blue).
1 kip = 454 kg
Figure 108. Graph. Column gauge calibration from known truck loads.
