Brien Desilets
Managing Director,
Claret Consulting
Patrick DeCorla -Souza
P3 Program Manager,
Federal Highway
Administration
This presentation will introduce Chapters 1- 4.
Infrastructure Delivery Options
View larger version of Infrastructure Delivery Options flow chart

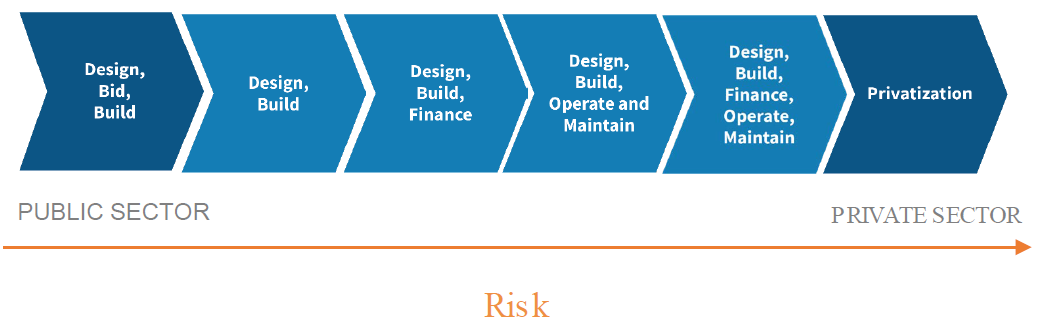

Design, Bid, Build » Design, Build » Design, Build, Finance » Design, Build, Operate and Maintain » Design, Build, Finance, Operate, Maintain » Privitization
(Moves from Public Sector to Private Sector with risk increasing towards Private Sector)
Degree of ownership, development integration, risk
transfer and extent of private financing
Design-Bid-Build | P3 |
---|---|
Public sector takes on most risks (except construction) | Risks shared between public and private sectors |
Public financing (mostly) | Private financing (mostly) |
Lowest bidder | Best value for least net present cost |
Operations and Maintenance (O&M) and ongoing rehabilitation (if any) carried out by public agency (or under fee for prescribed services) once constructed | O&M carried out by private sector; ongoing rehabilitation overseen by public sector stewardship of P3 |
View larger version of P3 Delivery Models graph

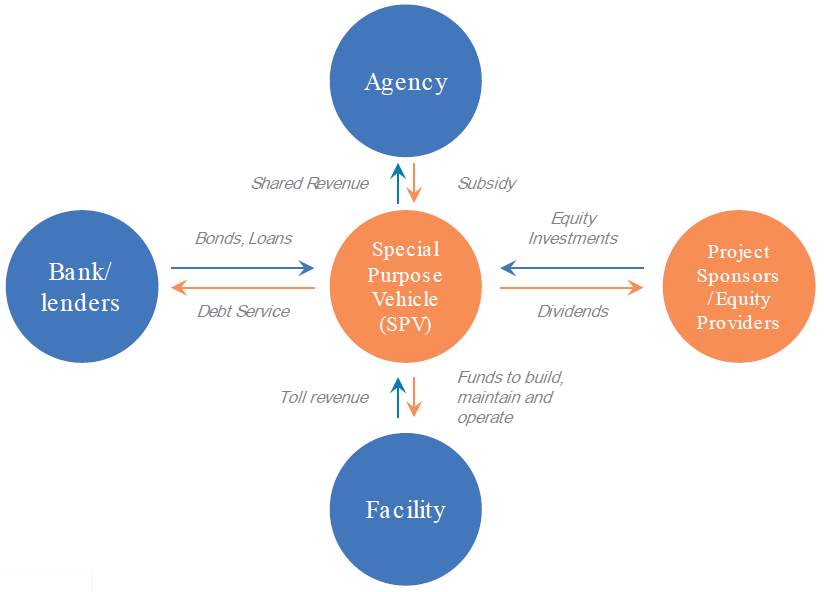

View larger version of Typical Toll Concessions P3 Structure graph
View larger version of Typical Availability P3 Structure graph
Submit a question using the chat box
Public Sector | SPV | Subcontractor | |
---|---|---|---|
Development Phase | |||
Planning & environmental process | ✔ | ||
Political will | ✔ | ||
Regulatory | ✔ | ||
Site | |||
Permitting | ✔ | ✔ | ✔ |
Procurement | ✔ | ✔ | |
Financing | ✔ | ||
Construction Phase | |||
Engineering & construction | ✔ | ||
Changes in market conditions | ✔ | ||
Operation Phase | |||
Traffic | ✔ | ||
Competing facilities | ✔ | ||
Operations and maintenance | ✔ | ||
Appropriation | ✔ | ✔ | |
Financial default risk to public agency | ✔ | ||
Refinancing | ✔ | ||
Political | ✔ | ||
Regulatory | ✔ | ||
Handback | ✔ |
View larger version of SPV Arrangements flow chart
Submit a question using the chat box
View larger version of Sources of Financing chart
Text of Typical Cash Flow Waterfall diagram
Where DSCR = Cash Available for Debt Service (CADS) divided by debt service (principal + interest)
Series |
Maturity |
Principal (US$) |
Coupon |
Yield* |
---|---|---|---|---|
A | 1/1/2022 |
670,000 | 4.25% | 4.45% |
B | 1/1/2023 | 685,000 | 4.50% | 4.60% |
C | 7/1/2023 | 1,775,000 | 5.00% | 4.60% |
D | 1/1/2024 | 1,760,000 | 5.00% | 4.75% |
E | 7/1/2024 | 2,900,000 | 5.00% | 4.75% |
F | 1/1/2025 | 3,080,000 | 4.75% | 4.90% |
G | 7/1/2025 | 4,875,000 | 5.00% | 4.90% |
H | 1/1/2026 | 5,290,000 | 5.00% | 4.95% |
I | 7/1/2026 | 6,700,000 |
5.00% | 4.95% |
J | 1/1/2027 | 6,150,000 | 5.00% | 5.00% |
K | 7/1/2027 | 8,480,000 | 5.00% | 5.00% |
L | 1/1/2032 | 91,795,000 | 5.25% | 5.25% |
M | 1/1/2037 | 209,185,000 | 6.00% | 5.32% |
N | 1/1/2042 | 320,405,000 | 5.50% | 5.50% |
*The rate is the rate offered to bond buyers. When bonds are sold, they often do not sell at face value but at either a premium or a discount. The yield indicates the actual return offered to bondholders based on the actual price paid. Source: Midtown Tunnel Official Statement available from MSRB EMMA database, CUSIP 928104LK2. |
Advantages
Disadvantages
Transportation Infrastructure Finance and Innovation Act (TIFIA) also provides a form of subordinate debt
Project | Amount | Rate (%) | Term (years) |
---|---|---|---|
I-95 HOT Lanes | $300.0 | 2.76 | 35.0 |
Presidio Parkway Tranche A | $90.0 | 0.46 | 3.5 |
Presidio Parkway Tranche B | $60.0 | 2.71 | 28.0 |
Midtown Tunnel | $422.0 |
3.17 | 44.0 |
LBJ-635 Corridor | $850.0 | 4.22 | 40.5 |
North Tarrant Express | $650.0 | 4.51 | 35.0 |
Port of Miami Tunnel | $341.0 | 4.31 | 35.0 |
I-595 |
$603.0 | 3.63 | 35.0 |
SH-130 Segment V-VI | $430.0 | 4.45 | 35.0 |
I-495 HOT Lanes | $589.0 | 4.40 | 40.0 |
TIFIA has been involved in almost all major US greenfield P3s and approximately a third of the projects in the TIFIA portfolio are P3s |
Submit a question using the chat box
No investor guarantee on returns and no investment recourse
Investor | Strategy/Objective | Project Transaction Example |
---|---|---|
Subcontractors engaging in Design Build and Operations & Maintenance | Broadening participation and potential financial returns over the project term | Midtown Tunnel: Skanska is a 50% equity investor in the SPV and member of the DB contractor team |
Financial institutions | Provide development capital and typically exit once the project is up and running or even before | Denver Fastracks Eagle P3: Macquarie sold its stake after the project reached financial close. |
Pension funds and insurance companies | Seek long-term return; they prefer a larger share of the concession's cash flows | Florida I-595: TIAA-CREF acquired a 50% stake when the project neared substantial completion |
Project/Investor | Amount ($millions) |
---|---|
East End Crossing | |
Walsh Investors | $26.00 |
VINCI Concessions SAS | $26.00 |
Bilfinger Berger | $26.00 |
I-95 HOT Lanes | |
Fluor | $24.20 |
DRIVe USA | $217.80 |
Presidio Parkway | |
Hochtief | $23.00 |
Meridiam | $23.00 |
Midtown Tunnel | |
Skanska | $99.45 |
Macquarie | $121.55 |
LBJ-635 Corridor | |
Cintra | $364.00 |
Meridiam | $266.00 |
Dallas Police / Fire Pension Fund | $70.00 |
North Tarrant Express | |
Cintra | $241.50 |
Meridiam | $141.90 |
Dallas Police / Fire Pension Fund | $42.60 |
Port of Miami Tunnel | |
Bouygues | $8.00 |
Meridiam | $72.30 |
I-595 | |
ACS Iridium | $207.70 |
SH-130 Segment 5-6 | |
Cintra | $136.40 |
Zachry | $73.40 |
I-495 HOT Lanes | |
Flour | $35.00 |
Transurban | $315.00 |
Phase | Risk-free Rate | Project Risk | Phase Risk | Equity Return |
---|---|---|---|---|
Construction | 6% | 2-4% | 4% | 12-14% |
Ramp up | 6% | 2-4% | 2% | 10-12% |
Long-term operation | 6% | 2-4% | - | 8-10% |
Source: Adapted from Yescombe, E.R. (2007) Public-Private Partnerships: Principles of Policy and Finance. Oxford UK: Elsevier Ltd. |
View larger version of Equity Share on US Transportation Projects

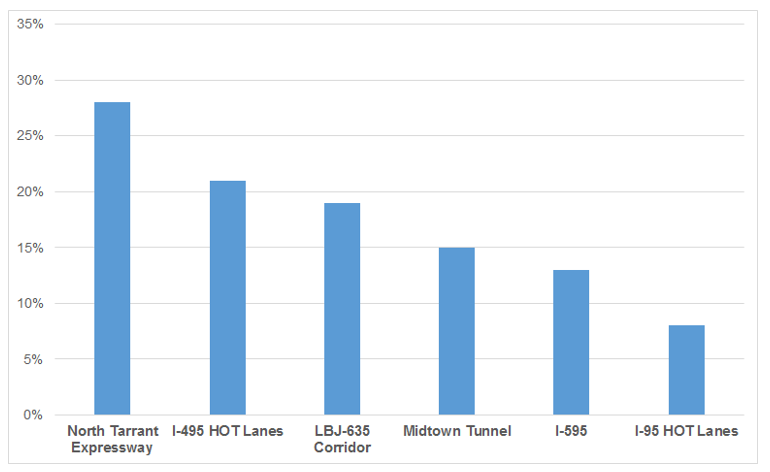

View larger version of Upfront Government Contributions on US P3 Projects
Source of Funds | Terms and Conditions | Value | Availability |
---|---|---|---|
Cash reserves | Funded at financial close | Project specific | Immediate (*) |
Cash reserves | Funded from project cash flows | Project dependent | Immediate once constituted |
Letters & Lines of credit | On call from a financial institution Supports project cash flows during construction to avoid impact on schedule. | About 5-10% of contract value | Immediate (irrevocable and unconditional) |
Parental guarantee | Guarantee of performance by ultimate parent of the Construction or the Operations & Maintenance contractor | Based on probable loss | Immediate subject to credit worthiness |
Performance bond | Surety bond provides core performance support in case of contractor failure | 100% of contract value | Conditional and subject to process |
Insurance | Provided by third party to subcontractors and SPV | Priced on coverage, insured | Conditional and subject to process |
Notes (*) Lenders will only consent to use of the reserves for their designated purpose. In other words the debt service reserve is not available for maintenance purposes. |
Submit a question using the chat box
Project Development
|
||
![]() |
||
Bid Preparation
|
Commercial & Financial Close
|
||
![]() |
||
Concession Period
|
View larger version of P3-Value 2.0 Flow Chart
Risk Assessment | Value for Money Analysis | ||
![]() |
|||
Financial Viability Assessment | Project Delivery Benefit-Cost Analysis |
Submit a question using the chat box
