Project Profile: I-81 Corridor Improvements, Virginia

Rendered image.

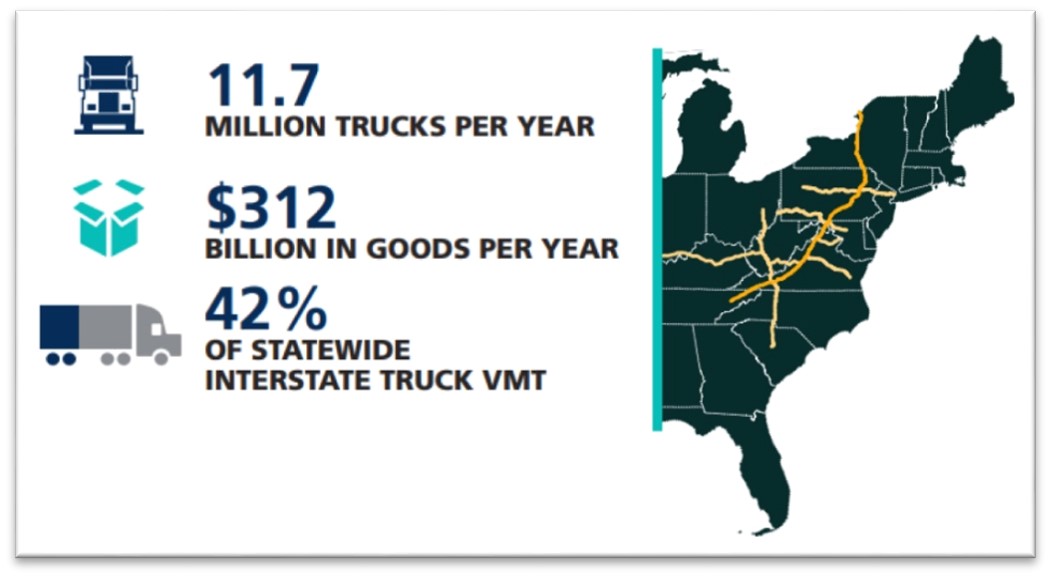

Caption: A graphic demonstrating the importance of I-81 as a truck route.
Source: Credit to Virginia Department of Transportation

Project Name Virginia I-81 Corridor
Location Roanoke County and Frederick, Pulaski, Rockbridge, Shenandoah, Smyth, Washington, and Wythe Counties
Project Sponsor / Borrower Virginia Department of Transportation (VDOT)
Program Areas Value Capture
Value Capture Techniques Development Impact Fees / Mobility Fees & Special Assessment (Community Improvement District)
Mode Highway
Description

The project is part of the I-81 Corridor Improvement Program, which consists of innovative, targeted improvements that will have a substantial effect on the safety and reliability of a critical portion of our nation’s infrastructure. The traditional TIFIA loan will enable VDOT to finance and accelerate the implementation of its $2.7 billion I-81 Capital Improvement Plan, enabling the financing of an additional lane in each direction from mileage marker 136 to 139 in Roanoke County. The lane additions will improve the ability to accommodate increased freight and passenger vehicle volumes along the I-81 corridor. The rural component of the project is being financed by a second TIFIA loan from the Build America Bureau’s Rural Project (RPI) Initiative. The rural component includes acceleration, deceleration, and merge area improvements, improving safety and highway access in Frederick, Pulaski, Rockbridge, Shenandoah, Smyth, Washington, and Wythe counties.

Cost (millions) Project Cost: $280.7
TIFIA-Eligible Cost: $263.4
Funding Sources

Interstate O&E Program: $48.2
Series 2021 Bonds: $102.9
2022 TIFIA direct loan: $82.6 (repayment with tax revenue)

Rural Project:
2022 TIFIA RPI loan: $15.0
Regional Fuel Taxes/Interstate O&E Allocation: $15.6

Project Delivery / Contract Method Design-Build
Private Partner Design-Build: Archer Western Construction LLC, a joint venture between Archer Western Construction (contractor), Dewberry (lead design), Kanawha, MBP (quality assurance), Accumark (utility), Diversified Property Services (ROW), Alvi Associates (bridge and roadway design), ESC Mid-Atlantic, LLC (geotechnical), Timmons (field surveys), and Quantum (geospatial mapping)
Project Advisors/ Consultants

Public Resource Advisory Group

Lenders Bondholders, USDOT TIFIA
Duration / Status Traditional TIFIA: May 2060 RPI
TIFIA: May 2057

TIFIA Credit Assistance Traditional TIFIA: up to $82.6 million
TIFIA RPI: up to $15 million
Financial Status/Financial Performance The current estimate for the lane addition improvement is $232.7 million, representing a decrease from the initial estimate of $292.5 million.
Innovations
  • The TIFIA loan for the rural component met the criteria for TIFIA’s RPI, which offers loans for up to 49 percent of the project’s eligible costs (versus the traditional 33 percent), as well as fixed interest rates that are half the U.S. Treasury rate.
  • The I-81 Corridor Improvement Program is innovative, targeted improvements that will have a substantial effect on the safety and reliability of a critical portion of our nation’s infrastructure.
Related Links / Articles I-81 Corridor Improvement Program website
USDOT Press Release Announcing TIFIA Loans, December 12, 2022
I-81 Corridor TIFIA Loan Update, presentation by Laura Farmer, Chief Financial Officer, VDOT, September 20, 2022
Contact Laura Farmer, Chief Financial Officer, VDOT
