Implementation of Electronic Right-of-Way Management Systems Versus Paper Systems

4 Business Case Analysis

The information gathered from the literature search and case studies, combined with the research team's prior experience with implementing major information systems in state DOTs was used to develop a potential business case for establishing a case for implementing a new right-of-way management system for two development alternatives:

The intent of the business case analysis performed during this project is to provide an example business case analysis that can be adapted by a state DOT and customized to that agency's particular business environment to help establish the case for implementing a new right-of-way management system. The research team prepared the business case analysis in this report for a hypothetical mid-size state DOT. However, the methodology and templates utilized to perform the analysis are transferrable and adaptable for use by an agency contemplating investing in a new right-of-way management system.

Three of the agencies inter-viewed (Idaho Department of Transportation, Tennessee Department of Transportation, and the West Virginia Depart-ment of Transportation) were in the process of or had recently implemented COTS solutions.

A more detailed description of the two alternatives included in the analysis and the estimated cost of these alternatives are provided in the sections below.

4.1 Summary of Potential Development Alternatives

Alternative 1: COTS Solution

There are currently several COTS packages available in the marketplace that can provide some or most of the functionality required in an electronic right-of-way management system. Typically, many agencies find that no COTS solution completely meets all of their needs. Therefore, it is expected that some degree of customization of the COTS solution is usually required.

The potential advantage of a COTS solution with a limited number of custom extensions is that the initial cost to implement the COTS solution (the commercial software plus some customized add-ons) may be less expensive than developing a custom solution from scratch. However, this assumption is highly dependent on the cost of acquiring the COTS licenses. In addition, the COTS solution still requires design and development of any required interfaces with other agency systems and any custom programs needed to support conversion of data from existing systems. Another advantage of the COTS solution is that the agency, as long as it pays the annual software maintenance fees, will continue to receive product upgrades; whereas in a custom solution, the agency's IT staff or a contractor hired by the agency would be responsible for any upgrades or enhancements to the system.

Project Scope/Approach

Project activities for the implementation of a COTS solution can generally be divided into four phases: (1) Pre-implementation Planning phase, (2) System Implementation phase, (3) Project Management phase, and (4) Organizational Change Management phase. The Project Management and Organizational Change Management phases span the full lifecycle of the project. The suggested task/activities in each phase are described below.

Pre-implementation Planning Phase

The suggested task/activities in the Pre-implementation Planning phase are as follows:

System Implementation Phase

The suggested task/activities in the System Implementation phase are as follows:

Project Management Phase

The Project Management phase tasks are performed throughout the project, and the tasks include:

Organizational Change Management Phase

Organizational Change Management phase tasks are performed throughout the project, and the tasks include:

Exhibit 10 provides a representative timeline for the implementation of a COTS solution. The total project duration is 29 months from project initiation through post production support. This includes all the time required for procurement of the COTS solution and systems integration services.

For purposes of this analysis, we are showing functionality being deployed in a single implementation step. Alternatively, an agency could stage deployment of functionality by business function or major process-for example, implement the appraisal, negotiation, and acquisition functions first and other functions at a later point.

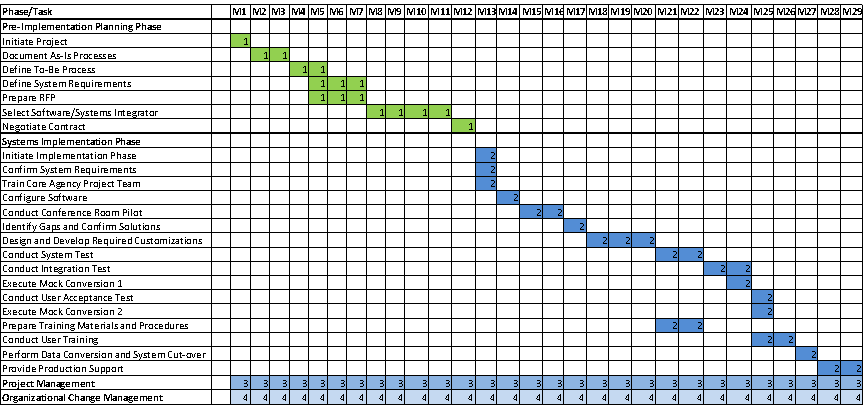

Exhibit 10: Potential Timeline for COTS Implementation

Pre-Implementation Planning Phase:, Initiate Project - Month 1, Document As-Is Processes - Months 2-3, Define To-Be Process - Months 4-5, Define System Requirements - Months 5-7, Prepare RFP - Months 5-7, Select Software/Systems Integrator - Months 8-11, Negotiate Contract - Month 12, Systems Implementation Phase:, Initiate Implementation Phase - Month 13, Confirm Requirements - Month 13, Train Core Agency Project Team - Month 13, Configure Software - Month 14, Conduct Conference Room Pilot - Months 15-16, Identify Gaps and Confirm Solutions - Month 17, Design and Develop Required Customizations - Months 18-20, Conduct System Test - Months 21-22, Conduct Integration Test - Months 23-24, Execute Mock Conversion 1 - Month 24, Conduct User Acceptance Test - Month 25, Execute Mock Conversion 2 - Month 25, Prepare Training Materials and Procedures - Months 21-22, Conduct User Training - Months 25-26, Perform Data Conversion and System Cut-over - Month 27, Provide Production Support - Months 28-29, Project Management: Months 1-29, Organizational Change Management: Months 1-29

Legend
1

Anticipated duration of Pre-implementation Planning, Project Management, and Organizational Change tasks

2

Anticipated duration of Systems Implementation tasks

3

Anticipated duration of Project Management tasks

4

Anticipated duration of Organizational Change Management

Cost Estimate

The cost estimate for a COTS solution hosted by the agency itself on-site or in a state-managed data center includes the following components:

Exhibit 11 outlines the proposed cost for the COTS alternative. The initial cost to implement the solution defined as the project cost and the first year of operations (Year 1 through Year 3) is $4.3 million. The seven-year total cost of ownership is $6.78 million.

Exhibit 11: Cost Estimate for COTS Implementation

Cost Element

Total

Year 1

Year 2

Year 3

Year 4

Year 5

Year 6

Year 7

Pre-implementation planning consultant

$250,000

$250,000



COTS software licenses

$500,000



$500,000



COTS software maintenance

$630,812



$100,000

$102,000

$104,040

$106,121

$108,243

$110,408

Systems integration services

$1,800,000



$1,080,000

$720,000



anaged services support

$365,000



$219,000

$146,000



Hardware and other technical infrastructure

$100,000



$100,000



Hardware and infrastructure maintenance

$92,730



$15,000

$15,300

$15,606

$15,918

$15,300

$15,606

Hardware refresh

$100,000



$100,000



Agency staff cost during project

$1,248,000

$312,000

$468,000

$468,000



Agency staff cost to support system ongoing

$936,000



$156,000

$156,000

$468,000

$156,000

Systems integration services for upgrade

$750,000



$750,000



Total Cost

$6,772,542

$562,000

$2,263,000

$1,524,300

$421,646

$378,039

$1,341,543

$282,014

Alternative 2: Custom Solution Developed by Systems Integrator

Several of the agencies inter-viewed had implemented custom solutions, some developed internally and some developed with the assistance of a third party systems integrator. Agencies with custom solutions included the Kentucky Transportation Cabinet, Maricopa County, Maryland State Highway Administration, and the Minnesota Department of Transportation.

The second alternative is the custom development of a new right-of-way information management system by an external systems integrator on behalf of the agency. The most obvious benefit of this alternative is the ability to custom build a solution that can specifically meet all of the agency's defined requirements. While this may seem desirable from an operational point of view, this approach typically takes longer given the time required to design, develop and implement the solution. The cost to build may also be higher depending on the difference between the development cost and the cost to purchase licenses for the COTS product. In addition, typically, we would consider a custom developed solution to be more risky from an information technology project delivery perspective. However, if an extensive amount of customization of the COTS solution is going to be required to meet an agency's requirements, it may become more practical and potentially even less costly and less risky to custom develop a solution rather than to purchase a COTS solution and then extensively customize the COTS solution.

Project Scope/Approach

Project activities for the development of a custom solution can generally be divided into two phases: Pre-implementation Planning and System Implementation. The activities under Pre-implementation Planning phase are similar to those under the COTS alternative, while the System Implementation phase involves much more custom development and system build out. There is also a Project Management phase and a Change Management phase which span the full lifecycle of the project. The suggested tasks/activities in each phase are outlined below.

Pre-implementation Planning Phase

Tasks during Pre-implementation Planning include:

System Implementation Phase

Tasks during System Implementation include:

Project Management Phase

The Project Management phase tasks are performed throughout the project and the tasks include:

Organizational Change Management Phase

Organizational Change Management phase tasks are performed throughout the project, and the tasks include:

Please note that an agency could elect to phase its implementation, in which case the System Implementation phase activities could be repeated for various functional areas-for example, Appraisal, Negotiation, and Acquisition are implemented in one phase, Relocation in a second phase, and then Property Management in a third phase at a later time.

In addition, these implementation tasks/activities are outlined following what is known as a "waterfall" methodology. An alternative approach would be to use an "Agile" methodology in which sections of a system are designed, developed, and unit tested in a series of short two- to three-week "sprints" and then sets of functionality developed across several sprints are tested and deployed into production in a series of software releases. Increasingly, more systems are being developed following an Agile methodology.

Exhibit 12 provides a representative timeline for the implementation of a COTS solution. The anticipated duration is slightly longer than the COTS alternative at 31 months from project initiation through post-production support.

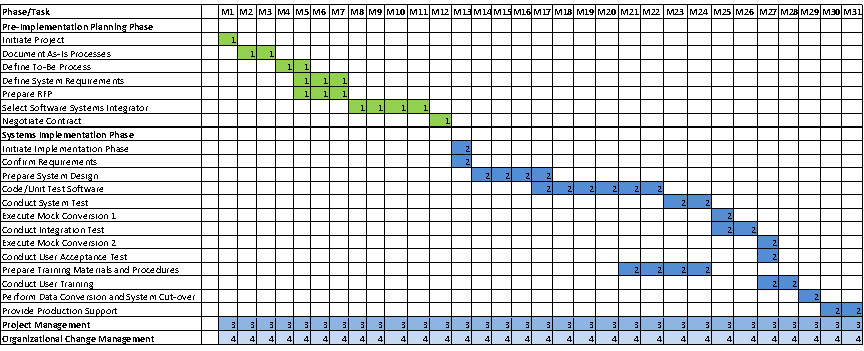

Exhibit 12: Potential Timeline for Custom Implementation

Pre-Implementation Planning Phase:, Initiate Project - Month 1, Document As-Is Processes - Months 2-3, Define To-Be Process - Months 4-5, Define System Requirements - Months 5-7, Prepare RFP - Months 5-7, Select Software/Systems Integrator - Months 8-11, Negotiate Contract - Month 12, Systems Implementation Phase:, Initiate Implementation Phase - Month 13, Confirm Requirements - Month 13, Prepare System Design - Months 14-17, Code/Unit Test Software - Months 17-22, Conduct System Test - Months 23-24, Execute Mock Conversion 1 - Month 25, Conduct Integration Test - Months 25-26, Execute Mock Conversion 2 - Month 27, Conduct User Acceptance Test - Month 27, Prepare Training Materials and Procedures - Months 21-24, Conduct User Training - Months 27-28, Perform Data Conversion and System Cut-over - Month 29, Provide Production Support - Months 30-31, Project Management: Months 1-31, Organizational Change Management: Months 1-31

Legend
1

Anticipated duration of Pre-implementation Planning, Project Management, and Organizational Change tasks

2

Anticipated duration of Systems Implementation tasks

3

Anticipated duration of Project Management tasks

4

Anticipated duration of Organizational Change Management

Cost Estimate

The cost estimate for a custom solution developed by a systems integrator and hosted by the agency includes the following components:

Exhibit 13 outlines the proposed cost for the custom development alternative. The initial cost to implement the solution defined as the project cost and the first year of operations (Year 1 through Year 3) is $4.6 million. The seven-year total cost of ownership is $5.9 million. The total cost of ownership is very similar to the total cost of ownership of the COTS alternative since while it costs more to develop the custom solution there are no reoccurring software licensing costs.

Exhibit 13: Cost Estimate for Custom Implementation

Cost Element

Total

Year 1

Year 2

Year 3

Year 4

Year 5

Year 6

Year 7

Pre-implementation planning consultant

$250,000

$250,000



Systems integration services

$2,800,000



$1,400,000

$1,400,000



Managed services support

$365,000



$146,000

$219,000



Hardware and other technical infrastructure

$100,000



$100,000



Hardware and infrastructure maintenance

$92,730



$15,000

$15,300

$15,606

$15,918

$15,300

$15,606

Hardware refresh

$100,000



$100,000



Agency staff cost during project

$1,248,000

$312,000

$468,000

$468,000



Agency staff cost to support system ongoing

$936,000



$234,000

$234,000

$234,000

$234,000

Total Cost

$5,891,730

$562,000

$1,983,000

$2,029,300

$468,606

$349,918

$249,300

$249,606

4.2 Benefits Analysis

This section analyzes the benefits to be realized from implementing a new electronic right-of-way management system. All the tangible and intangible benefits addressed in this section are based on implementing functionality to support core right-of-way business processes, including Appraisal, Acquisition, Negotiation, Relocation, and Property Management.

There are two key benefit terms that are used in this analysis:

Tangible Benefits

This subsection identifies anticipated tangible benefit streams. These tangible benefit streams have been established based on the experience of the research team and information obtained through the agency surveys and interviews.

Given the limited (almost non-existent) available research data on the actual benefits achieved from the implementation of a right-of-way management system in a transportation agency, we would recommend that the agency achieve a consensus on a set of benefit assumptions within their agency through the use of the "Delphi" method-that is consulting with a series of subject matter experts within their agency and potentially in other peer agencies on their opinion on what is a reasonable and conservative benefit stream and then use these agreed to benefit stream assumptions as the basis for constructing a business case. An agency can use the potential benefit streams documented in this report as a starting point for these collaborative discussions, adding or removing benefit streams or making adjustments in savings assumption based on their specific agency environments.

The research team suggests for agency consideration the following potential quantifiable benefit streams:

Exhibit 14 outlines these potential benefit streams on an annualized basis for a hypothetical transportation agency with a $400 million capital program, annual property acquisition cost of $40 million, and annual relocation costs of $4 million.

Exhibit 14: Potential Tangible Benefit Streams

Anticipated Benefit Stream

Estimated Benefit

Reinvestment opportunity based on a 1/2 % annual savings in capital program based on annual program size of $400 million

$2,000,000

Reinvestment opportunity resulting from a 2 % annual savings in the cost of parcel acquisitions based on annual parcel acquisition costs of $40 million

$800,000

Reinvestment opportunity resulting from a 3% annual savings in staff cost to deliver the right-of-way program (exclusive of property management) based on a total internal and external cost of $5 million

$150,000

Reinvestment opportunity resulting from a 2% annual savings in relocation program costs based on an annual relocation program size of $4 million

$80,000

Reinvestment opportunity resulting from a 2% annual savings in staff cost to perform property management activities based on a total internal and external cost of $400,000

$8,000

Total Estimated Annual Benefits

$3,038,000

Intangible Benefits

This sub-section outlines potential intangible benefits from the implementation of a new right-of-way management system. Potential intangible benefits include:

4.3 Return on Investment Analysis

This section documents the proposed return on investment analysis from the implementation of a new right-of-way management system for a transportation agency. For purposes of this analysis, the realization of the anticipated benefit stream has been staged as follows:

Exhibit 15 presents the return on investment analysis for the COTS alternative. It shows a cumulative net benefit of $1.58 million with a payback early in Year 7 or 4 years after the initial system implementation is complete. Exhibit 16 presents the return on investment analysis for the custom development alternative. It shows a total cumulative net benefit of $2.5 million with a payback in Year 7 or 4 years after the initial system implementation is complete.

Exhibit 15: Return on Investment Analysis and Payback for COTS Alternative

Cost Element

Total

Year 1

Year 2

Year 3

Year 4

Year 5

Year 6

Year 7

Reinvestment opportunity based on a 1/2 % annual savings for a capital program size of $400 million per year

$5,500,000



$500,000

$1,000,000

$2,000,000

$2,000,000

Reinvestment opportunity resulting from a 2% annual savings in the cost of parcel acquisitions for a $40 million per year acquisition program

$2,200,000



$200,000

$400,000

$800,000

$800,000

Reinvestment opportunity resulting from a 3% annual savings in internal and external staff cost to deliver the right-of-way program (exclusive of property management) based on an estimated staff cost of $5 million per year

$412,500



$37,500

$75,000

$150,000

$150,000

Reinvestment opportunity resulting from a 2% annual savings in relocation program cost based on an estimated program cost of $4 million

$220,000



$20,000

$40,000

$80,000

$80,000

Reinvestment opportunity resulting from a 2% annual savings in staff cost to perform property management activities based on an estimate staff cost of $400,000

$22,000



$2,000

$4,000

$8,000

$8,000

Total Estimated Benefits

$8,354,500

$0

$0

$0

$759,500

$1,519,000

$3,038,000

$3,038,000

Total Estimated Costs*

$6,772,542

$562,000

$2,263,000

$1,524,300

$421,646

$378,039

$1,341,543

$282,014

Estimated Net Benefit

$1,581,958

-$562,000

-$2,263,000

-$1,524,300

$337,854

$1,140,961

$1,696,457

$2,755,986

Cumulative Net Benefit



-$562,000

-$2,825,000

-$4,349,300

-$4,011,446

-$2,870,485

-$1,174,028

$1,581,958

*See Exhibit 11 for Total Estimated Costs

Exhibit 16: Return on Investment Analysis and Payback for Custom Alternative


Total

Year 1

Year 2

Year 3

Year 4

Year 5

Year 6

Year 7

Reinvestment opportunity based on a 1/2 % annual savings for a capital program size of $400 million per year

$5,500,000



$500,000

$1,000,000

$2,000,000

$2,000,000

Reinvestment opportunity resulting from a 2 % annual savings in the cost of parcel acquisitions for a $40 million per year acquisition program

$2,200,000



$200,000

$400,000

$800,000

$800,000

Reinvestment opportunity resulting from a 3% annual savings in internal and external staff cost to deliver the right-of-way program (exclusive of property management) based on an estimated staff cost of $5 million

$412,500



$37,500

$75,000

$150,000

$150,000

Reinvestment opportunity resulting from a 2% annual savings in relocation program cost based on an estimated program cost of $4 million

$220,000



$20,000

$40,000

$80,000

$80,000

Reinvestment opportunity resulting from a 2% annual savings in staff cost to perform property management activities based on an estimated staff cost of $400,000

$22,000



$2,000

$4,000

$8,000

$8,000

Total Estimated Benefits

$8,354,500

$0

$0

$0

$759,500

$1,519,000

$3,038,000

$3,038,000

Total Estimated Costs*

$5,891,730

$562,000

$1,983,000

$2,029,300

$468,606

$349,918

$249,300

$249,606

Estimated Net Benefit

$2,462,770

-$562,000

-$1,983,000

-$2,029,300

$290,894

$1,169,082

$2,788,700

$2,788,394

Cumulative Net Benefit



-$562,000

-$2,545,000

-$4,574,300

-$4,283,406

-$3,114,324

-$325,624

$2,462,770

*See Exhibit 13 for Total Estimated Costs
